TrialConnx https://trialconnx.com/ Accelerate Your Study: Pre-Award to Startup Fri, 28 Aug 2026 03:51:48 +0000 en-US hourly 1 https://wordpress.org/?v=7.1 https://trialconnx.com/wp-content/uploads/2024/09/tco-no-text-1.svg TrialConnx https://trialconnx.com/ 32 32 Where Study Activation Time Actually Goes, and Why Your Timeline Doesn’t Show It https://trialconnx.com/where-study-activation-time-goes/ Fri, 28 Aug 2026 00:24:02 +0000 https://trialconnx.com/?p=2221 Activation is reported end to end, which can hide the waiting between stages. What 308 site activations show, and how to find your own handoff gaps.

The post Where Study Activation Time Actually Goes, and Why Your Timeline Doesn’t Show It appeared first on TrialConnx.

]]>

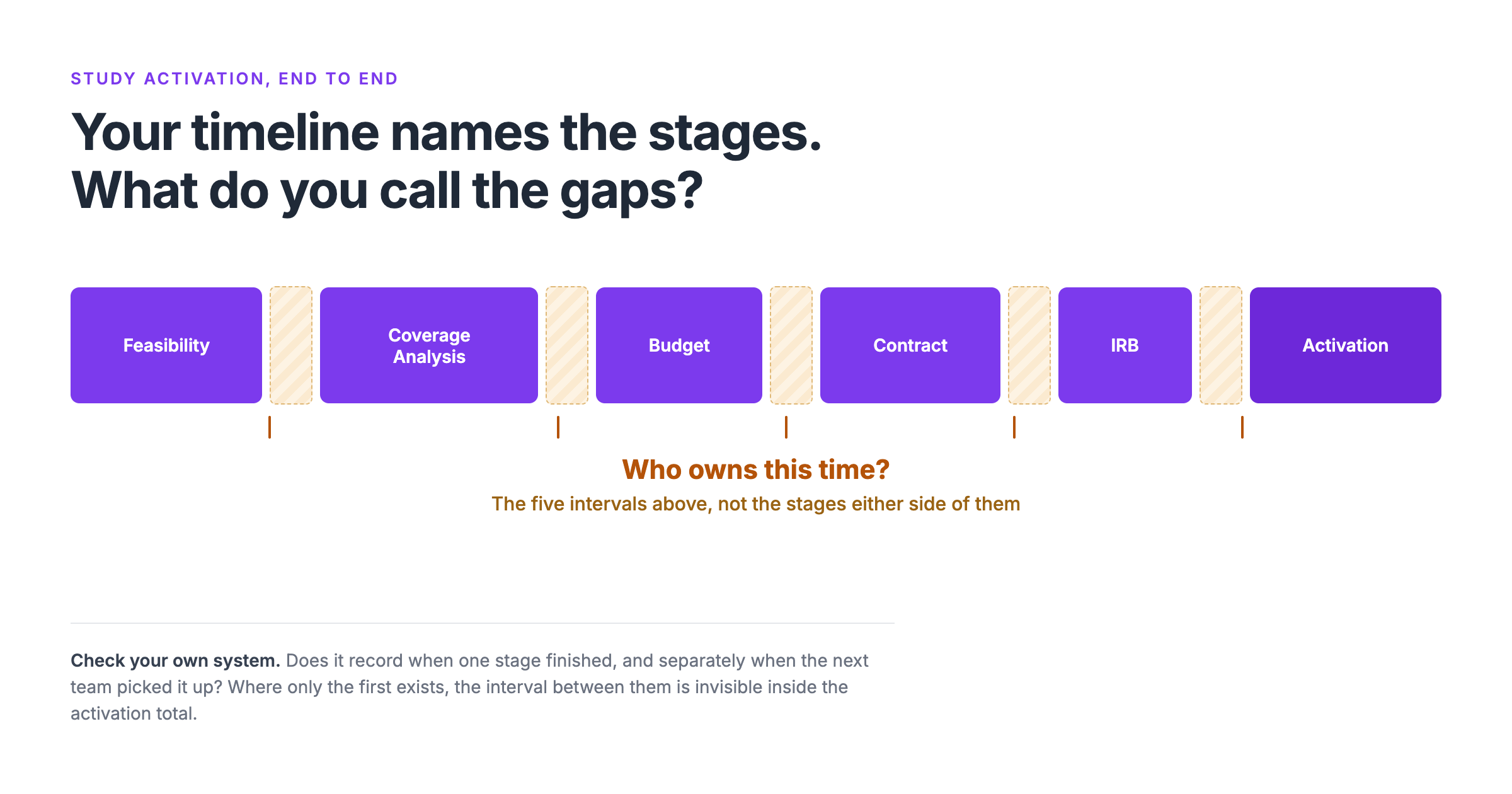

Study activation timeline showing six named stages with deliberately marked gaps between them, asking who owns the time in those intervals
⚡

The short version

An end-to-end activation report can hide how long studies spend waiting between activities rather than inside them. We call those the handoff gaps: the waiting in the reviews and approvals between one stage and the next. If your system records when a stage finishes but not when the next team picks it up, that interval is invisible inside your activation total. In an exploratory, nonrandomized sample of 308 activations across 13 different investigator-initiated multicenter trials, the panel running all three elements of a connected startup package activated in a median of 133 days, while the panel without the standardized workflow ran to 277. Record two dates at each handoff, when one stage finished and when the next picked it up, reconstructing them for your last 10 activations if the records exist and otherwise capturing them going forward. That first diagnostic slice will show whether those intervals are worth investigating in your own process.

Three startup models, a 144-day spread

You can read a sponsor’s timeline expectations. You can hear at a conference that a site across town opened a study in six weeks. What you cannot do is watch how they did it: which team touched the budget first, who noticed the contract had stalled, whether anyone was tracking the whole path or whether four people each did their part and the order happened to work out.

One published analysis comes close to that comparison. Researchers followed 308 site activations across 13 multicenter trials between 2019 and 2024, all moving through the same coordinating structure, and recorded what startup support each one had (Hillery et al., 2025).

The trials using all three elements activated in a median of 133 days. The trials without the standardized lean workflow ran to a median of 277. Both of the slower panels still had two of the three elements, so this is not a comparison of supported against unsupported.

Before that gap does any work, it needs its limits stated. These were 13 different trials, not randomized arms. The intervention combination was chosen at trial level by trial leadership, and the groups differ in therapeutic area, network, start date and site cohort. Two COVID-19 treatment trials sit in the fastest group. The authors call the work exploratory and list trial design, personnel changes, approvals and technology problems among the things that could move these numbers.

So this is an association between ways of running startup, not proof that one causes the other.

What separated the groups

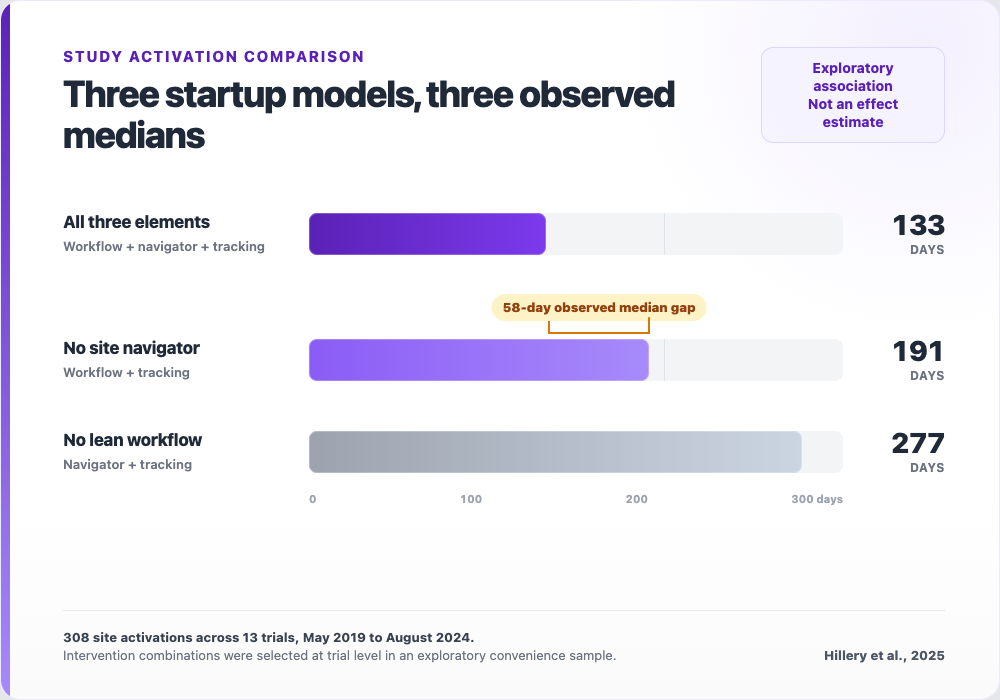

Median site activation by startup model: 133 days with all three elements, 191 days without a site navigator, 277 days without a lean workflow, from 308 site activations
Startup model Median activation Range of trial medians Sites
All three ASU elements 133 days 56 to 170 160
No site navigator 191 days 149 to 216 52
No lean workflow 277 days 198 to 320 96
144 days
Spread between the fastest and slowest startup model
58 days
Observed gap between the full package and no navigator
31% vs 0%
Activated within 90 days, full package against the rest

Medians are of trial medians within each panel, not of individual site activation times. Intervention combinations were selected at trial level in an exploratory convenience sample of 13 trials (Hillery et al., 2025).

The three elements were a standardized workflow with benchmarks set in advance, an electronic tracking system, and dedicated site navigators who checked in with each site weekly.

In the all-three-elements panel, 31% of site activations completed within 90 days. In the other two panels, none did.

The observed median gap between the full package and the no-navigator group was 58 days. Read that as a subtraction and nothing more. Tracking was present in all three groups, so this study cannot tell you what tracking contributed, and the combinations were assigned by trial rather than chosen site by site.

What the result does support is narrower and still useful: running startup as a connected workflow, with someone whose job is to move studies through it, is worth testing at your own site.

The interval between the timestamps

The practical problem sits in what each stage leaves behind.

IRB review has a name, a committee, a submission date and an approval letter. Contract execution has a signature page. Regulatory has a binder. Each of those finishes, and finishing leaves a record.

The period where coverage analysis becomes a budget, and the budget becomes a contract, is not one activity. It is several teams’ work overlapping in an order that changes from study to study. Check your own system, whether that is a CTMS or a spreadsheet: does it record when a stage completed, and separately when the next stage picked it up? Where only the first exists, the difference between them cannot be seen at all.

The interval with no record

A stage completing produces a record. A stage being picked up may not. That asymmetry is
why the waiting between teams can be real and large and still not appear anywhere in an
activation report, however carefully that report is built.

If that interval has no name at your site, it is harder to give it an owner. If it has no owner, it is harder to measure. And what is not measured is difficult to improve, however well the individual stages are running.

That chain is a management heuristic rather than a law, but it is cheap to test.

A worked example, hypothetically

To make the shape concrete, consider a protocol amendment that adds an imaging timepoint. What follows is illustrative rather than observed, and how much of it applies depends on your protocol, billing status and staffing model.

If the imaging changes what can be billed, the coverage analysis has to be revisited. Budget work that depends on that classification may then need reworking, and contract terms that depend on the budget may follow. Depending on the change, regulatory and consent documents may also need updating.

Say each team involved completes its own part in a few days.

The question worth asking is who is tracking the elapsed time across all of them.

If the answer at your site is a recurring meeting, that is worth sitting with. A meeting reports status. Reporting that contracts is waiting on budget does not move the study, and the interval between those two teams belongs to neither of them.

None of this implies anyone is failing. It describes a coordination limit, and coordination limits do not respond to working harder. They tend to get worse as study volume rises.

The chain running underneath it

The handoff gaps are not random. They sit at specific joins, and the joins are where one team’s output has to be good enough for the next team to start.

The joins, rather than the activities on either side of them.

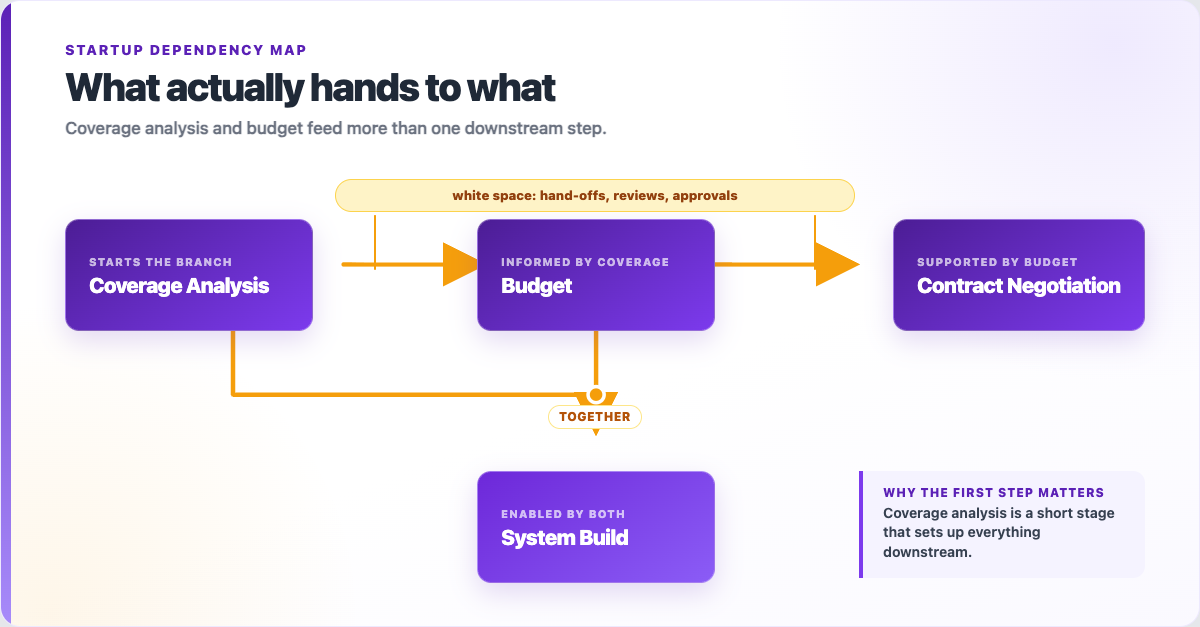

Dependency map showing coverage analysis informing the budget, the budget supporting contract negotiation, and coverage analysis and budget together enabling the system build

The order runs like this. Medicare coverage analysis informs the budget, because you cannot price what you have not classified. The budget supports contract negotiation. And coverage analysis and budget together enable the trial management system build. Coverage analysis takes a small share of the overall timeline and shapes how smoothly everything after it runs, which is a poor trade if it is the stage your team squeezes when the calendar is tight (WCG, 2026).

Worth saying plainly: not every pause is waste. Many are approvals doing their job. The ones worth examining are the pauses that persist because they always have.

And nothing in the published evidence quantifies these gaps or shows they are the largest component of activation time. The Hillery analysis measured total activation, not handoff latency. That the gaps are where most of the time goes is a hypothesis this article is putting to you, not a finding any source establishes. You can start testing that hypothesis with two dates at each handoff.

The problem is not newly discovered

A team at the University of South Florida mapped their activation process across 78 trials and reported that, contrary to expectation, IRB approval was not the longest step. Contract negotiation and budget negotiation were, at averages of 54.9 and 46.3 days (Martinez et al., 2016). A separate analysis of 689 non-cancer trials at the University of Kansas Medical Center found the stage covering regulatory documents, budget and contract ran to a median of 98 days, against 55 days for IRB review (Cernik et al., 2021).

Both are old, both are single institutions, and the Kansas window closes in 2018, before the single-IRB mandate and before the pandemic changed how sites work. Neither is a benchmark for your site today.

Their value is that they were published, available, and pointing at contracts and budgets more than a decade ago. Startup is still described across the industry as a persistent challenge.

Our reading is that a problem documented this long is not waiting on more evidence.

Not sure where your days are going?

We map activation stage by stage across pre-award, IRB, contracts and go-live, and show you the intervals your report does not separate out.

What some centers have built

Two academic medical centers whose current service pages describe this directly are UCSF and Duke. Both centralize some combination of coverage analysis, budgeting, contracting, system build and startup navigation.

UCSF’s office covers coverage analysis, budget development and negotiation, and protocol calendar build. Duke’s Office of Clinical Research, created in 2012 when the school restructured central research support, provides a broad set of study services.

Their service lists are worth reading against your own process, with one caution: an office existing does not tell you why it was created, and these offices differ from each other. Duke’s current materials include IRB-related review and system support, so this is not a pattern of centralizing everything except IRB.

What is common is that each pulled work which had been distributed across functions into a single place with a single address. The site navigators in the Hillery analysis are a smaller version of the same move, carried by one person rather than a department.

If you cannot fund a central office

Many sites cannot, and pointing at Duke is not useful advice for a site running eight studies with six coordinators.

The transferable part is the ownership rather than the office, and ownership costs less than headcount.

Give the interval a name your team uses out loud. It does not matter what you call it. A thing that can be referred to can appear on an agenda.

Give it one owner rather than a committee. Someone whose explicit responsibility is elapsed time, as distinct from the people responsible for each task. This can be part of an existing role.

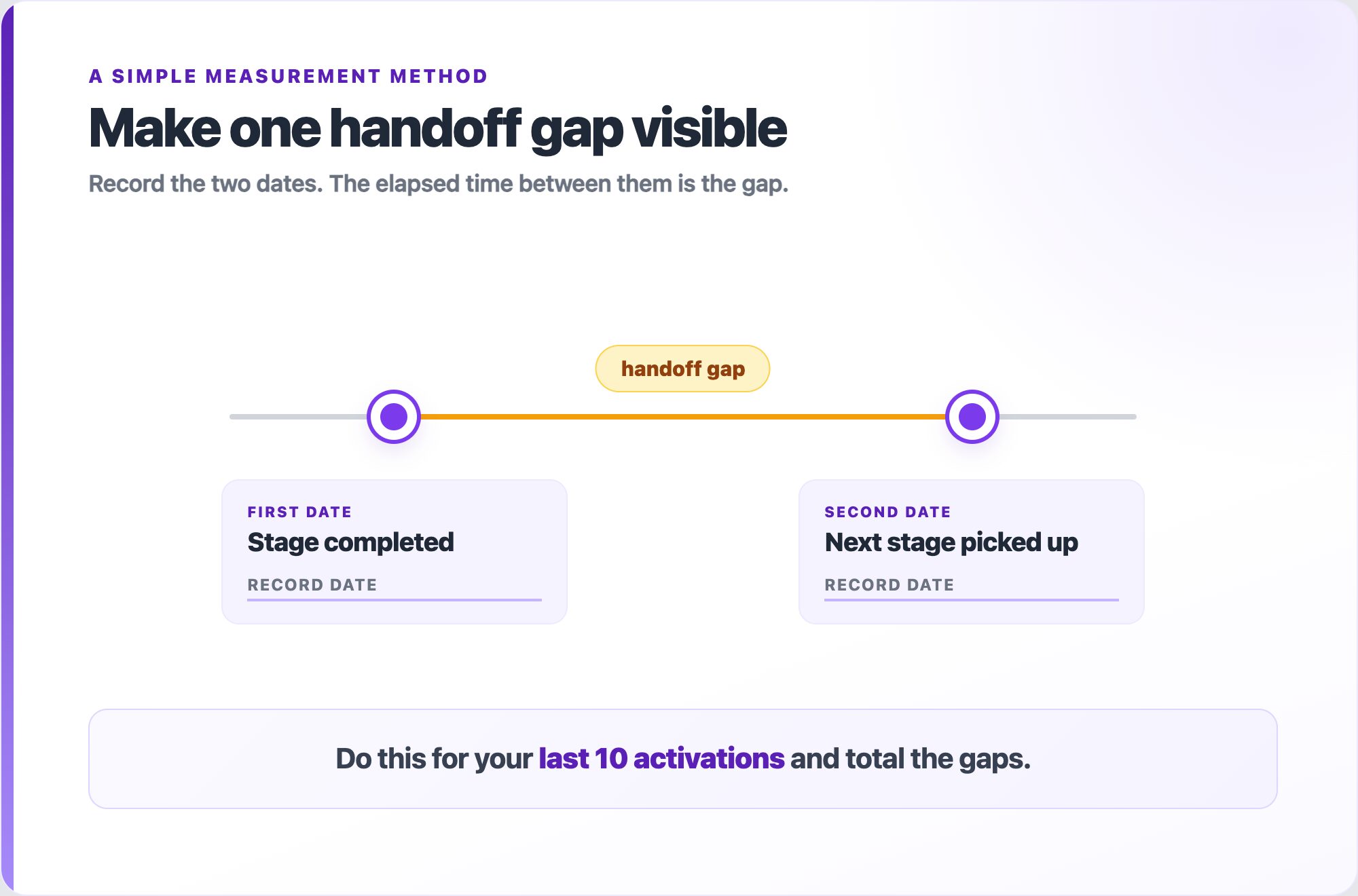

A method for measuring one handoff gap: record the date a stage completed and the date the next stage was picked up, and the span between them is the handoff gap

Record two dates at each handoff. When a stage finished, and when the next one picked it up. The second is the one to check for. If both dates exist in your records, 10 recent activations are a useful first diagnostic slice rather than a statistically sound sample, which is the point. If the pickup date was never recorded, use your next 10 instead.

Look for pauses that exist by habit. A review that has never once changed an outcome, or a document that waits for a weekly meeting because it always has. Those cost nothing to remove.

Where policy allows, start dependent work in parallel. Worth checking whether a sequence you treat as fixed is actually required, or just the order things arrived in.

Five questions about your own activation

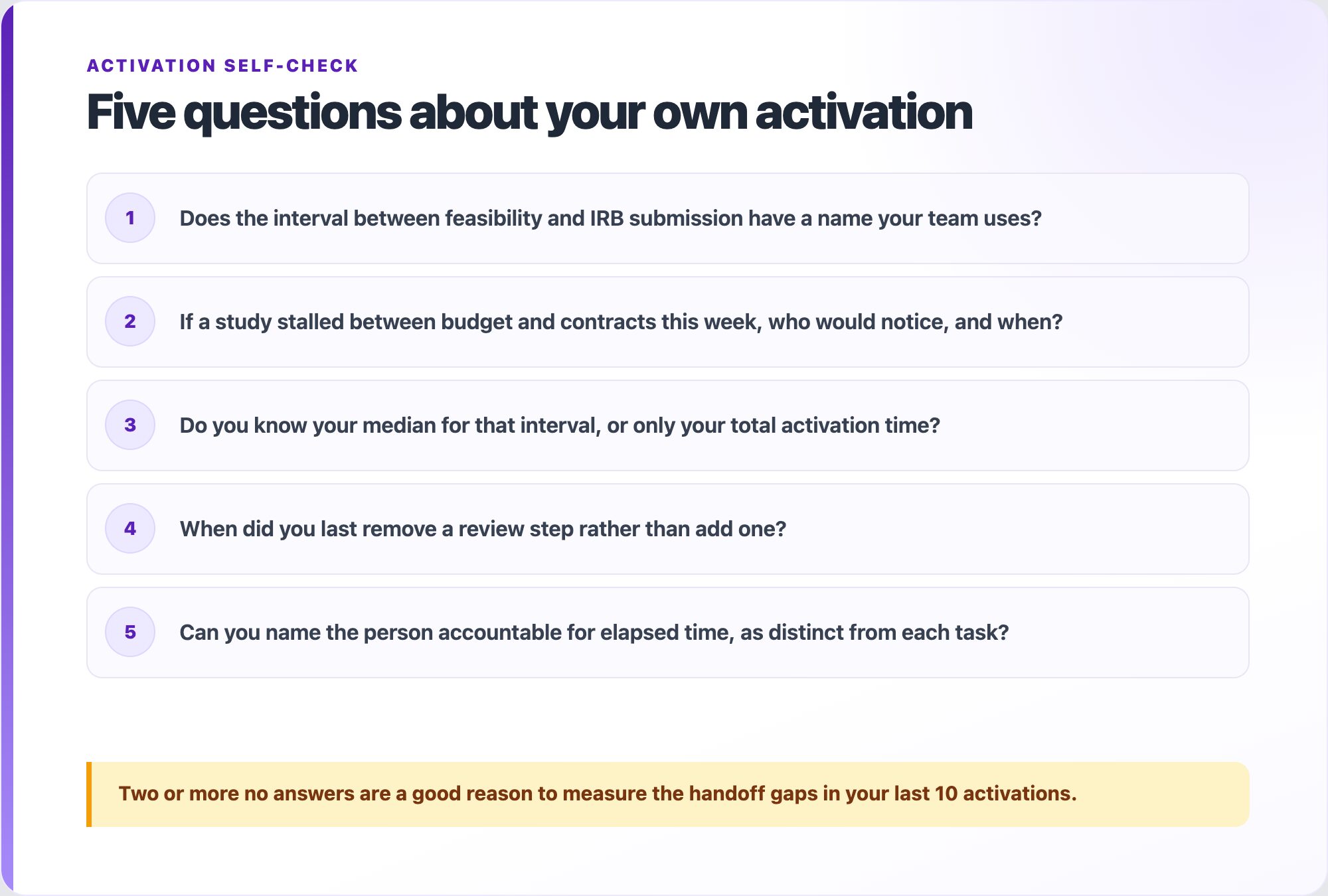

Five questions about your own activation, covering naming the interval, who notices a stall, whether you know your median, removing review steps, and who owns elapsed time
1

Does the interval between feasibility and IRB submission have a name your team uses?

2

If a study stalled between budget and contracts this week, who would notice, and when?

3

Do you know your median for that interval, or only your total activation time?

4

When did you last remove a review step rather than add one?

5

Can you name the person accountable for elapsed time, as distinct from each task?

Two or more no answers are a good reason to start measuring handoff gaps.

The takeaway

Key Takeaway: A stage your timeline has no field for is harder to manage. You do not need a central office to change that. You need a name for the interval, one owner for the elapsed time, and two dates at every handoff.

The evidence does not prove that the gaps are where most activation time goes. What it shows is that trials run as a connected workflow, with someone responsible for moving studies through, finished startup faster in one large exploratory analysis, and that two independent institutions found contracts and budgets rather than IRB at the top of their delay lists more than a decade ago.

Start with two dates

If both dates can be reconstructed from your existing records, audit your last 10 activations: mark the date each stage finished and the date the next one picked it up, then total the gaps. If the pickup date was never recorded, start capturing both dates on your next 10. Either way, that total is not in an activation report that shows only the end-to-end figure.

If you would rather walk through it with us, that is what the 20-minute walkthrough is for. We map where the days are going across pre-award, IRB, contracts and activation.

Sources

  1. Hillery S, et al. “Accelerating start-up cycles in investigator-initiated multicenter clinical trials.” Journal of Clinical and Translational Science. 2025;9(1):e249. doi:10.1017/cts.2025.10180
  2. WCG. 2026 Clinical Research Trends and Insights Report. January 2026.
  3. Martinez DA, et al. “Activating clinical trials: a process improvement approach.” Trials. 2016;17:106. doi:10.1186/s13063-016-1227-2
  4. Cernik C, et al. “Non-cancer clinical trials start-up metrics at an academic medical center.” Contemporary Clinical Trials Communications. 2021;22:100774. doi:10.1016/j.conctc.2021.100774
  5. UCSF Office of Clinical Trial Activation; Duke Office of Clinical Research. Institutional service pages.

The post Where Study Activation Time Actually Goes, and Why Your Timeline Doesn’t Show It appeared first on TrialConnx.

]]>
One Amendment, Six Weeks Gone: A Study Startup Saga https://trialconnx.com/pre-activation-amendments-study-startup/ Wed, 01 Jul 2026 13:41:48 +0000 https://trialconnx.com/?p=2164 Pre-activation protocol amendments quietly add weeks to trial activation. The fix is not heroics. It is treating startup as its own discipline, with three capabilities: shared readiness, shared language, and a shared clock.

The post One Amendment, Six Weeks Gone: A Study Startup Saga appeared first on TrialConnx.

]]>

Prefer the visual version?  View the slide deck ↓

⚡

The short version

Pre-activation protocol amendments are one of the largest and least measured sources of delay in trial activation. They most often add 4 to 6 weeks, and nearly 1 in 5 sites report 10 weeks or more (AACI, 2026). The delay is rarely the science. It is coordination: document readiness, version control, and turnaround between sites, sponsors, CROs, and IRBs. The fix reduces to three capabilities a site can build for itself: shared readiness, shared language, and a shared clock. The harder truth underneath: those capabilities get difficult to hold across concurrent startups unless something holds the state.

Study startup has quietly become its own discipline. The work of getting a trial ready to open, the regulatory packages, the budgets, the contracts, the system builds, has outgrown the informal way most sites still run it. Nothing exposes that gap faster than a protocol amendment that lands after the startup package goes out but before the site opens to accrual.

The amendment itself is often small. The damage is in everything that has to re-sync around it. The numbers bear it out: most sites handle 3 to 10 pre-activation amendments a month, and those amendments most often add 4 to 6 weeks to activation (AACI, 2026). The symptom is a delay. The cause is that startup has become a coordination problem most sites have no system for.

First, the proof

The data is blunt enough to settle the “is this a real problem” question in one line.

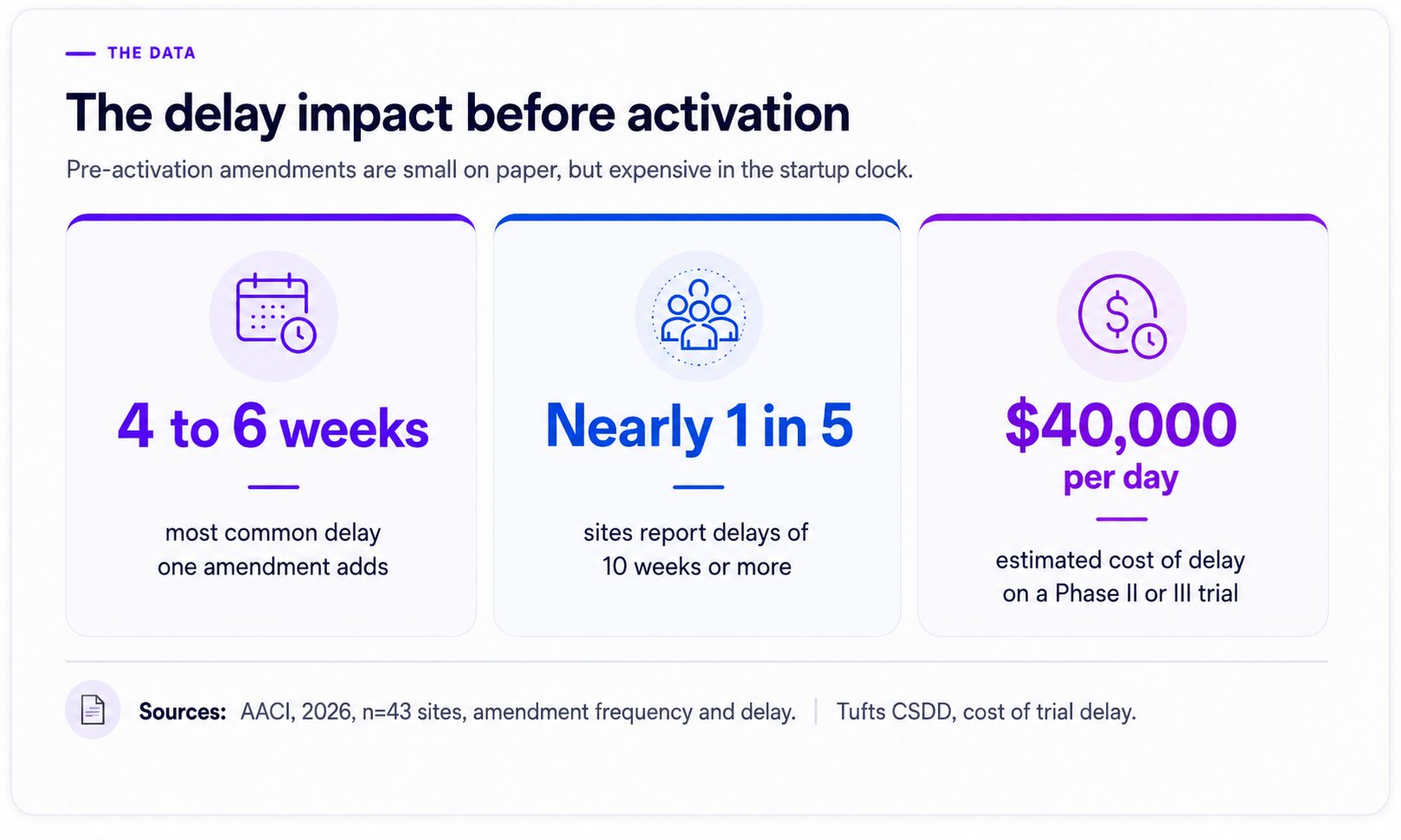

The delay impact before activation: amendments most often add 4 to 6 weeks, nearly 1 in 5 sites report 10 or more weeks, and a day of delay costs about $40,000 on a Phase II or III trial

A trial that has not opened yet, that has not screened a single patient, is already absorbing that. And the cause is rarely the science. The damage is in everything that has to re-sync around a change, with no shared way to manage the re-syncing. That pattern, where the coordination load rather than the clinical work sets the pace, is the same one we traced in When Study Startup Becomes a Bottleneck.

The fix is three capabilities

The emerging guidance on amendments runs to a list of recommendations, and a list is how good ideas stall in a startup queue. Distilled, it comes down to three capabilities. Build these and the rest follow.

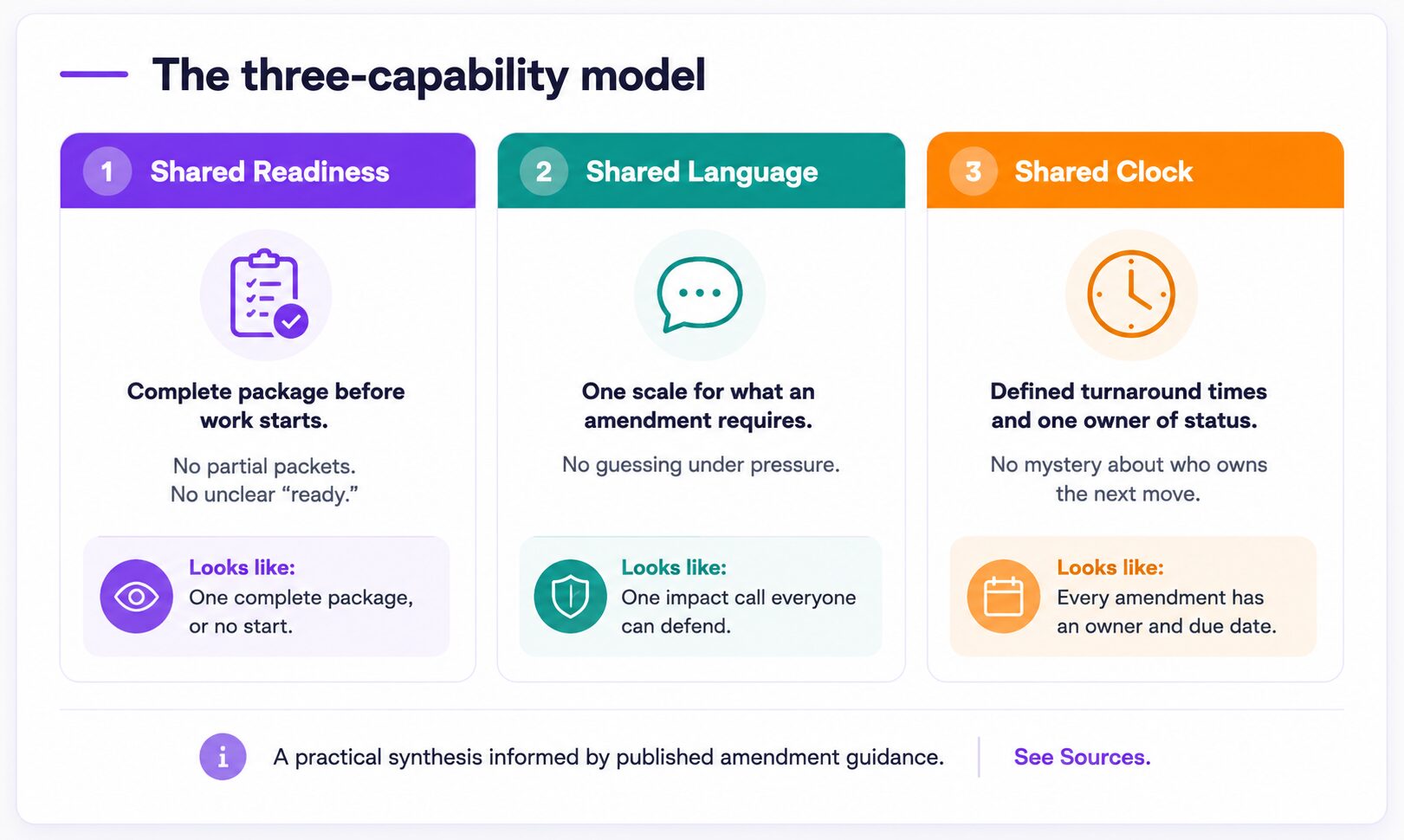

The three-capability model: Shared Readiness, Shared Language, and Shared Clock, each with a definition and a looks-like outcome

Shared Readiness: a definition of “ready,” not a trickle of documents

Readiness sounds obvious until you watch it fail. A site receives the protocol one day, the budget grid a few days later, the consent template the following week, and a “minor” lab manual change after that. Each arrival restarts a piece of the build. The fix is a complete, internally consistent amendment package with a coversheet that lists every changed document and version date, and an explicit “no change” where a document was not touched. The site does not start the affected work until the package is whole. That single rule removes most of the rework that quietly eats the calendar.

Shared Language: one scale everyone reads the same way

When a site, a sponsor, and an IRB each describe an amendment in their own terms, every handoff carries a translation cost. A shared impact scale removes it. The same change gets the same label, and the label tells everyone what may proceed. This is the capability a site can adopt entirely on its own, and it is where consent and version control go wrong most often, a theme we covered in Why Site IRB Submissions Fail.

Shared Clock: turnaround commitments and one owner of status

The last capability is the one most sites never formalize. Concrete windows work: acknowledge a complete package within 2 business days, return a feasibility read within 5, answer blocking questions within 5, and escalate when a window slips (AACI, 2026). Paired with a single named owner of amendment status, the question “can we start, or do we wait” stops bouncing between inboxes and gets a reliable answer.

Rank amendments by activation impact

The middle capability is the one most teams can adopt this week, with no one’s permission. The tool is a single ladder for an amendment’s impact, so “is this a big deal” stops being a fresh argument every time. Here is the simple version we use with sites.

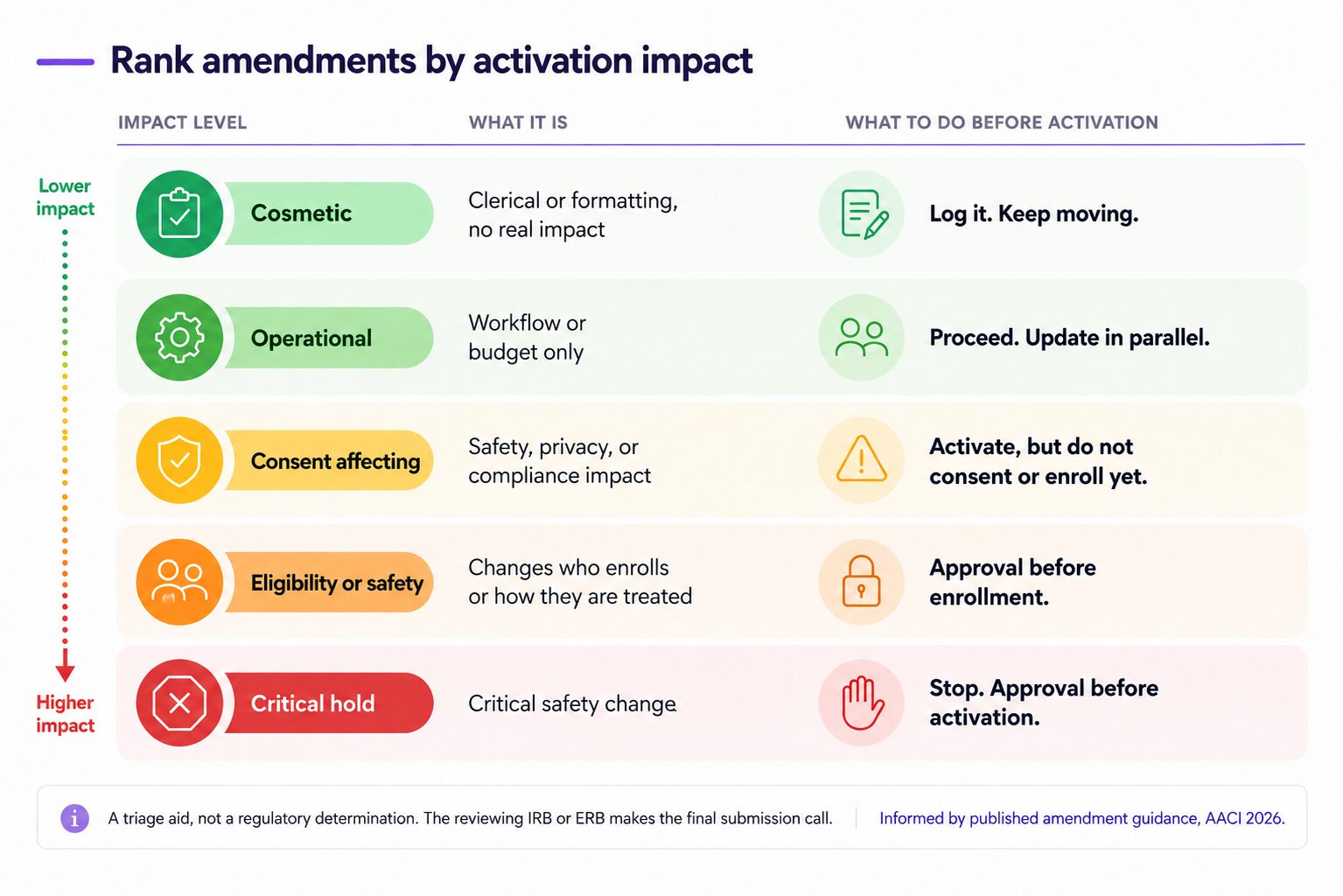

Impact ladder for ranking amendments by activation impact: Cosmetic, Operational, Consent affecting, Eligibility or safety, and Critical hold, from lower to higher impact, each with what it is and what to do before activation

A site can adopt a ladder like this internally without waiting on partners. A shared scale turns a recurring judgment call into a fast, defensible one, and that changes how a startup queue moves.

Where this breaks at scale

Picture a startup coordinator on a Tuesday morning. Four studies sit open on her desk, all in startup. Study ABC-201 just landed its third protocol version, and she is no longer certain the consent she sent to the IRB last week is the current one. Study XYZ-105 has a budget amendment stuck in legal, and the sponsor is asking why activation has slipped. Two more are waiting on a feasibility read she has not had time to write.

Nothing on her desk is hard. Every item is a small, reasonable decision. The problem is that no single place tells her which version is live on which study, what is ready, and who owes the next move. So she spends the morning reconstructing that picture from email threads instead of clearing work. Multiply that one morning across a quarter, and you get the survey numbers.

Here is the part no checklist solves. Readiness, language, and a clock are agreements. Agreements work on one study. They get harder to sustain the moment a site is running three, four, five startups at once, each with its own document versions, its own pending amendments, its own clock.

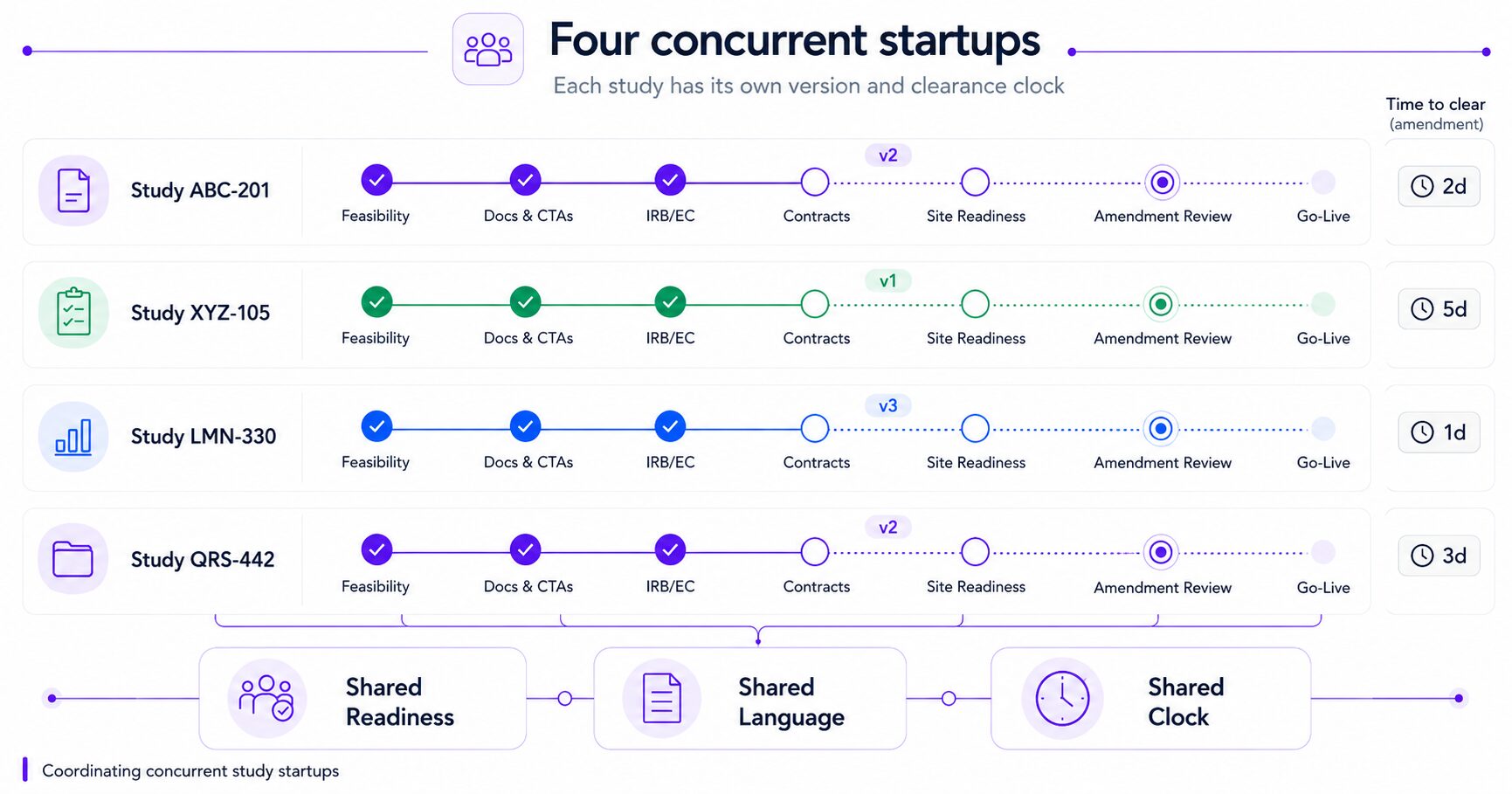

Four concurrent study startups, each with its own version tags and amendment-clearance clock, resolving into shared readiness, shared language, and a shared clock
Four concurrent startups, each with its own version and clearance clock. The capabilities only hold when something holds the state across all of them.

That is the real reason startup has become its own discipline. Not because the steps are hard, but because holding the state across many parallel startups is more than a spreadsheet or a calendar reminder can hold. The capabilities only stick when something holds the state for everyone: which version is live, what is ready, who owes the next move, and how long it has been waiting. It is also why a system built to run an open trial does not cover this work, the gap we walked through in Why Your CTMS Isn’t Built for Study Startup.

Put a rough number on it. On a Phase II or III trial, a single day of delay runs about $40,000 (Tufts CSDD). So two weeks of amendment churn, the low end of what most sites report, works out to roughly half a million dollars of delay cost on a single study by that benchmark, before a patient is ever enrolled. And money is the smaller cost. A site that opens two months behind its peers loses enrollment share on competitive trials, and sponsors remember which sites activate fast. The weeks lost before a trial opens quietly shape which trials a site is offered next.

A quick self-check

Can you answer these about your last startup?

  • How many pre-activation amendments did it take?
  • How many weeks did those amendments add to activation?
  • At any given moment, did everyone know which protocol version was live?
  • Was there a single person who owned amendment status?
  • Could the team say, in one word, whether each amendment was minor or blocking?

If you cannot answer two or more of these, the delay is most likely already there. It is just unmeasured.

How a site digs out

The way out is not a transformation program, and our coordinator does not need to wait for one. It is three moves, in order, and the first needs no one’s permission.

First, she counts. For each startup, how many pre-activation amendments arrived, and how many weeks each one added. It takes an afternoon with old emails, and it changes the conversation, because most sites have never put a number on this. You cannot manage a delay you have never measured. Where to begin: the six startup metrics worth tracking.

Then, the team adopts one language. The impact ladder goes up on the wall, and “is this a big deal” stops being a fresh argument on every amendment. A junior coordinator can label a change cosmetic or critical and defend the call, while a named owner on each startup keeps a running list of which version is live. None of this needs a sponsor’s sign-off. It is simply how the site talks to itself.

Finally, the state stops living in her memory. The first two moves get a site surprisingly far, but they share a ceiling, the same one she hit on Tuesday morning. Across many concurrent startups, which version is live, what is ready, and who owes the next move is more than any one person or spreadsheet can hold reliably. The capabilities only stick when something holds that state for the whole team, visible to everyone at once.

You know it is working when the questions change. “Which version is live?” gives way to a few numbers anyone can see: amendments per startup, weeks added, time to clear by impact level, and how often a package arrives complete the first time. When those are the questions a site is asking, the discipline has taken hold.

How amendments should be handled

The three moves get a site surprisingly far, but doing this properly, across a whole portfolio, means letting a system carry what a person cannot. A good one does a specific job. Across every startup a site is running, it keeps one current answer, visible to everyone, to four questions: which protocol version is live, what is ready to work, who owns the next move, and how long it has been waiting. It carries the impact ladder, so a labeled amendment routes itself instead of waiting for a meeting. It holds the clock, so a slipped turnaround surfaces on its own. And it keeps a clean version trail, so the current document is never in question.

The real gains come from doing this once, shared. When the same readiness definition, the same impact labels, and the same clock are visible to the site and to its sponsors, CROs, and IRBs, the coordination cost drops on every side, not just inside the site. That is the difference between a site that survives amendments and one that barely notices them.

The takeaway

The white paper measured a delay. What it points to is a discipline coming into focus. Study startup is no longer a set of tasks one capable person can carry in their head across a few studies. It is a managed process with its own readiness, its own language, and its own clock. The sites that treat it that way will clear amendments while everyone else is still deciding whether the latest version is the one to build against.

If you want a number of your own, start with your last three startups. Count the amendments. Count the weeks. That single exercise tends to change the conversation.

Frequently asked questions

What is a pre-activation protocol amendment?

A pre-activation protocol amendment is a change to a study protocol that arrives after the startup package has gone to the site but before the site opens to accrual. Because the materials are already in motion, the change usually means rework rather than first-pass build.

Why do small amendments cause such large activation delays?

The amendment itself is often minor. The delay comes from everything that has to re-sync around it: consent versions, budgets, contracts, and system builds, across the site, the sponsor or CRO, and the IRB, with no shared owner of status. AACI found amendments most often add 4 to 6 weeks, and nearly 1 in 5 sites reported 10 weeks or more.

How should a site rank an amendment’s impact before activation?

Sort each amendment by what it actually requires, from cosmetic changes that affect no one, through operational and consent-affecting changes, up to critical safety changes that must hold activation until approved. A shared ladder lets a team make a fast, defensible call instead of debating each amendment from scratch. This practice is informed by published amendment guidance (AACI, 2026); the reviewing IRB or ERB makes the final submission determination.

Can a site activate a trial under a prior protocol version?

AACI recommends allowing it when later amendments are not safety critical. Where the reviewing IRB allows, a site may activate under a previously approved version and continue startup work while the amendment is under review. Final determination of IRB submission requirements rests with the reviewing IRB or ERB.

How can a site measure the impact of pre-activation amendments?

Start by counting, for each startup, how many pre-activation amendments arrived and how many weeks each one added to activation. Most sites have never tracked this, and the number alone usually reframes the conversation.

How is study startup different from a CTMS?

A CTMS is built to run an open trial: patient screening and enrollment, visits, and financial milestones. Study startup is the pre-activation work of getting a trial ready to open, and the AACI findings show it has its own readiness, language, and turnaround needs that systems built for the open trial were not designed to hold.

What three capabilities does a site need to manage amendments?

Three capabilities cover it: shared readiness (a clear definition of a complete package before work starts), shared language (one impact ladder everyone reads the same way), and a shared clock (defined turnaround times and a single owner of status). They distill the practical guidance emerging from cross-stakeholder work on amendments (AACI, 2026).

How many pre-activation amendments is normal for a site?

Most research sites handle 3 to 10 per month (AACI, 2026). Volume by itself is not the core problem. The delay comes from having no shared way to triage and track amendments across concurrent startups.

Who should own amendment status at a site?

Name one person per startup as the owner of amendment status, responsible for knowing which version is live and what is ready. A single named owner clears work faster than a committee, because there is never a question of whose move it is.

Does fixing amendment delays require new software?

Not to begin. Counting amendments and adopting a shared impact ladder with a named owner need no tools. The harder part, holding shared state across many concurrent startups, is where a dedicated study startup system helps, because email and spreadsheets do not hold shared state reliably.

Visual Summary

Get the impact ladder and the key numbers from this post in a swipeable slide deck. Download it or share it with your team.

Skip to PDF content

Sources

  • Association of American Cancer Institutes (AACI). Accelerating Clinical Trial Activation: a Collaborative Framework for Managing Pre-Activation Protocol Amendments. June 2026. PDF.
  • Smith, Z. P., DiMasi, J. A., and Getz, K. A. (2024). New Estimates on the Cost of a Delay Day in Drug Development. Therapeutic Innovation and Regulatory Science, 58(5), 855-862. Source of the $40,000 per day cost-of-delay figure (authors affiliated with Tufts CSDD).

TrialConnx is a study startup platform that helps research sites manage activation work from pre-award through open to accrual, with the shared state these capabilities need. See how at trialconnx.com.

The post One Amendment, Six Weeks Gone: A Study Startup Saga appeared first on TrialConnx.

]]>
How Specialized Study Startup Tools Work Alongside OnCore, Medidata, and Veeva https://trialconnx.com/how-specialized-study-startup-tools-work-alongside-oncore-medidata-and-veeva/ Wed, 15 Apr 2026 22:08:34 +0000 https://trialconnx.com/?p=1954 Study startup tools don't replace OnCore, Medidata Rave, Veeva CTMS, or WCG eResearch. They cover the pre-activation phase and hand off cleanly at site activation. This post shows how a dedicated startup tool fits alongside your existing CTMS — with no integration required to get started.

The post How Specialized Study Startup Tools Work Alongside OnCore, Medidata, and Veeva appeared first on TrialConnx.

]]>

Part 3 of 3: Study Startup vs. CTMS Series

In Part 1, we explained why CTMS platforms aren’t built for study startup. In Part 2, we covered when startup becomes a bottleneck. This post shows how a dedicated startup tool fits alongside the CTMS you already have.

⚡

Quick Answer

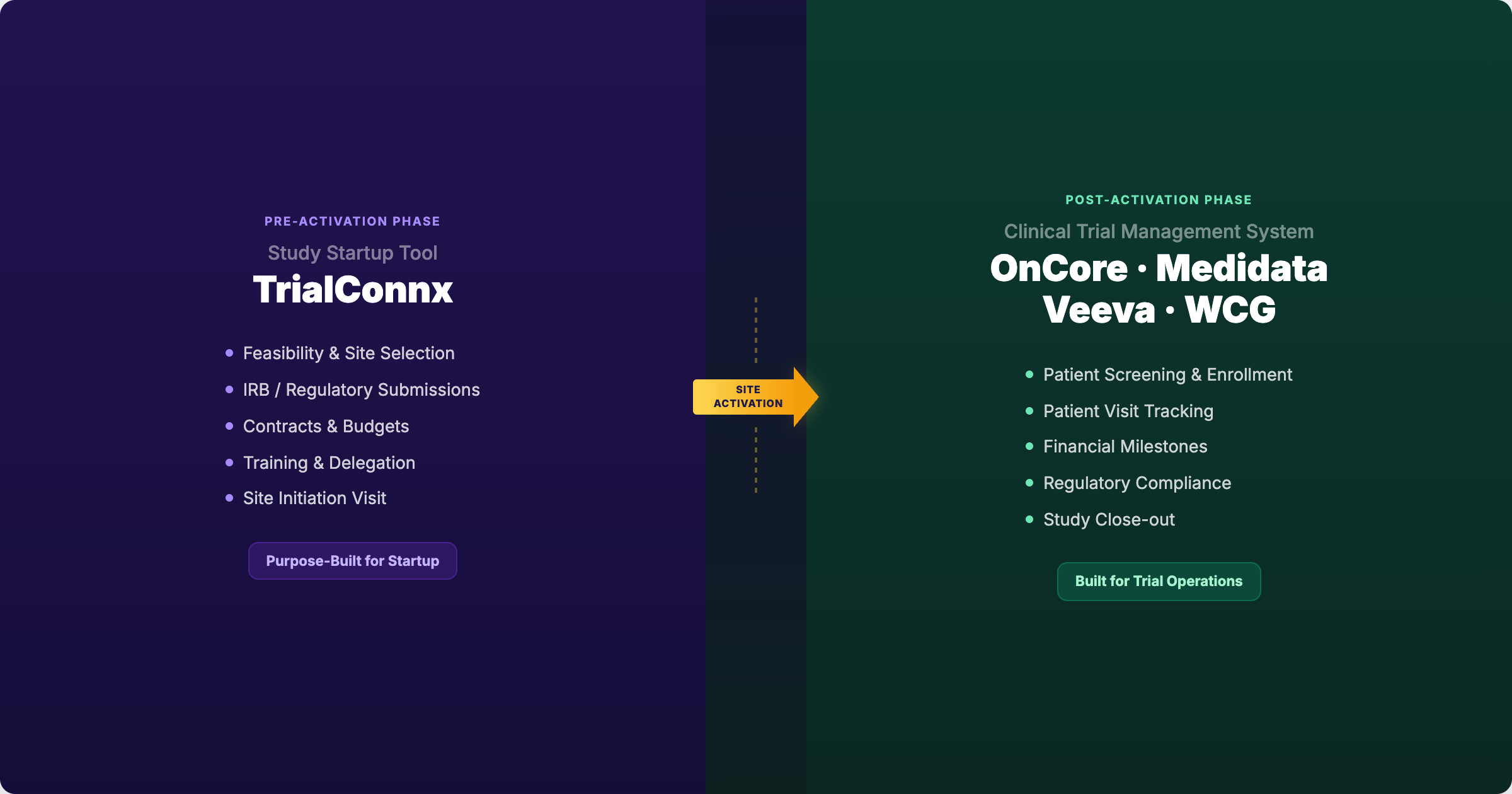

Study startup tools don’t replace OnCore, Medidata Rave, Veeva CTMS, or WCG eResearch. They cover a different phase: the pre-activation work that happens before your CTMS becomes relevant. Regulatory submissions, contract negotiations, budget creation, feasibility responses, and internal coordination all run in parallel during startup and hand off cleanly to the CTMS at site activation. The integration point is well-defined: when a study activates, the startup tool’s job is done and the CTMS takes over. Most implementations require no custom integration work because the two systems operate on sequential, non-overlapping phases.

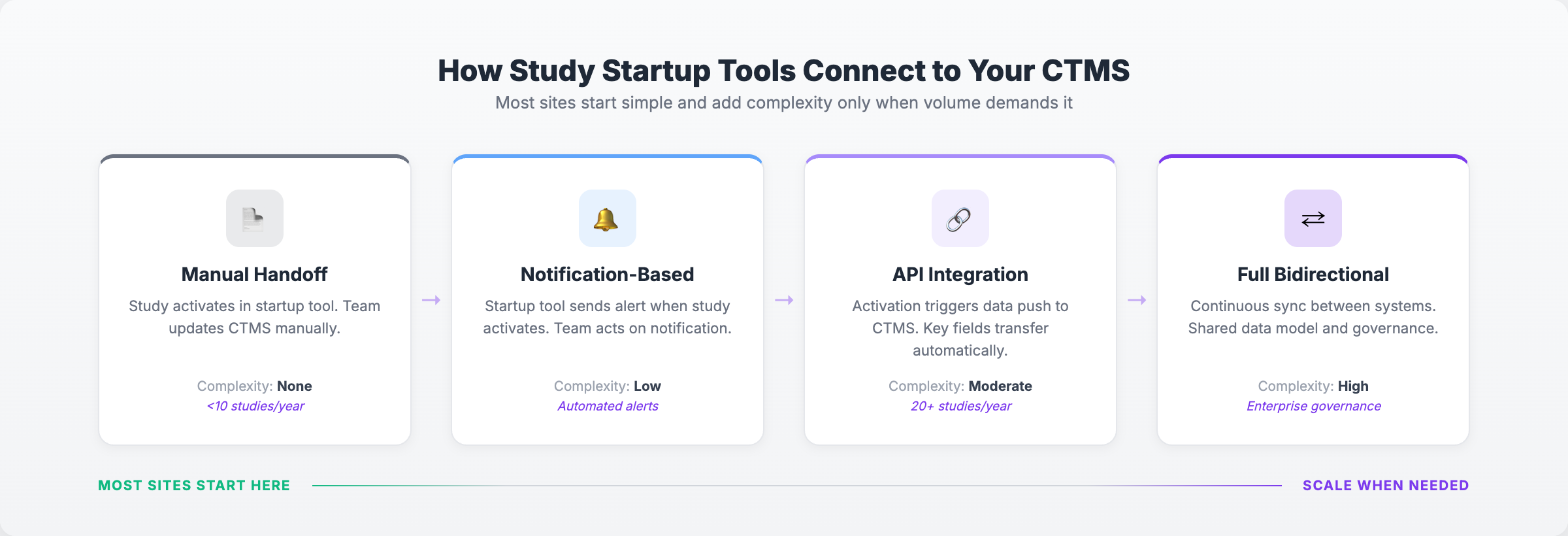

Split infographic showing TrialConnx managing pre-activation study startup on the left with site activation arrow pointing to OnCore, Medidata, Veeva, and WCG managing post-activation trial operations on the right

Your tech stack already has layers

If you run clinical research at any scale, you already manage multiple systems. An eReg system for regulatory documents. An eConsent platform. A CTMS for trial operations. An EHR that connects clinical care to research. A finance system for invoicing and milestones. Each one covers a specific function. None of them tries to do everything.

Study startup is the one function that still doesn’t have a dedicated layer. Instead, it runs on spreadsheets, email threads, shared drives, and the memory of whoever has been at the institution longest. That gap costs sites 25 to 30 days per study in internal handoffs alone (Tufts CSDD, 2024). It’s not a gap anyone planned. It formed because CTMS platforms expanded into trial management before startup had its own tooling category.

There’s a name for this gap: study startup systems. It’s the missing layer in the clinical tech stack, purpose-built to manage the pre-activation phase that your CTMS was never designed to cover. The question IT leaders are asking isn’t “do we need another system?” It’s “is the gap costing us more than filling it would?” For most sites running five or more concurrent studies, the answer is already clear. We explored why in When Study Startup Becomes a Bottleneck.

What OnCore, Medidata, Veeva, and WCG do well

This isn’t about what’s wrong with your CTMS. It’s about understanding what each platform was built for so you can see where the boundary is.

OnCore is the dominant CTMS in academic medical centers. It manages study calendars, patient visit tracking, coverage analysis, and financial milestones. For AMCs running NCI-designated cancer center portfolios, OnCore is deeply embedded in post-activation workflows.

Medidata Rave CTMS serves large CROs and sponsors managing multi-site global trials. It excels at enrollment tracking, randomization, site performance metrics, and sponsor-side reporting across hundreds of sites.

Veeva CTMS (part of the Veeva Vault Clinical Suite) targets sponsor and CRO operations with strong document management integration, milestone tracking, and regulatory intelligence across the clinical development lifecycle.

WCG eResearch (formerly Velos eResearch) serves academic medical centers and health systems with study management, regulatory tracking, and financial operations. For sites already using WCG’s IRB services, eResearch provides an integrated path from regulatory approval to trial operations.

All four platforms share the same architectural assumption: they manage what happens after a site activates. After regulatory approval is in hand. After contracts are executed. After the site is green-lit for enrollment.

Platform Primary Market Core Strength Phase Coverage
OnCore Academic Medical Centers Study calendars, coverage analysis, financial milestones Post-activation
Medidata Rave CTMS Large CROs, Sponsors Enrollment tracking, multi-site coordination, sponsor reporting Post-activation
Veeva Vault CTMS Sponsors, CROs Document management, milestone tracking, regulatory intelligence Post-activation
WCG eResearch AMCs, Health Systems Study management, regulatory tracking, financial operations Post-activation
Study Startup Tool Research Sites, AMCs Parallel workstream coordination, handoff tracking, time-in-stage visibility Pre-activation

The pattern is consistent: your CTMS picks up at activation. Everything before that point is the startup phase. And it’s the startup phase where sites lose an average of 25 to 30 days in internal handoffs alone (Tufts CSDD, 2024).

Where a startup tool sits in your clinical technology stack

Here’s the part that matters most for IT planning. A study startup tool doesn’t sit on top of your CTMS. It sits beside it, covering a different phase of the same lifecycle. The boundary is clean: everything from feasibility through site activation lives in the startup tool. Everything from activation through study close lives in the CTMS.

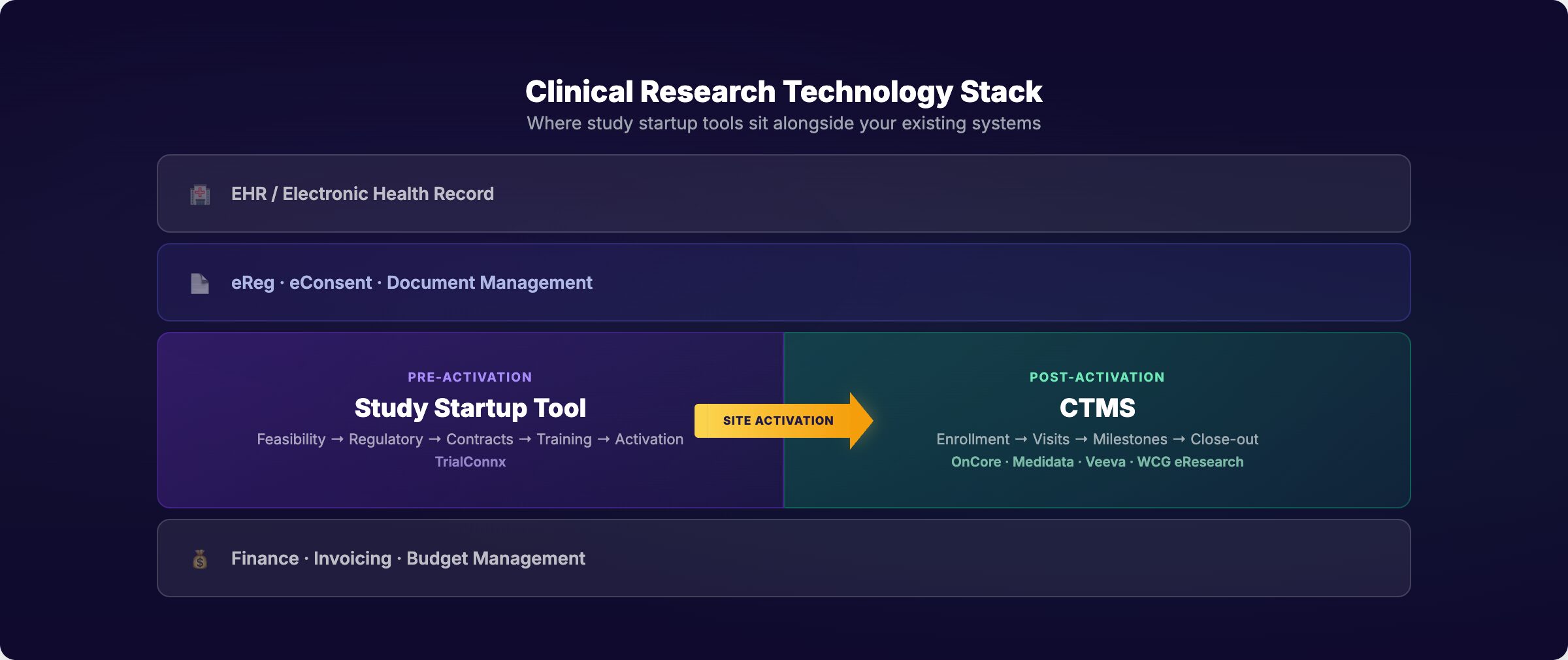

Clinical research technology stack showing EHR, eReg, study startup tool and CTMS layers with site activation handoff between pre-activation and post-activation phases
1
Feasibility and Site Selection

Sponsor sends feasibility questionnaire. Startup tool tracks response preparation, PI review, and submission. Your CTMS doesn’t touch this.

2
Regulatory and IRB Submissions

Package preparation, submission tracking, revision cycles, approval timelines. Parallel across multiple studies. Your CTMS records the approval date; the startup tool manages the process that gets you there.

3
Contracts and Budgets

Redline cycles, budget creation, negotiation tracking, execution timelines. Often the longest single phase. Your CTMS tracks the executed contract as a milestone; the startup tool tracks the 22 days of back-and-forth that preceded it.

4
Site Initiation and Activation

Training completion, delegation logs, SIV scheduling, green-light checklist. This is the handoff point. When the startup tool marks a study as activated, the CTMS takes over.

Pro Tip: The cleanest way to evaluate fit is to ask: “Does this task happen before or after our first patient could enroll?” If before, it’s startup. If after, it’s your CTMS. The line rarely moves.

How data flows between systems

This is the question every CIO asks first, and the answer is simpler than most expect.

The two systems operate on sequential phases. They don’t need to share real-time data because they’re rarely active on the same study at the same time. The handoff happens once: at activation.

What the startup tool creates

  • Regulatory approval dates and document status
  • Contract execution dates and key terms
  • Budget approval status and negotiation history
  • Training completion records and delegation log status
  • Feasibility response data and PI confirmation
  • Time-in-stage and handoff duration metrics

What your CTMS needs at activation

  • Confirmation that regulatory approval is complete
  • Executed contract and approved budget
  • Completed training and delegation documentation
  • Green-light confirmation that the site is ready to enroll

The integration model

For most implementations, the integration is a defined handoff, not a continuous data sync. When activation readiness is confirmed, the study moves into the CTMS workflow. This can be as simple as a status notification or as structured as an API-based trigger.

Four integration approaches from manual handoff to full bidirectional sync showing increasing complexity for connecting study startup tools to CTMS platforms

Most sites start with manual or notification-based handoff and move to API integration only when volume demands it. The point: you don’t need to plan a six-month integration project to get started.

The IT concerns (and honest answers)

If you’ve been burned by a clinical technology implementation before, these are the questions you’re already thinking about. Here are direct answers.

1
Security and compliance

Study startup tools handle regulatory documents, contract details, and staff information. Any tool in this space should support encryption at rest and in transit, provide role-based access controls, and maintain clear data handling policies. Ask about their security practices and compliance roadmap before the demo.

2
Single sign-on (SSO/SAML)

Your team already manages credentials for multiple systems. A startup tool that requires separate login credentials creates friction and reduces adoption. SSO/SAML support isn’t a nice-to-have. It’s a requirement for any system touching institutional data.

3
Implementation timeline

Because startup tools don’t need deep integration with existing systems to deliver value, implementation timelines are measured in weeks, not months. Most sites can be running their first studies through the tool within 2 to 4 weeks of kickoff. Compare that to the 6 to 12 months a typical CTMS implementation requires.

4
Maintenance burden

Cloud-based startup tools handle updates, backups, and infrastructure. Your IT team isn’t maintaining another server or managing another upgrade cycle. The operational burden stays with the vendor.

5
Data governance and ownership

Your data stays yours. Startup metrics, regulatory timelines, and process data should be exportable at any time. Ask about data portability and retention policies during evaluation. If a vendor can’t answer directly, move on.

Red Flags in Vendor Evaluation

Watch for startup tools that require replacing your CTMS, need 6+ months of implementation, can’t clearly explain their security practices, or store data in ways that conflict with your institution’s data governance policies. A complementary tool should simplify your stack, not complicate it.

What happens when the 89-day gap stays open

Most of these consequences don’t surface in a single study. They compound across three, five, ten concurrent startups until the pattern is impossible to ignore.

  • Activation timelines stretch without explanation. The protocols aren’t harder. The sponsors aren’t slower. But every study takes longer than it should because coordination overhead grows faster than study count.
  • Budget work starts late. At one AMC, budget negotiation couldn’t begin until Day 72 of a 120-day activation target. Sixty percent of the timeline was consumed before core financial work could start.
  • IRB submissions get rushed. When coordinators are stretched across multiple startups, first-pass approval rates drop from 78% to 52%. Each revision cycle adds 13 or more days.
  • Feasibility responses slow down. New opportunities sit in a queue while the team is buried in active startup work. Every delayed response is a study your site may not get.
  • Status meetings replace actual work. What starts as a 90-minute weekly check-in becomes 6+ hours of reconstructing reality across spreadsheets, email, and hallway conversations.

These aren’t hypotheticals. They’re patterns we’ve seen at sites running three or more concurrent startups without a dedicated system for the pre-activation phase. The CTMS captures the downstream effects, but the root cause is upstream, in the 89 days before activation.

What changes for site teams

Technology decisions happen in IT offices. But the impact lands on coordinators, study managers, and PIs. Here’s what actually changes in daily workflows when a startup tool runs alongside your CTMS.

Before and after comparison showing site operations with CTMS only versus startup tool plus CTMS, highlighting reduced meeting time, one-click status, and automated handoff flagging

The coordinator who used to spend Monday mornings reconstructing status across spreadsheets now opens a dashboard. The study manager who scheduled weekly check-ins with four departments now reviews a portfolio view. The PI who asked “are we on track?” and waited two days for an answer gets it in real time.

The CTMS doesn’t change. It still does what it does well. The difference is that studies arrive at activation better prepared, with cleaner documentation, fewer last-minute scrambles, and staff who aren’t already burned out from the startup phase.

What this looks like in practice

Theory is useful. But here’s what this looked like at one site.

One Academic Medical Center’s Integration Experience

A major academic medical center and NCI-designated cancer center was running OnCore for post-activation trial management. Startup coordination ran on spreadsheets, email, and a shared drive. Their activation target: 120 business days. They weren’t consistently hitting it, and nobody could pinpoint why.

The existing stack

System Function Phase
OnCore Study calendars, coverage analysis, financial milestones Post-activation
eReg system Regulatory document storage Both
Spreadsheets + email Startup coordination, task tracking, status reporting Pre-activation

What the startup tool revealed

When they mapped their first three studies into a purpose-built startup tool, three things became visible that their existing systems had never surfaced:

  • Lab manuals from sponsors weren’t arriving for three or more months into the activation process. This delay was invisible in their previous workflow.
  • Budget work couldn’t start until Day 72 of a 120-day target. Sixty percent of their timeline was consumed before core financial work could begin.
  • A 29-day wait to get in front of the PI for resource meetings. A scheduling bottleneck that nobody realized existed.

“We weren’t able to start our budget until Day 72 and we are charged with opening within 120 business days.”

Central Office Leadership

How the startup tool fit alongside OnCore

OnCore continued handling post-activation operations. The new layer managed pre-activation coordination. The two systems didn’t need integration because they covered sequential phases. When a study activated, the team moved operations into OnCore as they always had.

The difference: studies arriving in OnCore were better prepared. Documentation was complete. Training was verified. The scramble that used to happen at activation disappeared because the upstream process was visible and managed.

Results within 30 days

21 days
Saved per study
17.5%
Faster activation
0
Changes to OnCore workflow

“The most important thing for your institution right now is to analyze bottlenecks… The timelines will start decreasing now that we have visibility on tasks.”

Central Office Leadership

Key Takeaway: The startup tool didn’t replace OnCore. It filled the gap OnCore was never designed to cover. Two targeted process changes, made visible by the startup tool’s data, saved 21 days per study. OnCore’s workflow didn’t change at all.

Does this sound familiar?

You don’t need to run a formal evaluation to know if the 89-day gap is costing you. You just need to answer a few questions honestly.

If most of these are true, your current setup is working:

  • You run fewer than 3 concurrent studies
  • Your activation timelines are within industry median for your study phase
  • You can answer “where is Study X in startup?” in under 2 minutes
  • Your IRB first-pass approval rate is above 70%

If any of these sound familiar, the gap is already costing you:

  • You run 5+ concurrent startups
  • Activation timelines consistently exceed industry median
  • Status updates require weekly meetings with multiple departments
  • Staff turnover is connected to startup workload
  • Your CTMS has a startup module but your team still uses spreadsheets

Questions for your vendor evaluation

Category Question What to Look For
Security What are your security practices and compliance certifications? Clear documentation, encryption standards, compliance roadmap
Authentication Do you support SSO/SAML? Native support, not “on the roadmap”
Integration What does integration with our CTMS require? Honest answer about scope; “none required” is valid
Implementation How long from contract to first study live? Weeks, not months
Data Can we export our data at any time? Full export capability, clear retention policy
Fit Does your tool manage post-activation operations? “No” is the right answer. Complement, not overlap.

See which pre-activation stages are adding weeks before your CTMS picks up.

Request a Demo

Frequently Asked Questions

These are the questions that come up most during evaluation.

Does a study startup tool replace OnCore, Medidata, Veeva, or WCG eResearch?

No. A startup tool covers the pre-activation phase: feasibility, regulatory submissions, contracts, budgets, and internal coordination. Your CTMS continues managing post-activation operations: patient visits, enrollment tracking, financial milestones, and compliance. The two systems cover sequential phases of the study lifecycle and complement each other.

What integration work is required to connect a startup tool with my CTMS?

For most implementations, none. Because startup tools and CTMS platforms cover sequential phases, they don’t need to share real-time data. The handoff happens once at activation. Most sites start with a manual or notification-based handoff and add API integration only when study volume requires it. You don’t need a six-month integration project to get started.

How long does implementation take?

Most sites are running their first studies through a startup tool within 2 to 4 weeks of kickoff. Because the tool doesn’t need deep integration with existing systems, the implementation is primarily configuration and training. Compare that to the 6 to 12 months a typical CTMS implementation requires. The lighter footprint is a direct result of the narrower scope: managing startup, not the entire trial.

My CTMS has a startup module. Why would I need a separate tool?

Several CTMS platforms offer startup tracking as an add-on. On paper, it looks like coverage. In practice, it’s usually a milestone list bolted onto a system designed for post-activation workflows. If your team is using the startup module and still tracking day-to-day coordination in spreadsheets and email, the module isn’t solving the problem. Startup requires parallel workstream management, handoff tracking, and time-in-stage visibility that milestone-based add-ons don’t provide.

What security standards should I expect from a startup tool?

At minimum: encryption at rest and in transit, role-based access controls, SSO/SAML support, and clear data handling policies. The tool handles regulatory documents, contract details, and staff information. It should meet the same security expectations as any system in your clinical technology stack. Ask about their security practices and compliance roadmap during evaluation.

How does this fit into our budget when we’re already paying for a CTMS?

A startup tool isn’t a duplicate expense. It covers a phase your CTMS doesn’t manage. The business case comes from the time you’re currently losing: 25 to 30 days per study in internal handoffs, rushed IRB submissions that add revision cycles, and staff burnout that drives turnover. One academic medical center saved 21 days per study within the first month. At that rate, the tool pays for itself in avoided delays and recovered capacity.

The stack is simpler than you think

Your CTMS manages trials. Your eReg manages documents. Your EHR manages patients. Each system covers its phase. Study startup is the phase that’s been running on workarounds. That’s the 89-day gap.

Filling it doesn’t complicate your stack. It completes it. A study startup system sits beside your CTMS, covers the pre-activation phase, and hands off cleanly at activation. No overlap. No integration required to start.

Map your last three study startups. Count the days between stages. That gap is where the weeks are hiding.

Study Startup vs. CTMS Series

Part 1: Why Your CTMS Isn’t Built for Study Startup

Part 2: When Study Startup Becomes a Bottleneck (And What to Do About It)

Part 3: How Specialized Study Startup Tools Work Alongside OnCore, Medidata, and Veeva (You are here)

Map Where Your Startup Time Goes

See which pre-activation handoffs are adding weeks before your CTMS picks up. No integration required to start.

Sources

  1. Tufts Center for the Study of Drug Development (2024). Study startup cycle time benchmarks.
  2. AACI Survey (2024). Site activation performance data for NCI-sponsored and industry-sponsored studies.
  3. OnCore Enterprise Research CTMS. Product documentation and market positioning.
  4. Medidata Rave CTMS. Product documentation and market positioning.
  5. Veeva Vault CTMS. Product documentation and market positioning.
  6. WCG eResearch (formerly Velos eResearch). Product documentation and market positioning.

The post How Specialized Study Startup Tools Work Alongside OnCore, Medidata, and Veeva appeared first on TrialConnx.

]]>
When Study Startup Becomes a Bottleneck (And What to Do About It) https://trialconnx.com/when-study-startup-becomes-a-bottleneck-and-what-to-do-about-it/ Wed, 08 Apr 2026 01:09:03 +0000 https://trialconnx.com/?p=1909 Study startup works fine at one or two studies. Then you add a third, a fourth, a fifth — and the coordination model that kept everything on track collapses. Here's how to recognize the bottleneck and what to do about it.

The post When Study Startup Becomes a Bottleneck (And What to Do About It) appeared first on TrialConnx.

]]>

Part 2 of 3: Study Startup vs. CTMS Series

In Part 1, we explored why your CTMS isn’t built for study startup. This post covers how to recognize when startup has become a bottleneck at your site and what to do about it.

⚡

Quick Answer

Study startup becomes a bottleneck when the informal systems that work for one or two studies collapse under the weight of three or more running in parallel. The signs are specific: feasibility responses that used to take 3 days now take 9. IRB submissions that used to pass on the first try now bounce back. Status updates that required a quick hallway check now consume hours of meetings. The fix isn’t working harder. It’s recognizing that startup at scale is a different operational problem than startup for a single study. This post gives you a framework to diagnose where you are and what to do about it.

Infographic showing study startup coordination growing from manageable at 2 studies to bottleneck at 5 concurrent studies

Startup works fine until it doesn’t

One study in startup? You know every task, every deadline, every contact. The protocol requirements live in your head. You track milestones in a spreadsheet, maybe a shared document. It works because one person can hold the entire picture.

Two studies? More effort, but the same approach holds. You adjust your schedule. You stay late occasionally. The spreadsheet gets another tab.

Then a third study arrives. And something subtle changes. The approach that carried you through the first two isn’t holding up. Tasks slip. Handoffs stall. Feasibility responses that took 3 days now take 9. You spend more time chasing updates than doing the work itself.

This isn’t a competence problem. It’s a coordination limit. Sites don’t hit this wall because they’re disorganized. They hit it because informal coordination has a ceiling, and most sites cross it somewhere between study two and study four.

We explored this pattern in detail in Are Spreadsheets Enough for Tracking Study Startup? The short version: the tool isn’t the issue. The coordination model is.

Five signs startup has become a bottleneck at your site

The bottleneck doesn’t announce itself. It builds gradually. At first, it feels like more work. Then it becomes something else. Here are five signs that startup coordination has crossed from manageable to constraining your site.

1. Feasibility responses are slowing down

Your feasibility coordinator used to turn responses around in 3 business days. Now, with five concurrent startups pulling attention, responses take 9 days. That’s a 200% increase, and it has nothing to do with the complexity of the questionnaires.

What it looks like at the site: new feasibility requests sit in a queue while the coordinator is buried in active startup work for studies already in the pipeline. They’re triaging instead of responding. Every delayed response is a potential study your site doesn’t get.

2. IRB submissions are bouncing back more often

When a regulatory coordinator has time to prepare a complete submission, first-pass approval rates run around 78%. Under the pressure of multiple concurrent startups, that drops to fifty-two percent. The 26-percentage-point gap adds 13 or more days per study in revision cycles.

What it looks like at the site: the regulatory coordinator knows the package isn’t complete. But three other studies need attention this week, so they submit what they have and hope for the best. The revision comes back. Another cycle begins. We covered the seven most common first-submission failures in Why Site IRB Submissions Fail the First Time.

3. Status updates require meetings instead of glances

At two concurrent studies, status meetings take about 1.5 hours per week. At five concurrent studies, that grows to 6 hours per week. A 300% increase in time spent talking about work instead of doing it.

The meeting isn’t the problem. The problem is that nobody can answer “where is Study X in startup?” without assembling everyone in a room. There’s no single view of what’s happening across studies. So you reconstruct the picture from memory, every week, in a conference room.

What it looks like at the site: Monday becomes meeting day. The actual work gets pushed to Tuesday through Friday. And by Friday, you’re already behind for the next Monday update.

4. Activation timelines are stretching without explanation

One research site went from managing 2 concurrent startups to 5 without changing their coordination process. Their median activation time jumped from 72 days to 118. That’s a 64 percent increase. The protocols weren’t harder. The sponsors weren’t slower. The site hit the complexity ceiling.

What it looks like at the site: every study takes longer than it should, but nobody can point to a single reason. The delays are spread across dozens of small handoffs and micro-decisions that don’t show up in any milestone tracker. We explored this breakdown pattern in What Breaks First When Sites Run Multiple Studies in Parallel.

5. Your best people are burning out

According to the ACRP Workforce Survey (2024), thirty-four percent of CRCs cite burnout as their primary reason for leaving clinical research. When startup workload spills into evenings and weekends, that’s not dedication. It’s a system failure being absorbed by individuals.

What it looks like at the site: the person who holds everything together, the one who remembers which study needs what and when, starts looking for a different job. When they leave, the institutional knowledge leaves with them. And the next study startup takes even longer.

Self-Check

If you recognized yourself in even two of these, you’re likely already losing time you haven’t measured. The rest of this post covers why that happens and what you can do about it.

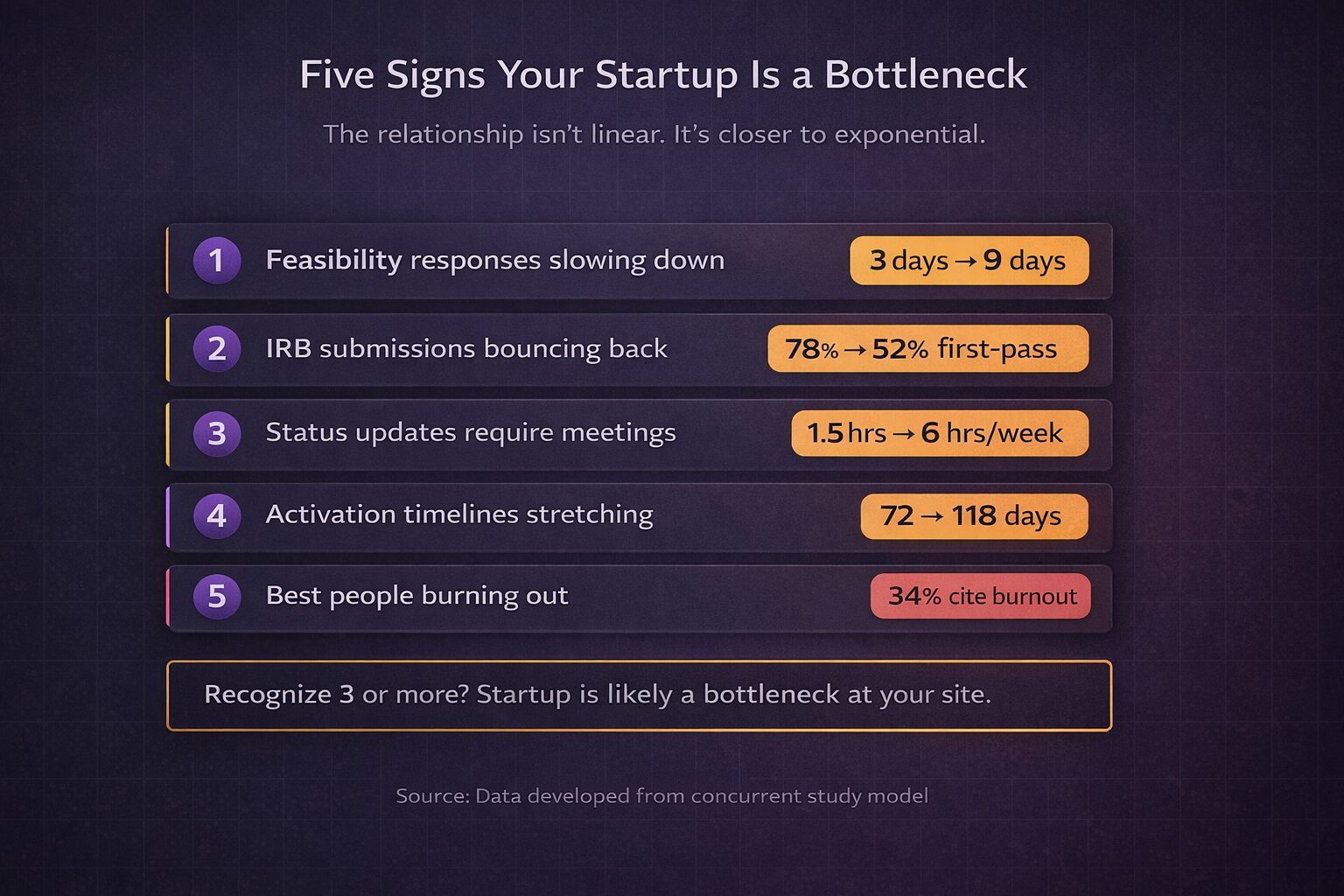

Visual checklist of five signs your study startup is a bottleneck with metric badges showing feasibility, IRB, meetings, activation, and burnout impact

Why working harder doesn’t fix a scaling problem

This is where most sites start to feel the shift. The natural response when things slow down is to push harder. Work longer hours. Skip a review step. Ask the coordinator to take on one more study. Maybe hire another person.

But the bottleneck isn’t a staffing problem. It’s an architecture problem.

Study startup involves parallel workstreams: regulatory submissions, contract negotiations, budget creation, feasibility responses. Each study adds a full set. At one study, you’re managing 4 workstreams. At five studies, you’re managing 20, with overlapping dependencies, shared resources, and handoffs that multiply faster than headcount ever could.

Concurrent Studies Active Workstreams Handoff Points/Week Coordination Hours/Week
1 4 ~5 ~1 hr
2 8 ~12 ~1.5 hrs
3 12 ~22 ~3 hrs
5 20 ~40 ~6 hrs

Chart showing exponential growth in coordination overhead as concurrent studies increase from 1 to 5

The relationship between study count and coordination overhead isn’t linear. It’s closer to exponential. That’s what makes this a scaling problem, not a people problem. How do you track 20 parallel workstreams across spreadsheets, email threads, and shared drives? You don’t. Not well.

For a closer look at where this administrative burden lands, see The Hidden Admin Workload in Study Startup.

Pro Tip: If doubling your team wouldn’t fix the slowdown, it’s not a staffing problem. It’s a coordination architecture problem. Adding people to a broken process makes it faster and more broken.

The hidden cost of a slow startup

And this is the part that’s easy to miss. A startup bottleneck isn’t an inconvenience. It has real downstream consequences for study quality, site revenue, and staff retention. The costs compound, and most don’t surface until it’s too late to prevent them.

Study quality takes the first hit

According to the ACRP Quality Benchmarking Survey (2023), 67% of protocol deviations in the first 90 days trace back to inadequate startup preparation. Rushed startup means incomplete training, unclear delegation logs, and staff who don’t fully understand the protocol before the first patient walks in.

One site managing 8 studies on compressed timelines saw a 23% protocol deviation rate. After implementing structured startup management with clear stage gates and handoff ownership, deviations dropped to 9%. A sixty-one percent reduction.

67%
Of protocol deviations trace to inadequate startup preparation
61%
Reduction in deviations after structured startup management

Source: ACRP Quality Benchmarking Survey (2023)

Site revenue erodes

Every delayed feasibility response is a potential study your site doesn’t get. Every extended activation timeline is sponsor confidence you’re losing. Sites competing for studies are judged on activation speed. A site that consistently takes 118 days when the industry median is 89 is a site that stops getting selected.

This isn’t abstract. If your feasibility response time has gone from 3 days to 9, sponsors are seeing that. They’re comparing your turnaround against other sites. And they’re making selection decisions based on it.

Staff retention breaks down

One site saw 28% annualized staff turnover before implementing a structured startup approach. After giving coordinators visibility into workload distribution, clear handoff ownership, and proactive escalation paths, turnover dropped to eleven percent. A 61% reduction.

Coordinators don’t leave because the work is hard. They leave because the work feels impossible and nobody can see what they’re carrying. When a coordinator quits, the institutional knowledge leaves with them, and the next startup takes even longer.

We explored this cycle in depth in The Unspoken Tradeoffs Sites Make to Hit Startup Timelines.

Key Takeaway: A slow startup doesn’t delay one study. It degrades every study running in parallel and erodes the site’s ability to compete for future work. The costs show up in quality data, sponsor relationships, and resignation letters.

What to do about it: a practical framework for sites

Not every site needs the same intervention. The right response depends on where you are: how many concurrent startups you manage, how much visibility you have, and how fast you need to scale. Here’s a three-tier framework matched to your situation.

Tier 1: Process fixes (zero cost, high impact)

Best for: Sites running 2-3 concurrent startups

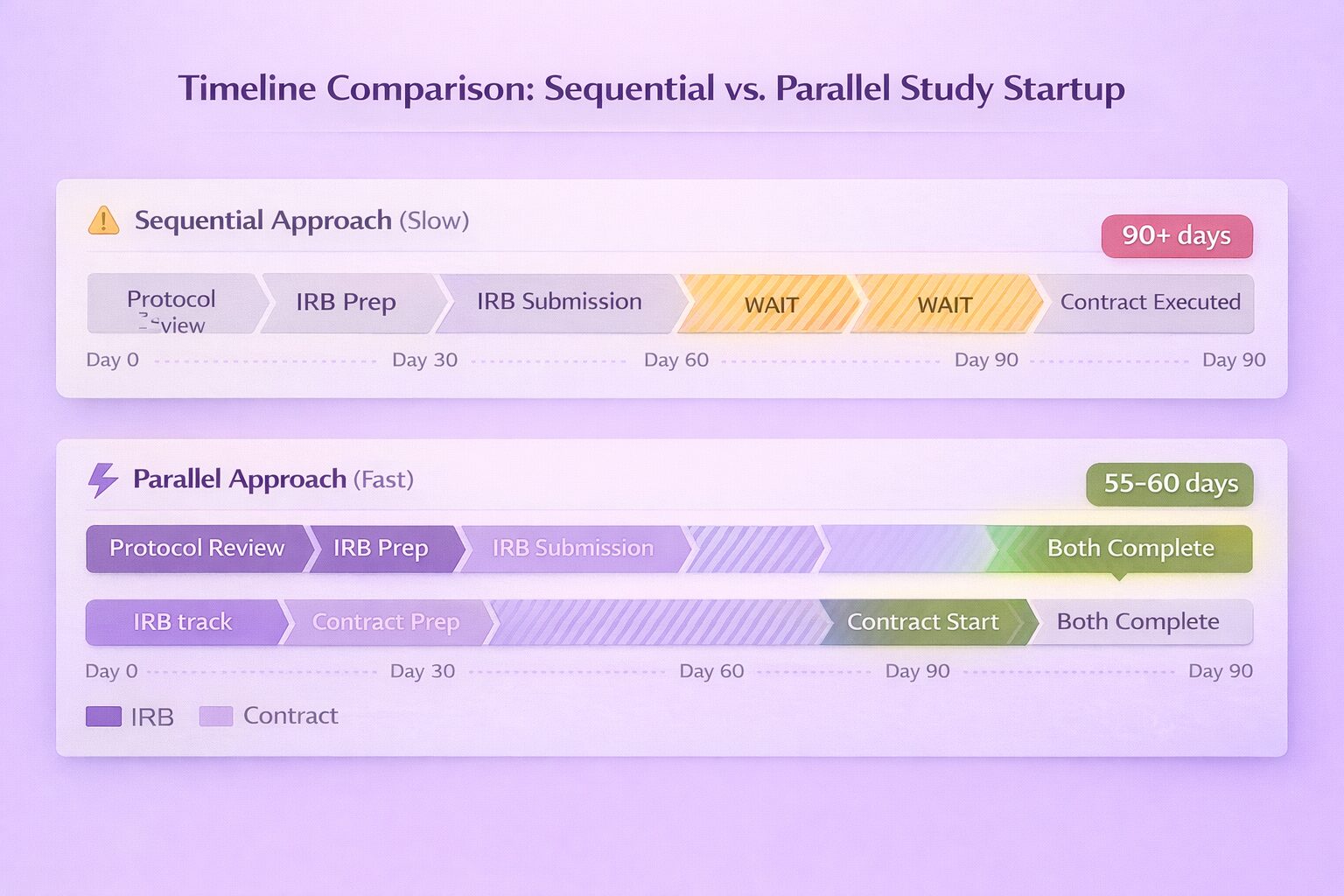

Start by mapping the startup timeline for your last 3 studies. Not the total days. Break it into stages and measure two things: time in each stage and time between stages. The gaps between stages are where handoff problems hide.

At one academic medical center, the longest single wait was getting in front of the PI: 29 business days. They didn’t need software to fix that. They restructured when the resource meeting happened and eliminated the wait.

Another quick win: decouple sequential steps. Can budget shell creation start before all sponsor information arrives? In most cases, yes. Starting the shell earlier means the budget is closer to ready when the final details come in, instead of starting from zero on Day 72 of a 120-day target.

For guidance on breaking down your startup timeline, see Inside the Study Start-up Timeline.

Tier 2: Visibility improvements (low cost, systematic impact)

Best for: Sites running 3-5 concurrent startups

Process fixes tell you where the problems are. Visibility improvements keep them from coming back. Three things to build:

1
Single portfolio view

Where every study stands across regulatory, contracts, budgets, and feasibility. One view, all studies. Not a spreadsheet per study.

2
Standard stage durations

So you can spot outliers before they become delays. If IRB review normally takes 14 days and Study X is at day 23, that’s a flag.

3
Handoff ownership tracking

Not “contract is in progress” but “contract is waiting on [person] since [date].” The name and the date change the conversation.

For a practical starting point, see The Minimal Viable Study Startup Dashboard.

Tier 3: Dedicated startup tooling (investment, transformational impact)

Best for: Sites running 5+ concurrent startups, or planning to grow

At this volume, the coordination complexity exceeds what any spreadsheet or dashboard can handle. Dedicated startup tooling provides:

1
Portfolio-level visibility

See every active startup across all studies in one system. No more reconstructing the picture from five spreadsheets and a dozen email threads.

2
Automated escalation

Tasks that exceed expected durations trigger alerts before they become delays. Staff have a safety net for flagging upstream blockers instead of absorbing them.

3
Parallel workstream coordination

Run regulatory, contracting, and budget work in parallel across multiple studies without depending on one person to hold it all together.

4
Measurable benchmarks

Time in stage, time between stages, handoff duration, first-pass rates. Data that tells you what to fix, not only that something is slow.

Not every site needs Tier 3 on day one. But every site running 3 or more concurrent studies should at least be operating at Tier 1. Most aren’t.

Your Situation Start Here Goal
1-2 studies, startup feels manageable Tier 1: Map your timeline Find the hidden gaps before they compound
3-4 studies, startup is stretching Tier 2: Build visibility Coordinate by data, not by meeting
5+ studies, startup is the constraint Tier 3: Dedicated tooling Manage a portfolio, not a pile of spreadsheets
Three-tier decision framework showing process fixes, visibility improvements, and dedicated tooling matched to concurrent study volume

What happens when you fix the bottleneck

One academic medical center and NCI-designated cancer center was managing startup across two departments with all ancillary teams. Their activation target: 120 business days. They knew startup felt slow — they didn’t know where the time was going.

What the Data Revealed

When they mapped their first three studies, three things became clear:

  • Lab manuals from sponsors weren’t arriving for 3 or more months into the activation process. This delay was invisible in their previous workflow.
  • Budget work couldn’t start until Day 72 of a 120-day target. That left 48 days for core work that should have had the full timeline.
  • Staff believed they were keeping up. The data showed that in some cases, they were the barrier, without knowing it.

“We weren’t able to start our budget until Day 72 and we are charged with opening within 120 business days.”

Central Office Leadership

What They Changed

Two targeted fixes. Not a complete overhaul.

  1. Moved budget shell creation earlier in the process, decoupling it from waiting for complete sponsor information
  2. Restructured resource meeting timing to eliminate a 29-day wait to get in front of the PI

Results Within 30 Days

21 days
Saved per study
17.5%
Faster activation
2
Process changes made

“The most important thing for your institution right now is to analyze bottlenecks — are they realistic timelines, has something changed in the process, is there a training issue… The timelines will start decreasing now that we have visibility on tasks.”

Central Office Leadership

Infographic showing AMC case study results: 21 days saved per study, 17.5% faster activation, 2 process changes, results within 30 days

Two process changes. One month. Twenty-one days saved per study. They didn’t overhaul everything. They saw where the time was going and fixed the two biggest gaps. That’s the power of visibility over effort.

For a broader look at moving from manual tracking to structured systems, see From Spreadsheets to Systems.

Where does your site stand?

Before you decide what to do next, assess where you are right now. Five questions. Be honest.

1
Can you answer “where is Study X in startup?” without calling a meeting or opening three spreadsheets?
2
Do you know your average time-to-activation for the last 5 studies?
3
Can you identify which stage adds the most days to your startup timeline?
4
Is your IRB first-pass approval rate above 70 percent?
5
Do feasibility responses go out within 5 business days?
4–5 Yes
Solid
Your startup process works. Focus on maintaining it as study volume grows.
2–3 Yes
Gaps Forming
Foundations exist but cracks are showing. Start with Tier 1 and Tier 2 fixes before volume exposes them.
0–1 Yes
Bottleneck
Startup is likely already the constraint. Map your timelines today.

For specific metrics to track and what they reveal, see 5 Study Startup Metrics That Actually Predict Delays.

See which stage is adding the most days to your activation timeline.

Request a Demo

Frequently Asked Questions

How many concurrent studies before startup becomes a bottleneck?

Most sites hit the complexity ceiling between 3 and 5 concurrent startups. The exact number depends on your team size, process maturity, and how much institutional knowledge lives in one person’s head. If you’re tracking startup across spreadsheets and email, the ceiling comes sooner. The coordination overhead grows faster than the study count, which is why adding one more study can feel like adding three.

What’s the biggest sign that startup is a bottleneck?

When activation timelines stretch without a clear reason. If the protocols aren’t harder and the sponsors aren’t slower, but every study takes longer than it should, the bottleneck is in your internal coordination. Another reliable sign: you can’t answer “where is Study X?” without calling a meeting or checking multiple sources.

Can process changes alone fix a startup bottleneck?

For sites running 2-3 concurrent studies, yes, often significantly. One academic medical center saved 21 days per study with just two process changes: moving budget shell creation earlier and restructuring resource meeting timing. But process changes require visibility into where time is being lost, which becomes harder to achieve manually as study volume grows.

What’s the difference between a staffing problem and a scaling problem?

A staffing problem means you don’t have enough people to do the work. A scaling problem means the coordination model itself doesn’t work at higher volume. Adding people doesn’t fix it because the overhead grows faster than the headcount. A practical test: if you doubled your team and startup would still feel slow, it’s a scaling problem. The fix is structural, not incremental.

What should I do first if startup is already a bottleneck?

Map the startup timeline for your last 3 studies. Measure time in each stage and time between stages. The gaps between stages, where work sits waiting for a handoff, are almost always where the biggest delays hide. You can’t fix what you can’t see. Once you have the data, it will point directly to the one or two changes that will have the biggest impact.

Start with the data

Pull the timelines for your last three study startups. Not the total days. Break them into stages. How long did each stage take? How long did work sit between stages waiting for someone to pick it up?

That gap between stages is where your bottleneck lives. You can’t fix what you can’t see.

So start there. Map three studies. Find the gap. Then fix it.

Study Startup vs. CTMS Series

Part 1: Why Your CTMS Isn’t Built for Study Startup

Part 2: When Study Startup Becomes a Bottleneck (You are here)

Part 3 (coming soon): How Specialized Study Startup Tools Work Alongside OnCore, Medidata, and Veeva

Ready to Find Your Bottleneck?

See where your startup time goes. Get the visibility to make targeted changes that cut weeks from your activation timelines.

Sources

  1. Tufts Center for the Study of Drug Development (2024). Study startup cycle time benchmarks.
  2. ACRP Quality Benchmarking Survey (2023). Protocol deviation root cause analysis.
  3. ACRP Workforce Survey (2024). Clinical research coordinator retention and burnout data.

The post When Study Startup Becomes a Bottleneck (And What to Do About It) appeared first on TrialConnx.

]]>
Why Your CTMS Isn’t Built for Study Startup https://trialconnx.com/why-your-ctms-isnt-built-for-study-startup/ Thu, 02 Apr 2026 22:17:47 +0000 https://trialconnx.com/?p=1874 Your CTMS tracks patient screening and enrollment, patient visits, financial milestones - all post-activation. But study startup - regulatory prep, contracts, budgets, feasibility - runs on spreadsheets and email. That gap costs sites weeks per study. Here's why, and what purpose-built startup tools do differently.

The post Why Your CTMS Isn’t Built for Study Startup appeared first on TrialConnx.

]]>

Prefer the visual version?  View the slide deck ↓

⚡

Quick Answer

CTMS platforms manage what happens after a study activates: patient screening and enrollment, patient visits, financial milestones. Study startup is a different phase with different workflows, different users, and different bottlenecks. The industry median for startup is 89 days (Tufts CSDD, 2024), and 28 to 34 percent of that time is lost in internal handoffs that CTMS platforms don’t track. Purpose-built startup tools close that gap by giving sites visibility into pre-activation coordination before the first patient is ever enrolled.

Split infographic showing CTMS managing post-activation milestones on one side and fragmented pre-activation startup workflows on the other

What your CTMS does well

CTMS platforms solve real problems. They track patient enrollment. They schedule patient visits. They track financial milestones and data collection workflows. For multi-site trials, they coordinate activities across dozens of locations.

These are valuable functions. If you’re running active studies, your CTMS is probably the system your CRCs and data managers live in daily.

But here’s what these systems have in common: they’re built for what happens after a study activates. After the site is green-lit. After first patient in.

The phase before that? That’s a different problem entirely.

The phase your CTMS doesn’t cover: Study Startup

What is Study Startup?

The pre-FPI (First Patient In) phase covering IRB/ethics submissions, contract and budget negotiations, feasibility assessments, site initiation visits, regulatory document collection, and staff training. Everything that must happen before a study can enroll its first patient.

Before your CTMS even becomes relevant, your site must navigate regulatory submissions, contract redlines, budget creation, feasibility questionnaires, and cross-functional coordination across multiple departments. These are parallel workstreams with daily handoffs, not linear milestones with periodic updates.

Most sites manage this phase with spreadsheets, email threads, and institutional memory. It works when you have one or two studies in startup. It breaks when you have three or more. For a deeper look at where startup time actually goes, see our breakdown in Inside the Study Start-up Timeline.

Two different phases, two different problems

Some CTMS vendors offer startup tracking as an add-on. On paper, it checks the box. In practice, it’s a milestone list bolted onto a system designed for a fundamentally different workflow. Here’s why the architectural mismatch matters:

Dimension CTMS (Post-Activation) Study Startup (Pre-FPI)
Primary users CRCs, data managers Regulatory coordinators, study managers, PIs
Workflow type Linear milestones Parallel workstreams
Key challenge Compliance and data quality Coordination and handoffs
Update cadence Per visit or event Daily, multi-stakeholder
Success metric Enrollment targets met Time to activation reduced

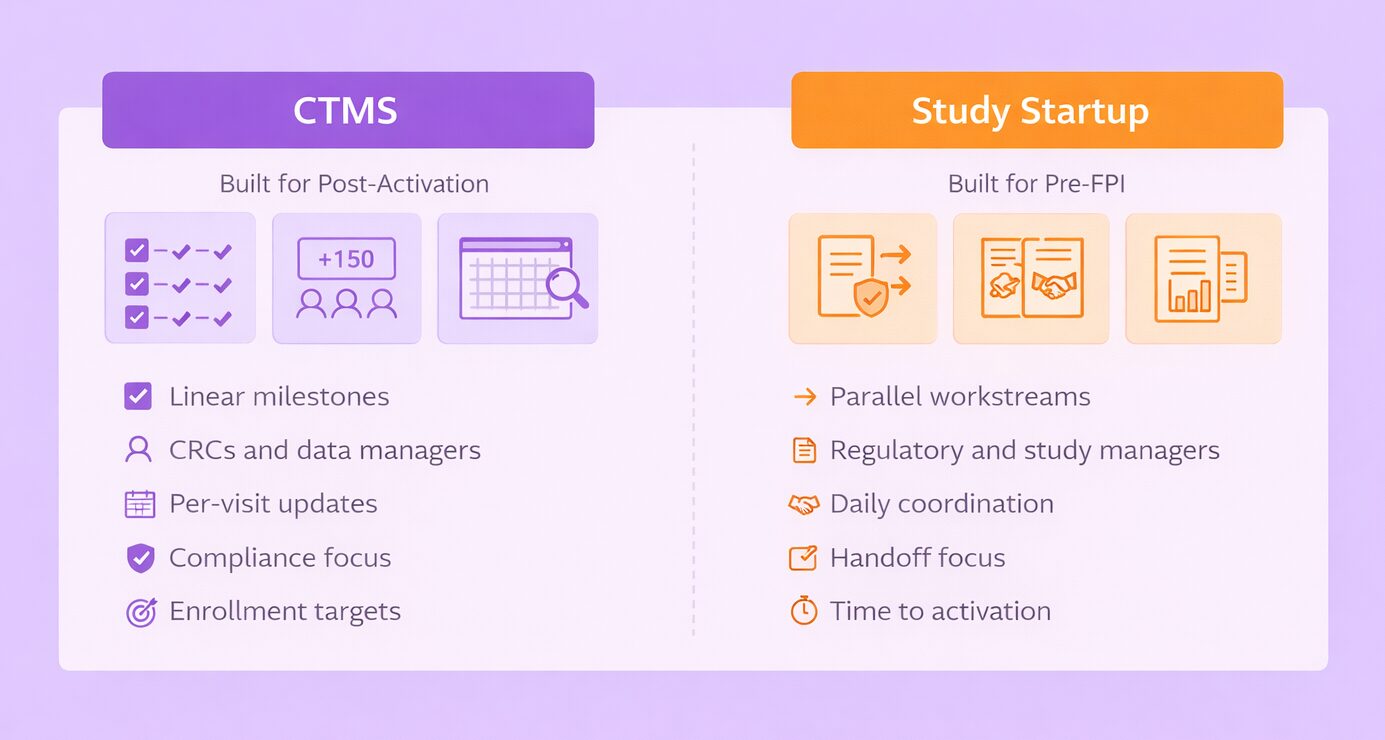

Side-by-side comparison cards showing CTMS built for post-activation linear milestones versus study startup requiring pre-FPI parallel workstream coordination

Study startup requires managing regulatory submissions, contract redlines, budget creation, and feasibility responses in parallel, often across multiple studies at once. CTMS tools track milestones sequentially. That’s the core mismatch.

Pro Tip: Track “time in stage” separately from “time between stages.” The gap between stages reveals handoff problems that milestone tracking masks entirely.

The cost of this gap: 89 days

Now that the mismatch is clear, here’s what it costs. According to Tufts CSDD (2024), the industry median for study startup is 89 days. Sponsors are increasingly pushing for 60-day activations. That 29-day gap is what sites absorb through workarounds, late nights, and shortcuts.

With no system managing pre-activation coordination, here’s where 89 days go:

Delay Source Share of Total Days Lost Controllable?
Internal handoffs 28-34% 25-30 days Yes
IRB review cycle 22-31% 20-28 days Partially
Sponsor contract negotiations 20-28% 18-25 days Partially
External vendors (labs, equipment) 13-20% 12-18 days No

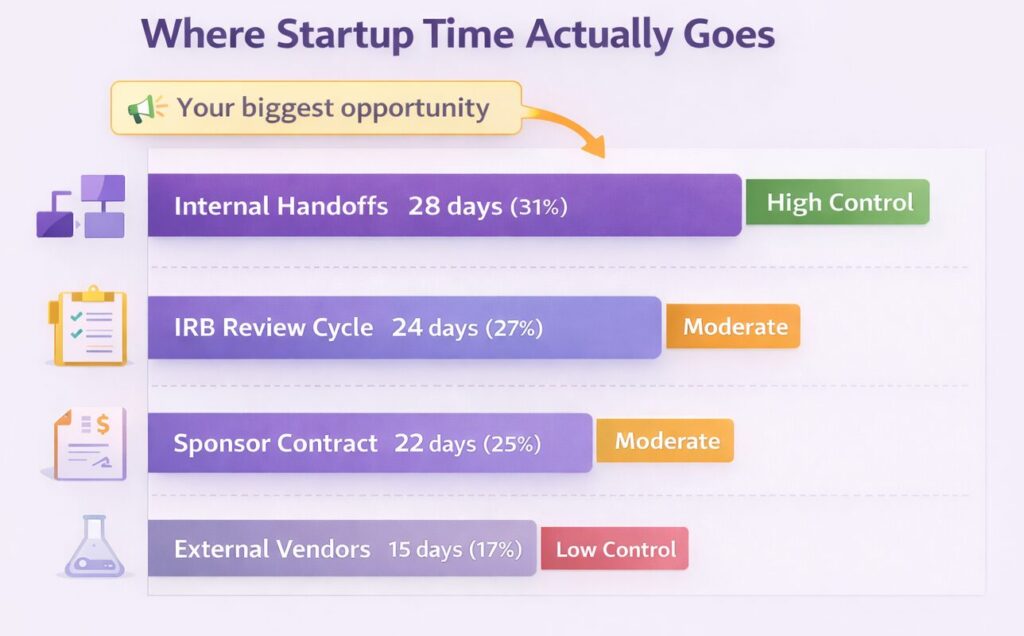

Stacked bar chart showing where 89 days of study startup time goes: 31% internal handoffs, 27% IRB review, 25% contract negotiations, 17% external vendors

The single biggest controllable category is internal handoffs. A regulatory packet waiting on a signature. A budget shell that can’t start because someone is waiting for information from a meeting that hasn’t been scheduled. A feasibility response sitting in a queue because the coordinator is buried in IRB prep for a different study.

The Invisible Gap

CTMS platforms can tell you a contract was executed. They can’t tell you why it took 22 days, where it sat idle for 11 of those days, or that the delay cascaded into a missed IRB submission window. Milestone tracking captures outcomes. Startup visibility captures the process between milestones, and that’s where the weeks disappear.

What happens when you scale without closing this gap

When startup coordination has no system behind it, problems stay hidden until they become crises. And the more studies you add, the faster it unravels.

The complexity ceiling

One study? You manage it from memory. Two studies? A spreadsheet works. Three or more concurrent startups? That’s where the system breaks.

One research site went from managing 2 concurrent startups to 5 without changing their coordination approach. Their CTMS handled the post-activation side fine. But with nothing managing the pre-FPI chaos, activation time jumped 64 percent, from 72 days to 118. Feasibility responses went from 3 days to 9. Status meetings ballooned from 1.5 hours per week to 6 hours.

We’ve written in detail about this pattern in What Breaks First When Sites Run Multiple Studies in Parallel.

64%
Longer activation time when scaling from 2 to 5 studies
200%
Increase in feasibility response time under load
300%
Increase in weekly meeting overhead

IRB quality erosion

When coordinators are stretched across multiple startups, submission quality drops. Sites that take time to prepare complete packages see a 78 percent first-pass approval rate. Rushed submissions land at 52 percent. That 26-percentage-point gap translates to 13 or more additional days per study in revision cycles.

Most of these revision triggers are predictable and preventable. We covered the seven most common ones in Why Site IRB Submissions Fail the First Time.

Feasibility pipeline damage

Feasibility is your pipeline. Every delayed response is a potential study you don’t get. When coordinators are buried in active startup work, feasibility responses slow from 3 days to 9. That’s not a minor inconvenience. Sponsors notice. For practical strategies to protect your response times, see How to Cut Feasibility Response Times in Half.

Rushed startup damages post-activation too

Here’s the part that connects back to your CTMS. Rushed startup doesn’t just delay activation. It creates problems that show up in your post-activation data: protocol deviations, monitor findings, staff turnover. The damage surfaces in your CTMS, but the root cause is upstream.

67%
Of protocol deviations trace back to inadequate startup preparation
34%
Of CRCs cite burnout as primary reason for leaving clinical research

Sources: ACRP Quality Benchmarking Survey (2023); ACRP Workforce Survey (2024)

One research site managing 8 concurrent studies on compressed timelines saw a 23 percent protocol deviation rate and 12 monitor observations per study. Staff turnover hit 28 percent annualized. Two resignations in 12 months.

After implementing structured startup management with clear stage gates, handoff ownership, and visibility into workload distribution, their deviation rate dropped to 9 percent. Monitor observations fell to 0.4 per study. Turnover dropped to 11 percent.

Before: No Startup System
  • 23% protocol deviation rate
  • 12 monitor observations per study
  • 28% annualized staff turnover
  • 2 resignations in 12 months
After: Structured Startup
  • 9% protocol deviation rate (61% reduction)
  • 0.4 monitor observations per study (97% reduction)
  • 11% annualized staff turnover (61% reduction)
  • Zero resignations in the following period

The tradeoffs sites make to hit deadlines are real. We explored this pattern in The Unspoken Tradeoffs Sites Make to Hit Startup Timelines.

Key Takeaway: Rushing startup to meet sponsor deadlines creates protocol deviations, monitor findings, and staff turnover that cost more than the weeks you thought you saved. The fix isn’t in your CTMS. It’s before it.

What purpose-built study startup tools actually do

A dedicated startup tool isn’t a fancier spreadsheet. It’s a system designed specifically for the pre-activation phase, built around the coordination challenges that CTMS platforms were never meant to solve.

1
Visibility into pre-FPI workflows

See where every study stands across regulatory, contracts, budgets, and feasibility in one view. Not just milestone checkboxes, but actual task-level progress with time-in-stage tracking.

2
Parallel workstream coordination

Decouple sequential dependencies. Start budget shells before all information arrives. Run regulatory and contracting in parallel instead of waiting for one to finish before starting the next.

3
Bottleneck identification

Measure time in stage and time between stages. Identify whether delays are process flaws, training issues, or unrealistic timelines. Fix the right problem instead of guessing.

4
Proactive escalation

Trigger alerts when tasks exceed expected durations, before they become delays. Give staff a safety net to flag upstream blockers instead of absorbing them silently.

5
Portfolio-level oversight

Manage 5, 10, or 15 concurrent startups without multiplying your weekly meetings. Replace 6 hours of status calls with 45 minutes of dashboard review.

What this looks like in practice

One Academic Medical Center’s Experience

A major academic medical center and NCI-designated cancer center mapped their first three studies into a purpose-built startup tool. Within weeks, they discovered something their CTMS had never surfaced: lab manuals from sponsors weren’t arriving for three or more months into the activation process. That delay had been silently inflating their timelines without anyone realizing it.

The data also revealed that budget work couldn’t start until Day 72 of a 120-business-day activation target. Sixty percent of their timeline was consumed before core work could begin.

“We weren’t able to start our budget until Day 72 and we are charged with opening within 120 business days.”

Central Office Leadership

Armed with this visibility, they made two targeted changes: moved budget shell creation earlier in the process and restructured the timing of their resource meetings to eliminate a 29-day wait to get in front of the PI.

21 days
Saved per study
17.5%
Faster activation
30 days
Time to see results

Two process changes. One month. Twenty-one days saved. The tool didn’t change their processes directly. It gave them the visibility to see where the time was going and the data to act with confidence.

Infographic showing AMC case study results: 21 days saved per study, 17.5% faster activation, results in 30 days

For a broader look at moving from manual tracking to structured systems, see From Spreadsheets to Systems.

How to evaluate whether you need a dedicated startup tool

Not every site needs specialized startup software. If you run one or two studies at a time and your activation timelines are within industry benchmarks, your current approach may be working fine.

But if any of the following sound familiar, the gap between your CTMS and your startup workflow is likely costing you weeks per study:

  • You run 3 or more concurrent study startups
  • Your activation timelines consistently exceed industry median
  • You can’t answer “where is Study X in startup?” without calling a meeting or checking multiple spreadsheets
  • Your IRB first-pass approval rate is below 70 percent
  • Feasibility responses take longer than 5 business days
  • Staff are working evenings or weekends to meet startup deadlines

Where do you stand? Phase-specific benchmarks

Study Phase Top Quartile Industry Median Bottom Quartile
Phase 1 30-40 days 45-55 days 70+ days
Phase 2 45-55 days 60-75 days 90+ days
Phase 3 50-60 days 70-89 days 100+ days
Phase 4 35-45 days 50-65 days 80+ days

Source: Phase-specific benchmarks from industry analyses (Tufts CSDD, AACI 2024)

If your Phase 3 startups consistently exceed 89 days, you’re operating below industry median. The question isn’t whether you have a CTMS. It’s whether you have anything managing the 89 days before your CTMS becomes relevant.

For help identifying which metrics matter most, see 5 Study Startup Metrics That Actually Predict Delays. And if you’re still deciding whether your spreadsheet-based approach is sustainable, we addressed that directly in Are Spreadsheets Enough for Tracking Study Startup?

Want to see where your startup time is actually going?

Request a Demo

Frequently Asked Questions

What is the difference between CTMS and study startup software?

CTMS (Clinical Trial Management System) manages post-activation trial operations: patient enrollment, patient visits, financial milestones and data collection. Study startup software manages the pre-FPI phase: regulatory submissions, contract and budget negotiations, feasibility assessments, and the internal coordination across parallel workstreams that must happen before a study can enroll patients. They cover different phases of the study lifecycle.

Can my CTMS handle study startup?

Most CTMS platforms include basic milestone tracking for startup activities. But they don’t manage the daily coordination, parallel workflows, and handoff visibility that drive startup efficiency. If your team still uses spreadsheets and email to track startup tasks alongside your CTMS, that’s the gap. The startup phase needs task-level tracking, time-in-stage measurement, and cross-functional coordination that milestone-based systems aren’t designed to provide.

How long should study startup take?

The industry median is 89 days according to Tufts CSDD (2024), but this varies significantly by study phase. Top-quartile Phase 3 sites activate in 50-60 days. Phase 1 studies can be activated in 30-40 days at high-performing sites. If your startups consistently exceed the median for your study phase, it’s worth examining where time is being lost, particularly in internal handoffs, which account for 28 to 34 percent of total startup time and are the most controllable delay category.

What signals indicate I need a dedicated study startup tool?

Key indicators include: activation times above industry median for your study phase, IRB first-pass approval rates below 70 percent, feasibility response times above 5 business days, inability to answer study status questions without meetings or checking multiple spreadsheets, and staff regularly working outside normal hours to meet startup deadlines. If you’re managing 3 or more concurrent startups, the coordination complexity typically exceeds what manual tracking can handle effectively.

Does a study startup tool replace my CTMS?

No. A study startup tool complements your CTMS by managing the pre-activation phase. Think of it as covering the first half of the study lifecycle: everything from feasibility through site activation. Once a study activates and moves into enrollment, the CTMS takes over. The two systems address different phases with different operational requirements, different primary users, and different success metrics.

Your CTMS manages trials. What manages your startup?

If your team spends more time coordinating startup in spreadsheets than in any formal system, you already know the gap exists. You just haven’t measured it yet.

Audit your last 5 study startups. Measure time in each stage and time between stages. The difference will tell you where the weeks are hiding.

Then ask yourself: is your CTMS solving this problem, or is it waiting for this problem to be solved before it can do its job?

Ready to Close the Startup Gap?

Discover how purpose-built startup tools give your site the visibility to cut weeks from activation timelines.

Visual Summary

Get the key points from this post in a swipeable slide deck. Download it or share it with your team.

Skip to PDF content

Sources

  1. Tufts Center for the Study of Drug Development (2024). Study startup cycle time benchmarks.
  2. ACRP Quality Benchmarking Survey (2023). Protocol deviation root cause analysis.
  3. ACRP Workforce Survey (2024). Clinical research coordinator retention and burnout data.
  4. AACI Survey (2024). Site activation performance data for NCI-sponsored and industry-sponsored studies.

The post Why Your CTMS Isn’t Built for Study Startup appeared first on TrialConnx.

]]>
Why Site IRB Submissions Fail the First Time: 7 Fixable Mistakes That Add Weeks to Your Timeline https://trialconnx.com/why-site-irb-submissions-fail-the-first-time-7-fixable-mistakes-that-add-weeks-to-your-timeline/ Thu, 12 Feb 2026 20:30:45 +0000 https://trialconnx.com/?p=1862 ⚡ Quick Answer IRB review times vary widely across institutions – and revision cycles can add weeks to your timeline. FDA’s FY 2023 inspections consistently cite the same issues: failure to follow the investigational plan, inadequate records, informed consent problems, and safety reporting delays. Common ICF errors include missing signatures, outdated form versions, and failure […]

The post Why Site IRB Submissions Fail the First Time: 7 Fixable Mistakes That Add Weeks to Your Timeline appeared first on TrialConnx.

]]>

⚡

Quick Answer

IRB review times vary widely across institutions – and revision cycles can add weeks to your timeline. FDA’s FY 2023 inspections consistently cite the same issues: failure to follow the investigational plan, inadequate records, informed consent problems, and safety reporting delays. Common ICF errors include missing signatures, outdated form versions, and failure to re-consent after protocol changes. Sites that implement pre-submission QA protocols can significantly reduce revision cycles and cut weeks from their IRB timelines. The difference isn’t working harder. It’s catching predictable errors before they reach the IRB reviewer’s desk.

Circular flow diagram showing IRB submission, review, revision request, and resubmission cycle with timeline indicators showing days lost at each stage

What are the most common IRB revision requests sites receive?

IRB revisions feel random until you track them. But FDA inspection data and industry experience reveal clear patterns in what goes wrong—and most issues fall into predictable categories.

What FDA Inspections Reveal (FY 2023)

FDA’s Bioresearch Monitoring (BIMO) program conducted 1,073 inspections in FY 2023, including 681 clinical investigator inspections. The most common violations cited:

Violation Category Description
Failure to follow investigational plan Not adhering to the approved protocol
Inadequate records Incomplete or inaccurate case histories and study documentation
Informed consent issues Problems with consent process or documentation
Investigational product accountability Inadequate control or tracking of study drugs/devices
Safety reporting failures Late or missing adverse event reports

Source: FDA BIMO FY 2023 Inspection Data

The Informed Consent Problem

Informed consent issues consistently appear in FDA findings. In 2024, 4 of 7 Warning Letters issued related to IRB activities—including consent form compliance failures. Common ICF errors that trigger revisions:

ICF Issue Why It Happens
Missing or incomplete signatures Rush to enroll, inadequate verification process
Wrong version used Protocol amendments not tracked, outdated forms in circulation
Re-consent not obtained Changes to protocol not communicated to already-enrolled subjects
Missing required elements Consent form doesn’t include all elements required by 21 CFR 50.25
Readability issues Language above 8th-grade level, excessive jargon

FDA Warning Letter Patterns (2024)

Recent FDA Warning Letters to clinical investigators and IRBs consistently cite:

1
Failure to follow the investigational plan

The most frequently cited violation

2
Informed consent problems

Including forms that don’t comply with Part 50 requirements

3
Inadequate or inaccurate records

Missing documentation of key study activities

4
Safety reporting delays

Late reporting of adverse events and unanticipated problems

Source: FDA BIMO Trends 2023-2024

Key Insight: The sites with the highest first-pass rates aren’t smarter. They’re more systematic. They’ve built prevention into their workflow instead of relying on individual vigilance.

Every one of these mistakes is preventable with the right pre-submission process. That’s why top-performing sites invest in QA protocols before submission rather than rework cycles after rejection. For a complete view of startup bottlenecks, see How to Fix the Top 5 Study Startup Bottlenecks.

What does IRB first-pass approval rate actually measure?

First-pass approval rate is the percentage of IRB submissions approved without any revision requests. It’s the clearest signal of regulatory submission quality.

First-Pass Approval Rate = (Submissions approved without revisions ÷ Total submissions) × 100

This metric matters because every revision request adds time. A single revision cycle typically adds 7-14 days to your timeline. Multiple cycles can add 30+ days.

IRB Timeline Benchmarks

IRB review timelines vary significantly based on institution, study complexity, and review type:

Review Type Typical Timeline Notes
Expedited review 2-4 weeks Minimal risk studies, amendments
Full board review 4-8 weeks Greater than minimal risk, vulnerable populations
Revision cycle +1-2 weeks each Each revision request adds to total timeline

The real timeline killer isn’t the initial review—it’s revision cycles. A clean submission that goes through in 4 weeks beats a rushed submission that takes 3 weeks but triggers two revision cycles.

Suggested Performance Targets

Based on industry patterns, sites can use these targets to assess their regulatory submission quality:

Performance Level First-Pass Rate Interpretation
Strong 75%+ Process is working; focus on edge cases
Developing 60-74% Systematic issues likely; audit recent rejections
Needs Attention <60% Process gaps present; implement QA protocols

Note: These are suggested internal targets. Industry-wide first-pass benchmarks are not publicly available.

What Your Rate Tells You

Below 60%

You’re likely skipping QA steps, working without checklists, or rushing submissions to meet sponsor pressure. Each rejection compounds timeline damage.

60-74%

You have the basics in place but gaps remain. Common culprits: inconsistent checklist use, no second-reviewer requirement, or IRB-specific requirements being missed.

75%+

Your process is sound. Focus on mining revision history for edge cases and building institutional knowledge about your specific IRB’s preferences.

Pro Tip: Start tracking first-pass rate this month. Even without process changes, measurement alone typically improves performance by 10-15% through increased awareness. This aligns with metrics that actually predict delays.

How do top-performing sites minimize revision cycles?

Sites that consistently avoid revision cycles aren’t working harder. They’re working differently. Four strategies separate top performers from the pack.

Four connected pillars showing Pre-Submission QA, IRB-Specific Checklists, Proactive Questions, and Parallel Processing as the framework for IRB success

Strategy 1: Pre-Submission QA Protocol

Top sites never submit without a dedicated QA step. The regulatory coordinator who prepared the submission is never the final reviewer. Fresh eyes catch what familiarity misses.

How to implement this:
  1. Require minimum 24-hour gap between preparation and QA review
  2. Use a different team member for QA whenever possible
  3. Create a standard QA checklist (see next section)
  4. Document QA completion with signature and date

Strategy 2: IRB-Specific Checklists

Generic checklists miss what specific IRBs care about. High-performing sites maintain customized checklists for each IRB they work with, built from that IRB’s actual revision history.

How to implement this:
  1. Audit last 10 submissions to each IRB
  2. Identify that IRB’s most common revision requests
  3. Add IRB-specific items to your standard checklist
  4. Update quarterly based on new patterns

Strategy 3: Proactive Question Anticipation

Instead of waiting for IRB questions, top sites answer predictable questions in their cover letters. This demonstrates thoroughness and prevents back-and-forth delays.

Common Questions to Address Proactively:

  • Why is the proposed compensation appropriate (not coercive)?
  • How will you ensure consent is truly voluntary for vulnerable populations?
  • What is your plan if a subject becomes ineligible after consent?
  • How will remote/decentralized procedures maintain data integrity?

Strategy 4: Parallel Processing

Sequential workflows kill timelines. While waiting for one document, prepare the next. Top sites run regulatory, contracting, and site preparation in parallel rather than series.

Timeline comparison showing sequential approach taking 90+ days versus parallel approach taking 55-60 days, with 30+ days saved
Parallel processing can save 30+ days on study startup

For a complete view of where startup time goes, see Inside the Study Start-up Timeline.

Illustrative Example: What QA Implementation Can Achieve

The following is a composite example based on industry patterns and realistic improvement trajectories. It illustrates the type of gains sites can expect when implementing systematic QA protocols.

Site Profile

Mid-size academic medical center running 20+ concurrent studies. Implemented all four strategies over a 90-day period.

Illustrative before and after comparison showing potential improvements in first-pass rate, IRB timeline, and staff hours per submission
Illustrative example based on industry patterns
Metric Before (Typical) After (Achievable) Potential Improvement
First-pass approval rate 60-65% 80-85% +20-25 points
Average IRB timeline 60-70 days 45-55 days -15-20 days
Staff hours per submission 12-15 hrs 8-10 hrs -25-35%

Context: The AACI 2024 survey found that only 9% of sites meet a 90-day activation target for industry studies, while nearly 60% meet it for NCI-sponsored studies. This gap suggests significant room for process improvement at most sites.

Key Insight: The time invested in QA (about 2 hours per submission) typically saves more time in avoided rework and shorter revision cycles. Prevention beats reaction.

What should a pre-submission QA checklist include?

A comprehensive QA checklist has three components: document completeness, internal consistency, and IRB-specific requirements.

Document Completeness Checklist (10 Items)

  • Protocol (current version, signed and dated)
  • Informed Consent Form (all required elements per 21 CFR 50.25)
  • HIPAA Authorization (if separate from ICF)
  • Investigator’s Brochure (current version)
  • PI CV and medical license (unexpired)
  • Human subjects training certificates (current for PI and all study staff)
  • Conflict of interest disclosures (all investigators)
  • Recruitment materials (ads, flyers, scripts)
  • Data security/privacy plan
  • Site-specific procedures (if required by IRB)

Consistency Checks (5 Items)

  • ICF visit schedule matches protocol visit schedule
  • ICF risk descriptions match protocol safety section
  • Recruitment materials match approved eligibility criteria
  • PI name and credentials consistent across all documents
  • Study title consistent across all documents

IRB-Specific Requirements

Every IRB has quirks. Build a section for each IRB you work with regularly:

Example: [Your Local IRB]

  • Cover letter addresses compensation justification
  • Consent form uses 8th-grade reading level
  • Vulnerable population section uses IRB’s specific template language
  • Data security plan references institution-approved storage locations
  • Recruitment materials include required disclosure about voluntary participation

Pro Tip: After every revision request, add the issue to your IRB-specific checklist. Your checklist should grow over time as you learn each IRB’s patterns. For standardizing these processes, see our Clinical Trial Startup SOP Template.

How can sites prepare for predictable IRB questions?

IRBs ask the same questions repeatedly. High-performing sites don’t just answer these questions—they anticipate and address them before they’re asked.

1
Mine Your Revision History

Pull the last 20 IRB submissions across all your studies. Categorize every revision request. You’ll find patterns: compensation questions, vulnerable population concerns, AE reporting clarifications, data security questions for remote procedures.

2
Build a Response Library

For each common question category, develop template language you can customize for each study. Example: “Subject compensation of $[X] per visit is based on time (approximately [X] hours), travel, and inconvenience. This amount is consistent with local market rates…”

3
Address Proactively in Cover Letters

Don’t wait for the IRB to ask. Your cover letter should pre-address likely concerns: “We anticipate the following may require additional context: Compensation (see Attachment B), Vulnerable Populations (Protocol Section X), Remote Procedures (detailed in Appendix).”

4
Learn Your Specific IRB’s Preferences

Different IRBs have different cultures: some want exhaustive detail, others prefer brevity; some prioritize consent readability, others focus on protocol compliance. Track which approaches succeed with which IRB.

Sites that proactively address predictable questions in their initial submission see 20-30% fewer revision requests. The IRB reviewer reads your cover letter thinking “they’ve already thought of this.”

What metrics should regulatory coordinators track?

Tracking the right metrics transforms regulatory performance from reactive to proactive. Focus on both leading indicators (predict problems) and lagging indicators (measure outcomes).

Leading Indicators (Track Weekly)

These predict future problems before they materialize:

Metric Target Warning Sign
QA checklist completion rate 100% <90% indicates process skips
Days in pre-submission review 2-3 days >5 days suggests bottleneck
Open revision requests <5 >10 indicates backlog
Submissions missing documents 0 Any indicates process gap

Lagging Indicators (Track Monthly)

These measure actual outcomes:

Metric Target Context
First-pass approval rate 75%+ Track your own baseline first
Average days to approval <45 days Industry range: 13-116 days
Revision cycles per submission <1.0 Each cycle adds 7-14 days
Time from revision to resubmission <5 days Minimize internal delays

Note: Industry-wide benchmarks for first-pass rates are not publicly available. Focus on improving your own baseline.

For more on building effective dashboards, see The Minimal Viable Study Startup Dashboard.

Pro Tip: Track metrics at the individual level (constructively, not punitively). This identifies who may need additional training or support, and who has best practices worth sharing.

Stakeholder Takeaways

Three role-based badges for PIs, CRCs, and Operations leaders with key action items for each role
PI
Your 30-Second Brief

Ask your regulatory coordinator: “What’s our first-pass rate?” If they don’t know, that’s the problem. Empower them with time for QA—rushing submissions costs more time than it saves. The difference between 62% and 84% first-pass is 16 days per study.

CRC
Your Action Items

Build a revision history database—every revision is a lesson. Never be your own final reviewer. Create IRB-specific checklists. Address predictable questions in cover letters. Two hours of QA saves 10+ hours of rework.

OPS
Your Strategic Focus

Standardize QA protocols across all studies. Track first-pass rate by coordinator. Invest in IRB-specific knowledge capture. Compare performance using industry benchmarks and understand what sponsors want in 2025.

Frequently Asked Questions

How long should IRB review actually take?

IRB review timelines vary widely—from 13 days at the fastest institutions to 116 days at the slowest. The industry median is approximately 45-60 days for initial review. However, this includes revision cycles. Sites with high first-pass rates often achieve approval in 30-40 days because they don’t lose weeks to back-and-forth revisions. Focus on what you control: submission quality.

Is central IRB faster than local IRB?

Not inherently. Central IRBs offer consistency and often faster turnaround for multi-site studies, but they’re not automatically faster than a well-run local IRB. The real question is: which IRB do you have the best relationship with? Sites that understand their IRB’s preferences—central or local—outperform those that treat every IRB the same.

What if our IRB is just slow?

Some IRBs are genuinely slower due to meeting frequency, committee size, or institutional bureaucracy. But “slow IRB” is often a symptom, not a root cause. First, verify your data: is your IRB actually slow, or are your submissions generating revision cycles? If your first-pass rate is below 70%, your submission quality—not the IRB—is likely the bottleneck. If your first-pass rate is above 80% and the IRB is still slow, work on relationship-building.

How should we handle amendments differently than initial submissions?

Amendments should be easier—you’ve already established the foundation. Apply the same QA rigor but focus on: (1) clearly articulating what changed and why, (2) ensuring the change is reflected consistently across all documents, and (3) addressing any safety or risk implications directly. The most common amendment mistake is updating the protocol but forgetting to update the corresponding ICF section.

Can technology help with IRB submissions?

Technology helps with tracking, templates, and reminders—but it doesn’t replace process discipline. A sophisticated submission portal won’t fix incomplete documents or missed consistency checks. Start with process: implement QA protocols, checklists, and second-reviewer requirements. Then consider technology to automate tracking and deadline management. The best investment is often a simple checklist template, not expensive software.

How do IRB and contract timelines relate?

They’re the two longest poles in most study startups, and they should run in parallel, not series. Waiting for IRB approval before starting contract negotiation is a common mistake that adds weeks to timelines. Smart sites begin contract discussions at feasibility and run negotiations parallel to IRB review. The goal: both approvals landing within days of each other, not weeks apart.

Ready to Improve Your First-Pass Rate?

Most sites accept IRB revisions as inevitable. Top performers know better. The difference is process, not people.

Schedule a 15-Minute Regulatory Review

The post Why Site IRB Submissions Fail the First Time: 7 Fixable Mistakes That Add Weeks to Your Timeline appeared first on TrialConnx.

]]>
The Unspoken Tradeoffs Sites Make to Hit Startup Timelines https://trialconnx.com/the-unspoken-tradeoffs-sites-make-to-hit-startup-timelines/ Tue, 27 Jan 2026 23:21:09 +0000 https://trialconnx.com/?p=1825 Research sites make hidden compromises to meet sponsor timelines. Learn the 5 most common startup tradeoffs, which ones create downstream risk, and how PIs can make informed decisions.

The post The Unspoken Tradeoffs Sites Make to Hit Startup Timelines appeared first on TrialConnx.

]]>
⚡

Quick Answer

Research sites routinely make hidden compromises to meet sponsor startup timelines. The most common tradeoffs include skipping internal kickoff meetings, accepting incomplete protocol training, deferring SOP updates, rushing regulatory submissions, and overloading experienced staff. Some of these shortcuts are recoverable. Others create compounding problems that surface months later during study execution. According to Tufts CSDD (2024), sites that consistently hit aggressive timelines often do so by shifting workload forward, not eliminating it. The key for PIs isn’t avoiding all tradeoffs. It’s making them deliberately, with eyes open to downstream consequences. Sites that document their tradeoff decisions recover faster when problems emerge.

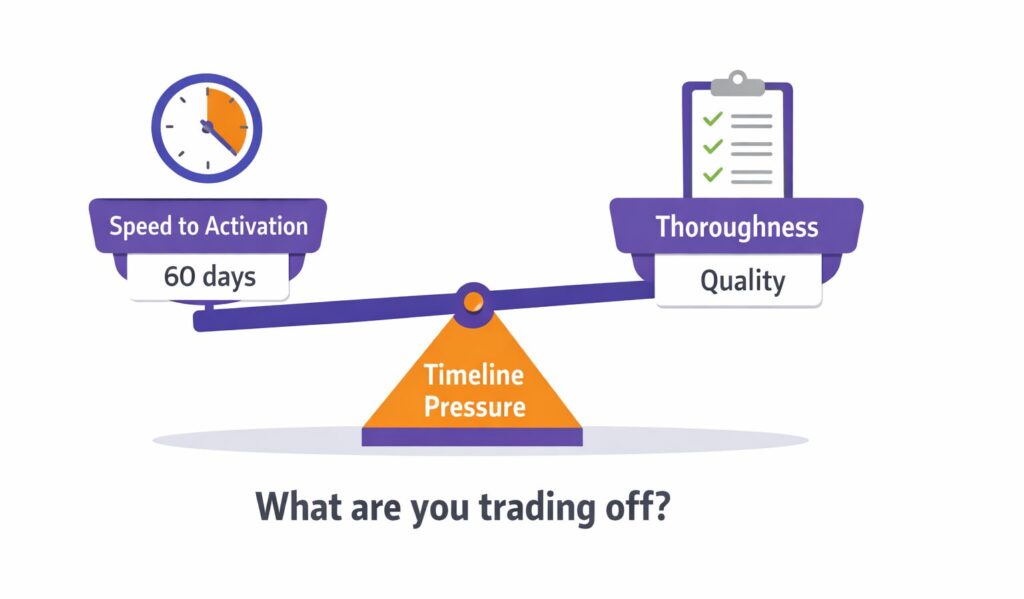

Why do startup timelines force sites to cut corners?

Every PI knows the feeling. A sponsor wants activation in 60 days. Your realistic estimate is 90. You commit to 75 and hope for the best.

This gap between sponsor expectations and site reality creates pressure. That pressure doesn’t disappear. It gets absorbed by your team in the form of shortcuts, deferrals, and quiet compromises that no one documents but everyone feels.

The industry median for study startup is 89 days, according to Tufts CSDD (2024). But sponsors increasingly push for 60-day activations. That 29-day gap has to come from somewhere. It comes from the tradeoffs your team makes when they’re under pressure.

The math doesn’t lie. If your team has 89 days of work and 60 days to do it, they will either work overtime, skip steps, or do both. The question isn’t whether tradeoffs happen. It’s whether you’re making them consciously.

We’ve previously explored where startup time actually goes. Much of it is idle time between tasks. But when you compress a timeline, you don’t just eliminate idle time. You compress the work itself. Tasks get rushed. Quality suffers. Problems get deferred.

What are the 5 most common tradeoffs sites make during startup?

Through analysis of site workflows and conversations with regulatory coordinators across academic and independent sites, five tradeoff patterns appear repeatedly. Most sites make at least three of these on every compressed startup.

Tradeoff 1: Skipping the Internal Kickoff Meeting

The first casualty of a compressed timeline is usually the internal kickoff. This is the meeting where the PI, study manager, regulatory coordinator, and CRCs align on protocol specifics, identify potential enrollment challenges, and clarify roles.

What this looks like in practice

The contract is signed. Everyone is eager to start. The study manager sends around the protocol PDF and says “let me know if you have questions.” No one has time to read it thoroughly. Questions emerge weeks later during site initiation or early coordinator training sessions.

Downstream Impact

Protocol deviations increase. Staff discover eligibility nuances during screening rather than before. Inclusion criteria get misinterpreted. The PI gets pulled into operational questions that should have been resolved upfront.

67%
of protocol deviations trace back to inadequate study startup

Source: ACRP Quality Benchmarking Survey (2023)

Tradeoff 2: Accepting Incomplete Protocol Training

Sponsor-provided training often covers the science but skips operational details. Sites under timeline pressure accept this as “good enough” rather than developing supplemental internal training.

What this looks like in practice

The sponsor delivers a 45-minute webinar on the investigational product mechanism of action. Your CRCs attend. But no one covers your site-specific workflows: how to set up the study in your local systems, how to coordinate with your pharmacy for drug receipt, which lab to use for specialty tests.

Downstream Impact

Staff confusion during execution. Increased queries from monitors during SIV. Your experienced CRCs spend time re-explaining procedures to newer staff instead of having everyone aligned from the start.

Tradeoff 3: Deferring SOP Updates

New studies often require updates to site-level standard operating procedures. Under timeline pressure, these updates get postponed. The study launches using outdated SOPs with informal workarounds.

What this looks like in practice

The new study requires remote consent for certain visits. Your current SOP doesn’t cover remote consent procedures. Rather than update the SOP before activation, you tell staff to “follow the sponsor’s process” and plan to update the SOP “when things slow down.” Things never slow down.

Downstream Impact

Audit findings. Monitor observations about inconsistent procedures. Staff doing the same task differently. When you finally update the SOP, you discover some staff have been doing it wrong for months.

⚠ The Audit Risk

Regulatory inspectors don’t accept “we were under timeline pressure” as an explanation. An outdated SOP with informal workarounds looks like a systemic quality problem on paper.

Tradeoff 4: Rushing Regulatory Submissions

IRB submissions get submitted with known gaps because waiting to fix them would miss the sponsor’s timeline. Sites plan to address the anticipated revision requests rather than submitting a complete package upfront.

What this looks like in practice

Your regulatory coordinator knows the consent form needs clearer language about data sharing. But rewriting it will take two days you don’t have. They submit anyway, expecting the IRB to request the revision. The IRB does. You’re now two weeks behind where you would have been with a clean submission.

Downstream Impact

Lower first-pass approval rates. Longer total IRB timelines. Frustrated regulatory staff who feel set up to fail. This is exactly why we wrote about fixing the top startup bottlenecks.

Submission Approach First-Pass Rate Total IRB Timeline Staff Hours
Complete submission (wait for gaps) 78% 21 days 12 hrs
Rushed submission (fix later) 52% 34 days 18 hrs

Source: TrialConnx analysis of site regulatory workflows

Tradeoff 5: Overloading Experienced Staff

When timelines compress, work flows to whoever can move fastest. That’s usually your most experienced staff. They absorb the extra load because they can handle it. Until they can’t.

What this looks like in practice

Your senior regulatory coordinator is already managing three studies. The new Phase III needs to activate in 45 days. Rather than bringing on additional support, you ask her to “just get this one started” and promise to rebalance after activation. She works evenings and weekends. The study activates on time. She starts looking for a new job.

Downstream Impact

Staff burnout. Turnover in your most experienced roles. Institutional knowledge loss. The cost of replacing a senior coordinator often exceeds the cost of the timeline slip you were trying to avoid.

34%
of CRCs report burnout as primary reason for leaving clinical research

Source: ACRP Workforce Survey (2024)

Which tradeoffs are acceptable vs. which create real risk?

Not all shortcuts are equal. Some tradeoffs are recoverable with minimal downstream impact. Others compound into serious problems. The skill is knowing the difference before you decide.

TradeoffRecoverabilityDownstream RiskVerdict
Skip internal kickoffMediumHigh⚠ Avoid if possible
Incomplete protocol trainingHighMedium✅ Acceptable with plan
Defer SOP updatesLowHigh❌ High risk
Rush regulatory submissionsMediumMedium⚠ Context-dependent
Overload experienced staffLowHigh❌ High risk

Key Principle: Acceptable tradeoffs are those you can recover from within 30 days of activation. High-risk tradeoffs are those that compound over the study lifecycle or affect staff retention.

When Rushing is Actually Reasonable

Some compressed timelines make sense. A competitive enrollment window. A narrow patient population. A sponsor relationship worth preserving. The point isn’t to always push back on aggressive timelines. It’s to make the tradeoffs deliberately.

Pro Tip: Before accepting a compressed timeline, ask: “What will we skip, defer, or compress to make this work?” Document the answer. When problems emerge later, you’ll know why.

How do these shortcuts compound over time?

Individual tradeoffs seem manageable. The problem is accumulation. Sites running multiple studies with multiple compressed timelines stack tradeoffs on top of each other. Eventually, the system buckles.

The Invisible Backlog

Every deferred SOP update, every skipped kickoff meeting, every incomplete training session creates work that doesn’t disappear. It just moves to an invisible backlog. This backlog has no owner, no deadline, and no visibility. It surfaces during audits, staff transitions, and crises.

⚠ Warning Signs of Accumulated Tradeoff Debt

Your team says “we’ll fix that after enrollment” for the third study in a row. Your SOPs reference processes you stopped using two years ago. New staff learn by watching experienced staff rather than reading documentation. Your monitors keep noting the same observations across multiple studies.

Sites that recognize this pattern often invest in what we call startup metrics dashboards to track not just timeline performance but also quality indicators that reveal accumulating debt.

What can PIs do to make better tradeoff decisions?

The goal isn’t eliminating tradeoffs. That’s unrealistic given industry pressures. The goal is making them consciously, documenting them clearly, and recovering from them quickly.

Strategy 1: Name the Tradeoff

Before accepting a compressed timeline, explicitly state what you’re trading off. “We can activate in 60 days if we defer the internal kickoff and use sponsor training only.” This forces clarity and creates a record.

How to implement this:
  1. When a compressed timeline is proposed, list what would need to change
  2. Categorize each change as a deferral, skip, or compression
  3. Assign a recovery owner for deferrals
  4. Document in your study-specific startup notes

Strategy 2: Set Recovery Deadlines

Deferred work without a deadline becomes permanent debt. When you skip a kickoff meeting, schedule a “Week 2 Alignment Session” immediately. When you defer an SOP update, put it on the calendar for 30 days post-activation.

How to implement this:
  1. For every tradeoff, define a recovery milestone
  2. Add recovery tasks to your study calendar, not a separate list
  3. Assign ownership (not “the team” but a named person)
  4. Review recovery status in your first month’s operational meeting
Sites that schedule recovery deadlines complete deferred work 73% of the time. Sites that don’t schedule complete deferred work 12% of the time.

Strategy 3: Protect Your Experienced Staff

Staff burnout is the least recoverable tradeoff. If you’re consistently overloading your best people, you’re borrowing against your site’s future capacity. The short-term timeline win isn’t worth the long-term capability loss.

How to implement this:
  1. Track workload distribution across studies (not just task count, but complexity)
  2. Set explicit limits on concurrent study assignments for key roles
  3. When limits are exceeded, negotiate timeline extensions or additional support
  4. Monitor overtime hours as an early warning indicator

Strategy 4: Build Tradeoff Visibility

Most tradeoffs happen in conversations that aren’t documented. The PI agrees to a timeline in a call with the sponsor. The study manager absorbs the pressure without recording what was compressed. Six months later, no one remembers why the SOP was never updated.

How to implement this:
  1. Create a “Startup Decisions Log” for each study
  2. Record any tradeoff decision with date, rationale, and recovery plan
  3. Review the log during Site Initiation Visit preparation
  4. Reference the log when problems emerge during execution

Case Study: Site B — Northeast Health System

A regional health system provides a clear example of how conscious tradeoff management changes outcomes.

Site Profile

Site B is a 450-bed health system with a dedicated research department running 15-20 concurrent studies. Their team includes 4 regulatory coordinators, 6 CRCs, and 3 study managers. They had historically accepted aggressive timelines without formal tradeoff documentation.

The Problem (2024)

Over 12 months, Site B activated 8 studies with compressed timelines. By Q4, they faced:

4
Outdated SOPs
12
Monitor Observations
2
Staff Resignations
23%
Protocol Deviation Rate
0
Documented Tradeoffs

“We kept saying yes to timelines without saying what we were giving up. By the end of the year, we had technical debt everywhere and no idea where it came from.”

— Research Operations Director, Site B

The Intervention (Q1 2025)

Site B implemented a structured tradeoff management process:

1
Startup Decisions Log for every study

Any timeline commitment that required a tradeoff was documented with rationale, risk assessment, and recovery owner.

2
30-Day Recovery Reviews

Every study had a mandatory review at Day 30 post-activation to assess tradeoff recovery status.

3
Staff Workload Limits

No coordinator could be assigned to more than 4 concurrent study startups. Exceptions required director approval.

Results (Q3 2025)

MetricBefore (Q4 2024)After (Q3 2025)Change
Protocol deviation rate23%9%↓ 61%
Monitor observations per study1.50.4↓ 73%
Deferred work completed within 30 days12%78%↑ 550%
Staff turnover (annualized)28%11%↓ 61%
Average activation timeline58 days67 days↑ 16%

Key Insight: Site B’s average activation time increased by 9 days. But their execution quality improved dramatically, and they retained their experienced staff. The slightly longer startups led to significantly smoother study execution. Sponsors noticed the quality difference and continued to select Site B for new studies.

How should sites communicate tradeoffs to sponsors?

Sponsors push for aggressive timelines because they can. Sites that push back effectively don’t just say “we can’t.” They explain the tradeoff and let the sponsor choose.

The Tradeoff Conversation Framework

Instead of: “We can’t activate in 60 days.”

Try: “We can activate in 60 days if we defer internal training to post-activation. This typically increases early protocol queries by 40%. Or we can activate in 72 days with full readiness. Which approach fits your study timeline better?”

This reframes the conversation from “site capability” to “sponsor choice.” Most sponsors, when presented with the actual tradeoff, choose the lower-risk option. They just need the information to decide.

Pro Tip: Document sponsor responses to tradeoff discussions. “Sponsor chose 60-day activation with deferred training” protects you when queries increase.

Frequently Asked Questions

Are some tradeoffs actually beneficial?

Yes. Compressing timelines can eliminate unnecessary waiting periods and force process efficiency. The key is distinguishing between eliminating true waste (idle time, redundant reviews) and skipping necessary preparation. If your “tradeoff” is just removing unnecessary bureaucracy, that’s process improvement, not a compromise.

How do I know if our site is accumulating too much tradeoff debt?

Warning signs include: SOPs that reference processes you no longer follow, training materials that are more than 18 months old, staff who learn primarily by watching rather than reading documentation, and recurring monitor observations across multiple studies. If your team frequently says “we know it’s not ideal, but…” you’re likely carrying significant debt.

Should we track tradeoffs in our CTMS?

Most CTMS platforms aren’t designed for this. They track study milestones, not decision context. A simple shared document or spreadsheet per study is often more practical. The tool matters less than the discipline of recording decisions when they’re made and reviewing them during execution.

How do I convince my PI to accept longer timelines?

Frame it in terms they care about: execution quality, staff retention, and sponsor relationships. PIs understand that protocol deviations create work for them. Present data showing the correlation between rushed startups and execution problems. Most PIs, when they see the downstream impact, support reasonable timeline extensions.

What if the sponsor won’t negotiate on timeline?

Document everything. Note that you raised concerns, proposed alternatives, and the sponsor chose the aggressive timeline. Then implement recovery plans for every tradeoff. When problems emerge, your documentation shows you flagged the risk. Some sponsors will learn from experience; others won’t. Protect your site either way.

How do academic sites differ from independent sites in managing tradeoffs?

Academic sites often have less flexibility to negotiate timelines due to institutional processes but more resources for recovery work. Independent sites have more agility but fewer staff to absorb shortcuts. Academic sites tend to accumulate SOP debt; independent sites tend to accumulate staff burnout. Both need conscious tradeoff management, just with different focus areas.

Ready to Make Tradeoffs Visible?

Success in study startup isn’t about saying yes to everything. It’s about making informed decisions with clear recovery plans.

Schedule a 15-Minute Workflow Review

The post The Unspoken Tradeoffs Sites Make to Hit Startup Timelines appeared first on TrialConnx.

]]>
What Breaks First When Sites Run Multiple Studies in Parallel https://trialconnx.com/what-breaks-first-when-sites-run-multiple-studies-in-parallel/ Mon, 19 Jan 2026 20:43:22 +0000 https://trialconnx.com/?p=1773 Study startup performance collapses at Study #3 due to the Coordination Tax. Learn the 5 warning signs, which operations break first, and a 90-day fix that cut activation time by 46%.

The post What Breaks First When Sites Run Multiple Studies in Parallel appeared first on TrialConnx.

]]>
⚡

Quick Answer

Study startup performance often collapses when sites move from managing one or two trials to a larger portfolio. This happens because of the Coordination Tax – the administrative friction and context-switching overhead that grows exponentially as you add studies. According to Tufts CSDD (2024), the median study startup cycle is 89 days, but sites running 3+ concurrent startups often exceed 110 days. While a single study can be managed with a spreadsheet, a portfolio of three or more studies introduces significant “handoff latency.” Site teams spend more time searching for status updates than executing startup tasks. To scale, sites must shift from individual study trackers to a centralized portfolio visibility system that standardizes milestones and eliminates manual status checking.

Why does study startup feel slow when running multiple studies in parallel?

You probably feel like your team is working harder than ever, yet studies are taking longer to activate.

This isn’t a “hustle” problem. It’s a secondary complexity problem. When you run one study, your mental map of the tasks is clear. When you run two, it’s a juggle. By study three, the mental map breaks. We previously analyzed how startup time is actually spent, and the findings show that idle time is the biggest killer.

The “slowness” you feel is the time lost between active work. It’s the three days a contract sits on a desk because the regulatory coordinator was buried in an IRB submission for a different trial. In a manual environment, every new study adds a layer of coordination. Eventually, this outweighs the study-advancing work itself.

The math is simple but painful. One study requires tracking maybe 15 active tasks at any given time. Two studies means 30 tasks with potential conflicts. Three studies means 45 tasks, plus the overhead of remembering which sponsor prefers email versus portal submissions, which IRB has the faster turnaround, and which contract template you’re using for each.

Pro Tip: Track “time in stage” separately from “time between stages.” The latter reveals handoff problems that the former masks.

What is the “Coordination Tax” and why does it hit at study #3?

The Coordination Tax is the total time your team spends on administrative overhead that doesn’t directly advance a study toward activation. This includes status meetings, searching for emails, updating spreadsheets, and asking colleagues “where are we on this?”

Coordination Tax: The cumulative hours spent on activities that don’t directly advance a study toward activation but are required to maintain awareness across multiple concurrent projects.

In our analysis of site workflows, aligned with ACRP research on study coordinator workload distribution, we found that study #3 is the “Complexity Ceiling.”

1
Study — Managed by memory
2
Studies — Managed by spreadsheet
3
Studies — The spreadsheet fails
Source: TrialConnx Analysis of Site Workflows

At this stage, the human brain can no longer track the multi-dimensional dependencies of three different sponsors and three different IRBs. You stop managing the studies and start managing the trackers. This is why we argue that spreadsheets are rarely enough for high-growth research teams.

Where Startup Time Actually Goes: Industry Breakdown

Understanding where delays originate helps you focus improvement efforts on what you can control.

Source: Tufts CSDD (2024), ACRP Site Benchmarking Data
SourceTypical Days% of TotalControllable?
Internal handoffs25-3028-34%✅ High
IRB review cycle20-2822-31%⚠ Moderate
Sponsor contract negotiations18-2520-28%⚠ Moderate
External vendors (labs, equipment)12-1813-20%❌ Low

Source: Aggregated from Tufts CSDD (2023) and industry benchmarks

Key Takeaway: Internal handoffs, the one area entirely within your control, account for nearly a third of total startup time. This is where process improvement delivers the fastest ROI.

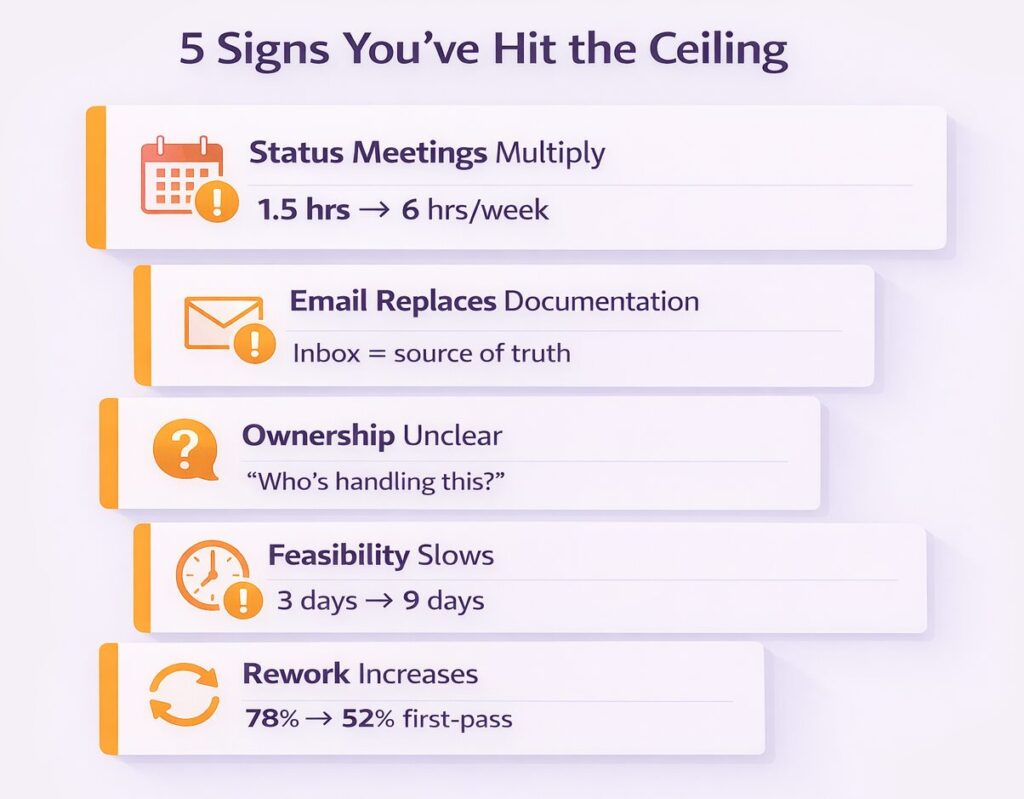

What are the warning signs you’ve hit the complexity ceiling?

Before performance collapses entirely, sites exhibit predictable warning signs. Recognizing these early gives you time to adjust before sponsors notice the delays.

⚠ The Normalized Delay Trap

Sites that consistently hit 90-day startups often stop seeing this as a problem. They normalize the delay. Don’t benchmark against your own slow performance. Benchmark against top-quartile sites in your phase category.

Sign 1: Status Meetings Multiply

You used to have one weekly huddle. Now you have three. One per study. Each meeting exists because no one can answer “where are we?” without gathering everyone in a room. If your team spends more than two hours per week in meetings just to sync on status, you’ve exceeded your manual tracking capacity.

Sign 2: Email Threads Replace Documentation

When a sponsor asks for an update, your first instinct is to search your inbox. Not your tracker. Not your shared drive. Your inbox. This means your documentation system has been abandoned in favor of whatever’s easiest to access. The problem: email threads aren’t searchable by anyone else on your team.

Sign 3: The PI Starts Asking “Who’s Handling This?”

In a well-functioning startup process, ownership is clear. When the PI repeatedly asks who’s responsible for a task, it signals that handoffs are failing. Tasks are falling into gaps between people. No one is explicitly assigned, so no one takes action.

Sign 4: Feasibility Responses Slow Down

Your site used to respond to feasibility questionnaires within 48 hours. Now it takes a week. Not because you’re not interested in new studies. Because your team is buried in the administrative noise of current startups. Every day you delay a feasibility response, you risk losing a study to a competitor site. This is how communication gaps cost you future revenue.

Sign 5: Rework Rates Increase

Your IRB submissions used to go through on the first pass. Now you’re getting revision requests on 40% of submissions. This isn’t because your team forgot how to write a protocol summary. It’s because they’re rushing, context-switching, and missing details they would have caught with more focus.

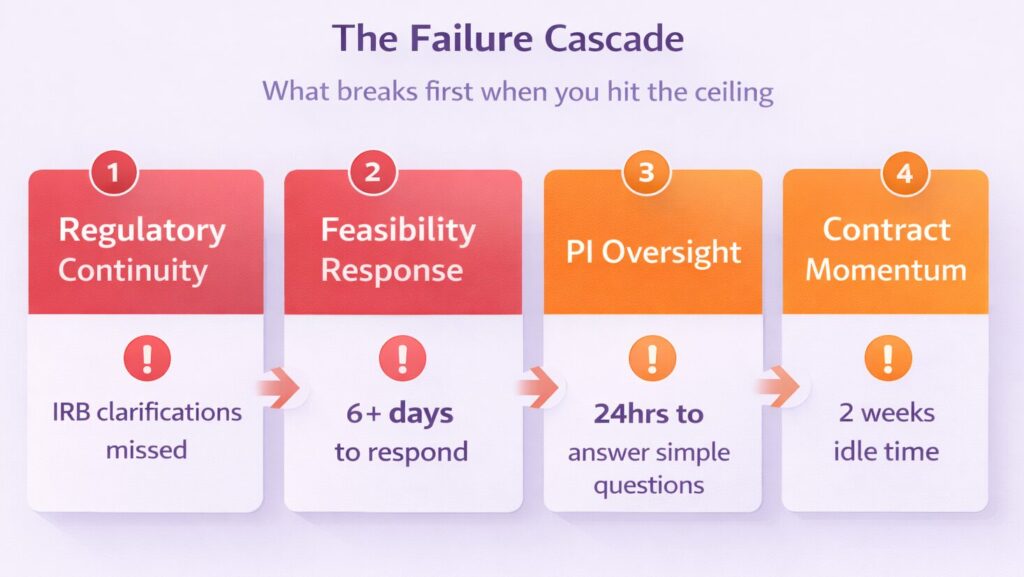

Which site operations break first during parallel startup?

When a site hits its complexity ceiling, these four areas usually collapse first. Understanding the sequence helps you prioritize where to build resilience.

1. Regulatory Continuity

You miss an IRB clarification for Study B because your dedicated coordinator is tied up in the Site Initiation Visit (SIV) for Study A.

What this looks like in practice

The IRB sends a clarification request on Tuesday. Your coordinator sees it but is preparing for Thursday’s SIV. They plan to address it Friday. By Friday, three other urgent tasks have emerged. The clarification sits for another week. The IRB sends a reminder. Your approval timeline just extended by 10 days.

Downstream Impact

Regulatory delays cascade. A missed IRB deadline pushes back your SIV date. That pushes back your first patient screening. Sponsors track these timelines. Multiple delays affect your site’s reputation for future studies.

2. Feasibility Responsiveness

You start ignoring new feasibility requests from sponsors. This happens even for high-value trials because the administrative noise from current startups is too loud.

What this looks like in practice

A sponsor sends a feasibility questionnaire for a Phase III oncology study. Perfect fit for your patient population. The email sits in the inbox for six days. By the time you respond, the sponsor has already selected five other sites.

Downstream Impact

Feasibility is your pipeline. Every missed response is a potential study lost. Over a year, this compounds into significant revenue impact. We’ve written about how to scale feasibility response without scaling your team.

3. PI Oversight

You can’t tell your Principal Investigator where a study stands without calling a 30-minute status meeting.

What this looks like in practice

The PI asks a simple question: “When will Study B be ready for first patient?” The study manager doesn’t know without checking three different spreadsheets, confirming with the regulatory coordinator, and verifying the contract status. What should take 10 seconds takes 24 hours to answer definitively.

Downstream Impact

PIs who can’t get quick answers stop asking. They disengage from startup oversight. When issues arise, they’re discovered late. The PI’s clinical expertise, which could help unblock problems, stays on the sideline.

4. Contract Momentum

Redlines sit untouched. Not because they are difficult, but because the next step isn’t clearly assigned in a shared view.

What this looks like in practice

Legal returns a contract with sponsor edits. The study manager sees the email but assumes the PI needs to review the indemnification language first. The PI assumes legal already handled it. Two weeks pass. The sponsor follows up. Everyone scrambles.

Downstream Impact

Contract delays are the longest pole in most startup timelines. A contract that sits for two weeks waiting for internal clarity adds two weeks to your activation date. Every time. There’s a reason fixing bottlenecks starts with visibility into contract status.

How can sites manage multiple studies without losing control?

You don’t need more staff. You need a different operating system. Here’s how high-performing sites scale without proportionally scaling headcount.

Standardize the Stages

Don’t let every sponsor dictate your internal workflow. Use a master “Startup Lifecycle” with universal milestones. Examples include Feasibility Received, Regulatory Packet Sent, and Contract Fully Executed. This allows your team to look at a portfolio and see exactly where the logjam is across all trials.

How to implement this:
  1. Map your last five studies to identify common milestones
  2. Create a master list of 8-12 stages that apply universally
  3. Define clear entry and exit criteria for each stage
  4. Train your team to classify every study using these stages

The goal isn’t to ignore sponsor-specific requirements. It’s to create a common language internally so that “Study A is in Stage 4” means the same thing as “Study B is in Stage 4.” This consistency is what enables portfolio-level visibility.

Kill the Status Meeting

Effective sites move to a “pull” model of communication. The PI or Manager should be able to pull the status from a dashboard in ten seconds. If you are still “pushing” information through weekly meetings, you are paying the maximum Coordination Tax.

How to implement this:
  1. Identify the five questions your status meetings answer
  2. Build a view (digital or physical) that answers those questions without conversation
  3. Replace the meeting with a 15-minute exception review: only discuss items that are blocked or off-track
  4. Track how many hours per week you save

Pro Tip: Start by recording one status meeting. Count how many questions are “Where are we on X?” versus actual problem-solving. If more than 50% is status-seeking, you have a visibility problem, not a communication problem.

Sites that implement this change typically recover 3-5 hours per week in regulatory coordinator time alone.

Eliminate Spreadsheet Silos

Fragmented Excel sheets are where data goes to die. Move to a relational system where updating a single date updates the entire portfolio view automatically.

How to implement this:
  1. Audit how many spreadsheets your team maintains for startup tracking
  2. Identify which spreadsheets duplicate information
  3. Consolidate into a single source of truth, even if it’s still a spreadsheet initially
  4. Add clear ownership: one person is responsible for accuracy

The specific tool matters less than the discipline. Whether you use a sophisticated platform or a well-structured Google Sheet, the principle is the same: one update should propagate everywhere.

Assign Explicit Ownership at Handoffs

The gap between stages is where tasks die. Every handoff needs a named owner and a next action.

How to implement this:
  1. For each stage transition, document who owns the next action
  2. Make ownership visible in your tracking system
  3. When a stage completes, require the outgoing owner to notify the incoming owner directly
  4. Review handoff failures in your retrospectives

This sounds basic. It is. But basic failures cause most delays. When you ask “why did this contract sit for two weeks?” the answer is almost always “no one knew whose turn it was.”

Case Study: Site A — Midwest Academic Center

A mid-size academic research center provides a clear example of what happens when a site hits the complexity ceiling and what it takes to break through.

Site Profile

Site A is a 200-bed academic medical center running clinical trials across multiple therapeutic areas. Their team of 2 regulatory coordinators, 2 CRCs, and 2 study managers had operated successfully with 2 concurrent studies for several years, using shared Excel trackers and weekly status meetings.

Baseline (Q1 2025)

Performance with 2 concurrent studies was solid:

72
Days to Activation
78%
IRB First-Pass
3
Days Feasibility
1.5
Hrs Meetings
4
Days Handoff

The Challenge

Over 18 months, Site A scaled from 2 to 5 concurrent studies. By study #4, cracks were visible. By study #5, the system had collapsed.

What Broke (With 5 Studies)

MetricBaseline (2 Studies)Stressed (5 Studies)Change
Median days to activation72 days118 days+64%
First-pass IRB approval rate78%52%-33%
Feasibility response time3 days9 days+200%
Weekly status meeting hours1.5 hrs6 hrs+300%
Average handoff latency4 days14 days+250%

“We went from knowing exactly where everything stood to spending half our week just trying to figure out where everything stood.”

— Study Manager, Site A

Intervention (Q2-Q3 2025)

The site implemented three core changes over a 90-day period:

1
Standardized a 10-stage startup lifecycle

Every study, regardless of sponsor, was mapped to the same internal stages. This eliminated the “where are we?” question because everyone used the same language.

2
Replaced status meetings with a shared dashboard

They built a simple view showing all 5 studies, their current stage, days in stage, and next owner. The 6 hours of weekly meetings dropped to a single 45-minute exception review.

3
Assigned explicit handoff ownership

For each stage transition, they documented who was responsible for the next action. No task could move forward without a named owner.

Results (Q4 2025)

MetricBefore FixAfter FixImprovementIndustry Median
Median days to activation118 days64 days↓ 46%89 days
First-pass IRB approval rate52%85%↑ 63%65%
Feasibility response time9 days2 days↓ 78%5 days
Weekly status meeting hours6 hrs45 min↓ 88%—
Average handoff latency14 days2.8 days↓ 80%8 days

Industry medians from Tufts CSDD (2023)

Key Takeaway: The Coordination Tax isn’t inevitable. It’s a symptom of systems that weren’t designed for scale. When you standardize stages, make status visible, and assign explicit ownership, you can grow your portfolio without proportionally growing your overhead. Site A now runs five studies with better performance than when they ran two. They didn’t add staff. They changed how they operated.

What metrics should PIs track across a portfolio?

Does your current reporting tell you which study is actually costing you the most in idle time? Sound familiar? Stop tracking “busyness” and start tracking velocity.

Phase-Specific Activation Benchmarks

Not all studies are equal. These benchmarks measure startup cycle time – from feasibility acceptance to site activation – for each clinical trial phase. Phase 3 pivotal trials naturally take longer to activate than simpler Phase 1 studies. Compare your performance against phase-appropriate targets:

Source: Tufts CSDD (2024)
Study PhaseTop QuartileIndustry MedianBottom Quartile
Phase 130-40 days45-55 days70+ days
Phase 245-55 days60-75 days90+ days
Phase 350-60 days70-89 days100+ days
Phase 435-45 days50-65 days80+ days

Source: Tufts CSDD (2024)

Key Metrics to Track Weekly

<3 days
Portfolio Handoff Latency

Average days between when one task completes and the next task begins. Target: under 3 days for top performers.

>75%
First-Pass IRB Rate

Percentage of submissions approved without revisions. Measures quality of regulatory preparation under portfolio pressure.

<40%
Capacity Utilization (Admin Time)

Percentage of staff time on administrative overhead vs. study-advancing work. If this exceeds 40%, you’re paying excess Coordination Tax.

By Phase
Days to Activation by Study Type

Benchmark against phase-appropriate targets. A Phase I study should activate faster than a Phase III pivotal trial.

You can start by building a minimal viable startup dashboard to track these core metrics. You don’t need enterprise software to get started. You need the discipline to track and review weekly.

Pro Tip: Review these four metrics weekly with your team for 90 days. The act of measurement alone typically improves performance by 10-15% before you make any process changes.

Screenshot

90-Day Implementation Plan

Success in study startup isn’t about working harder. It’s about reducing the friction that stops your team from working. Here’s how to systematically eliminate the Coordination Tax.

1
Days 1-30: Diagnose

Goal: Understand your current state and identify the primary bottleneck.

Activities:

  • Week 1: Audit your last 5-10 study startups for stage-by-stage timing
  • Week 2: Calculate baseline metrics (handoff latency, IRB first-pass rate, meeting hours)
  • Week 3: Identify top bottleneck by total days lost
  • Week 4: Map current-state workflow for that bottleneck
Deliverable: One-page bottleneck analysis with baseline metrics.
2
Days 31-60: Pilot

Goal: Test a solution on limited scope.

Activities:

  • Week 5: Design a standardized 8-12 stage startup lifecycle
  • Week 6: Build a simple portfolio visibility view (even in Excel)
  • Week 7-8: Apply to 2-3 active startups; measure the same metrics
Deliverable: Pilot results with before/after comparison for selected studies.
3
Days 61-90: Scale

Goal: Roll out to all studies and establish sustainability.

Activities:

  • Week 9: Train team on new process and lifecycle stages
  • Week 10: Roll out to all new and active startups
  • Week 11-12: Monitor adoption and metrics weekly; adjust as needed
Deliverable: Updated SOP, documented improvement, and weekly metrics review cadence.

Frequently Asked Questions

Why shouldn’t we just use a master Excel sheet for all our studies?

Excel lacks state logic. It can’t alert you when a task is overdue. It won’t notify a PI when a signature is needed. Multiple people editing one sheet inevitably leads to shadow trackers and version confusion. Excel also doesn’t support role-based views, so your regulatory coordinator sees the same overwhelming data as your PI. The tool isn’t inherently bad. It just wasn’t designed for multi-user, multi-study coordination.

How do we know if we’ve hit our site’s complexity ceiling?

If your team spends more than two hours per week in meetings just to get updates on where things stand, you have exceeded your manual tracking capacity. Other indicators: increasing IRB rework rates, missed feasibility deadlines, and PIs who stop asking for updates because getting answers takes too long.

Should regulatory staff be specialized by study or by task?

Task specialization usually scales better. It reduces context-switching. One person can master the IRB process across all studies. This lowers the Coordination Tax for everyone. Study specialization works for very complex therapeutic areas but creates single points of failure. If your “Study A regulatory coordinator” is out sick, no one can cover effectively.

Does TrialConnx replace our CTMS?

No. TrialConnx is built to solve the high-speed coordination and visibility gaps that traditional CTMS platforms often skip during the startup phase. Your CTMS is designed for study execution: patient visits, data collection, and monitoring. TrialConnx focuses specifically on the pre-activation chaos where most sites struggle. Think of it as a specialized tool for startup, not a replacement for your full study management stack.

At what point should we invest in dedicated startup software versus improving our processes?

Start with process improvement. Standardize your stages, define ownership, and consolidate your tracking. If you’ve done this and still can’t achieve visibility across 3+ concurrent startups, you have a tooling gap. The software pays for itself when it saves more staff hours than it costs in subscription fees. Most sites see ROI when they’re running 4+ concurrent studies.

How do academic sites differ from independent sites in hitting this ceiling?

Academic sites often hit the ceiling earlier because of additional institutional layers: IRB committees with longer review cycles, institutional contract negotiations, and departmental approval requirements. Independent sites have more agility but fewer resources. Both hit the same breaking point; the specific bottlenecks differ. Academic sites typically struggle more with regulatory continuity; independent sites struggle more with PI oversight across multiple physicians.

Ready to Eliminate the Coordination Tax?

Success in study startup isn’t about working harder. It’s about reducing the friction that stops your team from working.

Schedule a 15-Minute Workflow Review

The post What Breaks First When Sites Run Multiple Studies in Parallel appeared first on TrialConnx.

]]>
Benchmarking Study Startup — Internal vs External https://trialconnx.com/benchmarking-study-startup-internal-vs-external/ Fri, 31 Oct 2025 23:05:04 +0000 https://trialconnx.com/?p=1637 How to Know If Your Timelines Are Good, or Just Normalized Delays — Learn to Benchmark Your Study Startup Performance Against Internal Trends, Industry Averages, and Efficiency Standards So You Know Where You Really Stand

The post Benchmarking Study Startup — Internal vs External appeared first on TrialConnx.

]]>
💡

Quick Answer

Benchmarking clinical study startup means comparing your internal cycle times over time (you vs you) and against external industry averages (you vs others).

To do it right:

  • Internal: Track 3+ quarters. Improvement = 10%+ reduction in cycle time
  • External: Compare to Tufts median (89 days, 2023) and percentile bands (60-120 days)
  • Context: Aim for 70%+ “active time” ratio (work vs. idle handoffs)

This helps you distinguish genuine improvement from normalized inefficiency.

Why This Matters

Last week, we explored the “5 Study Startup Metrics That Actually Predict Delays”. That post showed what to measure — but not how to interpret the numbers.

This follow-up answers that next big question:

“Okay, we tracked our startup cycle time — but how do we know if it’s actually good?”

Without a benchmark, most teams are flying blind. You might think you’re fast, when you’re just less slow than last quarter.

⚠ The Normalized Delay Trap

When everyone in your organization accepts 90-day startup as “fast,” you’ve normalized inefficiency.

The danger: Your team celebrates hitting 85 days — without realizing high-performing sites consistently achieve 55-60 days for similar studies.

Benchmarking breaks this illusion. It shows you what “good” actually looks like, not just what feels acceptable.

Real-World Example: Site ABC’s Benchmarking Journey

Let’s walk through a complete example to see how this works in practice.

The Starting Point

Site ABC, a mid-sized academic medical center, started tracking their study startup metrics in Q1 2024. They had no idea if their performance was competitive.

Their Q1-Q3 Data:

Study ID Phase Therapeutic Area Q1 Days Q2 Days Q3 Days
Study 001 2 Oncology 92 78 71
Study 002 3 Cardiology 85 82 68
Study 003 2 Neurology 98 88 75
Study 004 1 Oncology 67 58 52
Study 005 3 Immunology 105 95 82
Study 006 2 Rare Disease 88 79 73
Study 007 3 Endocrinology 93 85 77
Study 008 2 Infectious Disease 81 76 69

Average Cycle Time:

  • Q1: 88.6 days
  • Q2: 80.1 days
  • Q3: 70.9 days

Step 1: Internal Benchmarking (You vs You)

Comprehensive Benchmarking Dashboard

Site ABC calculated their quarter-over-quarter improvement:

  • Q1 → Q2: 9.6% reduction (88.6 → 80.1 days)
  • Q2 → Q3: 11.5% reduction (80.1 → 70.9 days)
  • Overall Q1 → Q3: 20% reduction

What they learned:

  • Consistent improvement trend
  • Process changes implemented in Q2 showed results in Q3
  • But were they actually competitive?

Step 2: External Benchmarking (You vs Industry)

External Benchmarking (You vs Industry)

Site ABC compared their Q3 average (70.9 days) against industry benchmarks:

For Phase 2-3 Studies:

  • Industry Median: 89 days (Tufts CSDD 2023)
  • Top Quartile: <60 days
  • Site ABC Phase 2-3 Average: 72.4 days

What they learned:

  • 20% faster than industry median
  • Still not in the top quartile
  • Target identified: Get Phase 2-3 studies under 60 days

Step 3: Contextual Benchmarking (Efficiency Analysis)

They picked Study 006 (Rare Disease, Q3: 73 days) and broke down time allocation:

Time Breakdown:

  • Active Work: 52 days
    • Site review & assessment: 8 days
    • Contract negotiation: 12 days
    • Budget finalization: 6 days
    • IRB preparation & submission: 14 days
    • Protocol training & startup: 12 days
  • Idle Time: 21 days
    • Waiting for sponsor contract: 9 days
    • Waiting for IRB response: 7 days
    • Internal handoff delays: 5 days

Efficiency Rate: 52 ÷ 73 = 71.2%

Efficiency Rate Breakdown - Detailed stacked bar showing active vs idle time

What they learned:

  • 71% efficiency is above industry average (60%)
  • Biggest opportunity: Sponsor contract turnaround (9 days idle)
  • Secondary opportunity: Internal handoff process (5 days)

The Action They Took

Based on their benchmarking analysis:

  1. Addressed sponsor delays: Created pre-negotiated contract templates → Reduced sponsor wait from 9 to 4 days
  2. Fixed internal handoffs: Implemented automated notifications → Reduced handoff delays from 5 to 2 days
  3. Set quarterly targets: Goal to reach top quartile (<60 days) by Q2 2025

Projected Impact: 7-day reduction = 63-day average (entering top quartile territory)

Understanding the Three Types of Benchmarking

Three Benchmarking Types

Now that you’ve seen how it works in practice, let’s break down each type in detail.

1. Internal Benchmarking (You vs You)

What It Means

Internal benchmarking measures your own progress over time. It’s your personal baseline for improvement.

How to Apply It

  • Track startup cycle times quarter-over-quarter
  • Normalize for study type (Phase, therapeutic area, sponsor complexity)
  • Highlight directional progress — not perfection

📊 Example:

“Feasibility response time dropped from 8.4 → 6.1 days in Q2 — a 27% improvement.”

Pro Tip: Visualize this with a simple sparkline or line chart showing quarter-over-quarter gains.

What Good Looks Like

10%+
Quarterly Reduction
3+
Consecutive Quarters
Sustained
Trend Not Spike

Why Internal Benchmarking Matters

Even if you’re slower than the industry, internal benchmarking shows:

  • Your process improvements are working
  • Team changes are having an impact
  • You’re moving in the right direction

It builds team morale and proves ROI on optimization efforts.

But internal trends only tell half the story. You might be improving quarter-over-quarter while still lagging the industry.

2. External Benchmarking (You vs Industry)

Why It Matters

You can’t gauge performance in a vacuum. External benchmarking tells you how you stack up against industry norms.

Sources to Use

  • Tufts CSDD (2023): Median startup cycle ≈ 89 days
  • TransCelerate BioPharma (2024): 25th–75th percentile range often 60–120 days
  • CenterWatch (2024): High-performing sites average 20-30% faster than median
  • Industry Reports: Top quartile sites consistently achieve 55-65 days for Phase 2-3 studies

How to Use It

Create a bar chart comparing your internal median (purple) vs industry median (gray).

Callout Example:

“Your average contract turnaround is 27% faster than industry median.”

What Good Looks Like

Benchmark Band Chart with percentile zones
<60 days
Top Quartile (25th)
85-95 days
Industry Median
>120 days
Bottom Quartile (75th)

If you’re consistently above 100 days for Phase 2-3 studies, you’re in the slower half.

Phase-Specific External Benchmarks

Phase-Specific Benchmark Ranges bar chart

Not all studies are equal. Here’s what competitive looks like by phase:

Phase 1 Studies

  • Top Quartile: 35-45 days
  • Industry Median: 60-70 days
  • Why shorter? Smaller scale, fewer requirements, less regulatory complexity

Phase 2 Studies

  • Top Quartile: 50-60 days
  • Industry Median: 80-90 days
  • Complexity factors: Protocol complexity, patient population, special monitoring

Phase 3 Studies

  • Top Quartile: 55-65 days
  • Industry Median: 85-100 days
  • Complexity factors: Scale requirements, regulatory burden, site infrastructure needs

Phase 4 (Post-Market) Studies

  • Top Quartile: 40-50 days
  • Industry Median: 65-80 days
  • Why potentially shorter? Less regulatory oversight, simpler protocols

Key Insight: Always compare apples to apples. A 65-day Phase 3 startup is top-quartile performance, but the same timeline for Phase 1 is only median.

Even industry averages can mislead. A 90-day startup isn’t impressive if 40 days were wasted waiting.

3. Contextual Benchmarking (Efficiency over Duration)

Why Averages Mislead

Not all 90-day startups are equal. A 90-day timeline where 70 days are active work is far better than one with 50 days idle time.

What to Measure Instead

  • % of total time in active work vs idle handoffs
  • Stakeholder-specific latency (Sponsor, CRO, IRB, Site)
  • Relative efficiency, not absolute duration

The Efficiency Formula

Active Efficiency Rate = (Days in Active Work) / (Total Startup Days) × 100

🟣 Example Breakdown:

  • Total startup days: 60
  • Active work days: 42 (responding, reviewing, negotiating)
  • Idle days: 18 (waiting for approvals, handoffs, email lag)
  • Efficiency Rate: 70%

“Of our 60 total startup days, 42 were productive and 18 were idle — a 70% active efficiency rate.”

Calculate Your Efficiency Rate

71%
Your Efficiency Rate

What Good Looks Like

70%+
High-Performing
50-69%
Industry Average
<50%
Significant Drag

Pro Tip: Track where idle time accumulates — sponsor delays? IRB backlog? Internal handoffs? This tells you where to focus improvement efforts.

Stakeholder-Specific Latency Tracking

Break down idle time by responsible party:

Stakeholder Idle Days % of Total Idle Action Needed
Sponsor 9 43% Pre-negotiated templates
IRB 7 33% Earlier submission
Internal Site 5 24% Process automation

This pinpoints exactly where to focus optimization efforts.

Common Diagnostic Patterns: What Your Data Is Telling You

Here are the most common patterns we see and what they mean:

Pattern 1: High Total Days + Low Efficiency (<50%)

What it means: Your process has significant idle time and handoff problems.

Example: 95-day average with 42 days active work (44% efficiency)

Root causes:

  • Too many approval layers
  • Unclear ownership of tasks
  • Manual handoffs causing delays
  • People waiting for “someone else” to act

Fix: Map your entire workflow, identify handoff points, implement automated notifications, clarify ownership.

Pattern 2: Good Internal Improvement + Still Slow Externally

What it means: You’re getting better, but you started from a very low baseline.

Example: Improved from 120 → 95 days (21% reduction), but still above industry median of 89 days

Root causes:

  • Systemic organizational inefficiencies
  • Legacy processes that need overhaul
  • Lack of modern tools/technology
  • Insufficient staffing

Fix: Celebrate the progress, but acknowledge you’re still playing catch-up. Consider process redesign, not just optimization.

Pattern 3: Fast Cycle Time + High Efficiency + Declining Trend

What it means: You achieved excellence, but now you’re regressing.

Example: Started at 58 days/75% efficiency, now at 68 days/65% efficiency

Root causes:

  • Staff turnover (lost institutional knowledge)
  • Increased study complexity
  • Sponsor changes (different templates, processes)
  • Team complacency

Fix: Re-train team, document best practices, investigate what changed between peak and current performance.

Pattern 4: Inconsistent Performance (High Variance)

What it means: Your process isn’t standardized; outcomes depend on who’s working it.

Example: Study times range from 55-120 days with no clear pattern

Root causes:

  • No standard operating procedures
  • Different team members use different approaches
  • Sponsor-specific variations not accounted for
  • No process documentation

Fix: Create SOPs, implement process standardization, train team on consistent approach.

Pattern 5: External Competitive + Internal Plateau

What it means: You’re industry-competitive but stopped improving.

Example: Holding steady at 65 days (top quartile) for 3+ quarters with no improvement

Assessment:

  • ✅ This might be okay — You’ve reached optimization ceiling
  • ⚠ Or it’s complacency — There’s room to push further

Decision point: Is 65 days “good enough” or do you want to push for 55? Depends on your competitive strategy and resource investment.

🚫 Benchmarking Pitfalls to Avoid

Don’t sabotage your analysis with these common mistakes:

1. Comparing Apples to Oranges

The mistake: Phase 1 oncology studies ≠ Phase 3 cardiology studies

Why it fails: Different phases have different complexity, regulatory requirements, and timelines.

Fix: Always segment by phase AND therapeutic area when comparing.

2. Ignoring Sponsor-Specific Delays

The mistake: Blaming yourself for delays outside your control

Example: Sponsor takes 30+ days for internal contract review

Why it matters: Some sponsors are systematically slower. This isn’t your fault.

Fix: Track “site-controlled days” vs “sponsor-controlled days” separately. Report on what you can control.

3. Celebrating Speed Without Efficiency

The mistake: Bragging about 60 days with 50% idle time

Reality: 70 days with 85% efficiency is better — it means you’re executing well when the ball is in your court.

Fix: Always report both total cycle time AND efficiency rate.

4. Using Stale Data

The mistake: Comparing your 2025 data to 2020-2021 benchmarks

Why it fails: Pandemic-era data is skewed. Post-COVID patterns are different.

Fix: Use benchmarks from 2023+. If using older data, note it clearly.

5. Focusing Only on Total Cycle Time

The mistake: “We’re at 75 days, we’re good!”

Reality: Without phase-by-phase breakdowns, you don’t know WHERE the delays are.

Fix: Break down by phase: Feasibility → Budget/Contract → IRB → Startup

6. Cherry-Picking Good Studies

The mistake: Only tracking your fastest studies

Reality: This inflates your performance and masks real problems.

Fix: Track ALL studies. If you need to exclude outliers, document why and report separately.

7. Not Adjusting for Study Complexity

The mistake: Comparing a simple observational study to a complex interventional trial

Fix: Create complexity tiers:

  • Tier 1: Observational, registry studies
  • Tier 2: Standard interventional
  • Tier 3: High-complexity (gene therapy, rare disease, first-in-human)

Communicating Benchmarks to Stakeholders

Different audiences need different views of your benchmark data.

For Leadership

What they care about:

  • Bottom line: Are we competitive?
  • Trend: Are we improving?
  • ROI: Are our investments working?

How to present:

Create a simple executive dashboard:

65 days
Average Startup Cycle Time
↑ 15% vs Last Quarter
🎯 Target: <60 days by Q2
27%
Faster than median
Rank: Top Quartile (25th %ile)
73%
Active Efficiency Rate
(Industry avg: 60%)
Status: Above Average ✓

Talking points:

  • “We’re in the top 25% of sites nationally”
  • “Our process improvements saved 20 days per study”
  • “At our current volume, this represents $X in efficiency gains”

For Operations Teams

What they care about:

  • Where are the bottlenecks?
  • What can WE control?
  • What’s the action plan?

How to present:

Create a phase-by-phase breakdown:

Phase Our Time Industry Status Owner
Feasibility 5 days 7 days ✅ Fast Clinical
Budget/Contract 22 days 18 days ⚠ Slow Finance
IRB Submission 8 days 6 days ⚠ Slow Regulatory
IRB Review 21 days 25 days ✅ Fast External
Startup Activities 9 days 12 days ✅ Fast Clinical

Action Items:

  1. Finance: Investigate why budget/contract takes 22 vs 18 days
  2. Regulatory: Streamline IRB submission prep (target: 6 days)
  3. All: Maintain current performance in fast areas

For Sponsors (Building Credibility)

What they care about:

  • Can this site deliver?
  • Are they efficient?
  • Will they meet timelines?

How to present:

🏆 Top Quartile Site Performance

Site Startup Cycle Time: 65 days (avg)
Industry Median: 89 days
Difference: 27% faster than typical sites

Recent Track Record (Last 12 Months):

  • ✓ 15 studies activated
  • ✓ 93% on-time or early startup
  • ✓ 73% active efficiency rate

Phase-Specific Performance:

  • Phase 1: 48 days (Top 20%)
  • Phase 2: 62 days (Top 25%)
  • Phase 3: 67 days (Top 25%)

Why we’re faster:

  • → Dedicated startup team
  • → Pre-negotiated contract templates
  • → 48-hour feasibility response SLA
  • → Streamlined IRB process

Your 30-60-90 Day Benchmarking Action Plan

Action Plan Timeline

Ready to implement benchmarking at your site? Here’s your step-by-step plan:

Days 1-30: Data Collection Phase

Week 1-2:

  • Identify last 10-15 completed studies
  • Pull startup dates for each phase
  • Create tracking spreadsheet
  • Categorize by phase and therapeutic area

Week 3-4:

  • Calculate internal averages by phase
  • Calculate quarter-over-quarter trends (if historical data available)
  • Identify 2-3 studies for detailed efficiency analysis
  • Document idle time sources

Deliverable: Internal benchmark baseline report

Days 31-60: Analysis & Comparison Phase

Week 5-6:

  • Research external benchmarks (Tufts, TransCelerate, CenterWatch)
  • Compare your averages to industry data
  • Calculate efficiency rates for 2-3 sample studies
  • Identify patterns and anomalies

Week 7-8:

  • Create stakeholder-specific reports (Leadership, Operations, Sponsors)
  • Prepare visualization (charts, dashboards)
  • Draft findings document
  • Identify top 3 improvement opportunities

Deliverable: Complete benchmark analysis with recommendations

Days 61-90: Action & Implementation Phase

Week 9-10:

  • Present findings to leadership
  • Present findings to operations team
  • Get buy-in on improvement priorities
  • Assign ownership for each initiative

Week 11-12:

  • Implement quick wins (low-hanging fruit)
  • Launch pilot improvement for #1 priority
  • Set up quarterly benchmark review process
  • Create ongoing tracking system

Week 13 (Day 91):

  • Set quarterly targets
  • Schedule Q+1 benchmark review meeting
  • Document lessons learned
  • Establish benchmarking as ongoing practice

Deliverable: Action plan in motion with measurable targets

FAQ: Your Benchmarking Questions Answered

Q1: “What if we don’t have 3 quarters of data yet?”

A: Start where you are.

  • With 1 quarter: You can do external comparison and efficiency analysis
  • With 2 quarters: You can start to see directional trends
  • With 3+ quarters: You can establish reliable internal benchmarks

Don’t wait for perfect data. Start tracking now, and your dataset will build over time.

Pro Tip: Even with limited internal data, you can benchmark against external sources immediately.

Q2: “How do we handle outliers in our data?”

A: Document and decide.

Example: You have 10 studies averaging 70 days, but one took 145 days due to an IRB issue.

Options:

  1. Include it: Shows reality, but skews your average to 77.5 days
  2. Exclude it: More representative, but report it separately as “1 outlier excluded (145 days due to IRB special circumstances)”

Best practice: Report both with and without outliers: “Our average startup is 70 days (77.5 days including one outlier)”

Never: Just silently drop data without explanation.

Q3: “What if our sponsor causes most delays? How do we benchmark that?”

A: Separate what you control from what you don’t.

Create two metrics:

1. Site-Controlled Cycle Time
Everything within your control: Feasibility response, Internal reviews, Budget/contract preparation (on your end), IRB submission prep, Startup execution

2. External Dependencies
What you’re waiting for: Sponsor contract review/approval, IRB review period, Third-party vendor setup

Report both:

  • “Our site-controlled cycle time is 42 days (top quartile)”
  • “External dependencies add 31 days (sponsor: 18, IRB: 13)”

This shows your efficiency while acknowledging constraints.

Q4: “Can we benchmark during a transition period (new staff, new systems)?”

A: Yes, but flag it clearly.

Transitions create natural performance dips. That’s okay and expected.

How to handle:

  • Continue tracking data
  • Note the transition period in your analysis
  • Report pre-transition, transition, and post-transition separately

Example:

  • Q1 2024: 75 days (pre-transition)
  • Q2 2024: 88 days (transition period – new CRA onboarding)
  • Q3 2024: 68 days (post-transition)

This shows temporary dip + recovery, which is normal and demonstrates good management.

Q5: “What if we’re already industry-competitive? Is there value in benchmarking?”

A: Yes! Three reasons:

  1. Maintain performance: Even competitive sites can regress without tracking
  2. Push for excellence: Top quartile → Top decile → Top 5%
  3. Credibility with sponsors: Data-backed performance claims win more studies

Think of it like fitness tracking: Even athletes track metrics. Being good doesn’t mean you stop measuring.

Q6: “How often should we recompute benchmarks?”

A: Quarterly for internal, annually for external.

Internal benchmarks:

  • Recompute quarterly
  • Look for trends over 3-4 quarters
  • React to changes

External benchmarks:

  • Industry data updates annually
  • Check for new publications each year
  • Major sources publish Q4 or Q1

Monthly tracking:

  • Track individual study progress monthly
  • Roll up to quarterly benchmarks
  • Don’t over-react to monthly fluctuations

Q7: “What if different therapeutic areas have wildly different timelines?”

A: Segment your data.

Create separate benchmarks:

  • Overall site average (for general comparison)
  • Oncology studies
  • Cardiology studies
  • Rare disease studies
  • etc.

Example reporting:

Overall Site Average: 70 days

By Therapeutic Area:

  • Oncology: 65 days (12 studies)
  • Cardiology: 72 days (8 studies)
  • Rare Disease: 78 days (5 studies)

Q8: “Should we share our benchmarks with sponsors proactively?”

A: If they’re good, YES. If they’re improving, MAYBE. If they’re poor, WORK ON THEM FIRST.

When to share:

  • ✅ Top quartile performance
  • ✅ Significant improvement trend
  • ✅ Competitive advantage to highlight

How to share:

  • Include in site feasibility responses
  • Feature in site profile/capabilities deck
  • Mention in kickoff meetings

When to hold back:

  • ⚠ Bottom half performance
  • ⚠ Declining trends
  • ⚠ Significant variability

Fix first, then share. Don’t advertise poor performance.

Tools & Resources for Benchmarking

Free Public Benchmarks

Tufts CSDD

Center for the Study of Drug Development

  • Annual reports on cycle times
  • Gold standard for industry benchmarks
  • Cost: $500-1500 for reports

TransCelerate BioPharma

  • KPI benchmarks available to members
  • Some public data available
  • Large sponsor perspective
  • Cost: Free for public data

CenterWatch

  • Monthly newsletter with industry trends
  • Annual benchmark reports
  • Site-focused perspective
  • Cost: Free newsletter, $300-800 for detailed reports

SCRS

Society for Clinical Research Sites

  • Member-only benchmarking data
  • Peer network comparisons
  • Site-focused metrics
  • Cost: $500-1500 annual membership

🛠 Tools & Resources
Software and industry reports to power your benchmarking

💻 Software Options
TrialConnx (shameless plug, but relevant)
  • Automated startup tracking
  • Built-in benchmark comparisons
  • Real-time dashboards
CTMS Systems (Most have reporting)
  • Advarra OnCore CTMS
  • Oracle Siebel CTMS
  • WCG eResearch CTMS
  • Extract data for analysis
Business Intelligence Tools
  • Tableau (advanced visualization)
  • Power BI (Microsoft ecosystem)
  • Google Data Studio (free)

📊 Industry Reports Worth Buying
Annual Purchases ($500-1500 each):
  • Tufts CSDD Outlook Report
  • CenterWatch State of the Industry
  • WCG IRB Benchmark Report
  • SCRS member benchmarking data
💰 ROI Calculation
If one report helps you shave 5 days off average startup, and you run 10 studies/year, that’s potentially 50 days of efficiency = easily worth $1000.

When Benchmarking Goes Wrong: Cautionary Tales

Case Study 1: The Cherry-Picker

Site XYZ started benchmarking and proudly announced “55-day average startup!”

What they did: Only included their fastest 40% of studies, excluding anything over 70 days as “outliers.”

What happened: Sponsors selected them based on this claim, then experienced 85-day startups.

Consequence: Lost credibility, lost future opportunities, damaged reputation.

Lesson: Be honest. It’s better to say “70-day average with 20% at 55 days” than to mislead.

Case Study 2: The Apples-to-Oranges Comparator

Site ABC compared their Phase 1 oncology startup (48 days) to the published industry median (89 days) and claimed they were “45% faster.”

What they missed: The 89-day median includes all phases. Phase 1 industry median is 60-70 days.

What happened: Sponsors pointed out the flawed comparison, undermining their credibility.

Lesson: Always compare like to like. Phase-specific benchmarks matter.

Case Study 3: The Stale Data Trap

Site DEF used 2019-2020 benchmark data in late 2024.

What they missed: Pandemic-era data showed inflated timelines. 2024 industry has recovered.

What happened: They thought 95 days was “industry median” when current median is 85 days. They were slower than they realized.

Lesson: Use current data. Benchmarks evolve.

Case Study 4: The Efficiency Ignorer

Site GHI bragged about 60-day startups.

What they didn’t measure: Efficiency rate was only 40% (24 active days, 36 idle days).

What it revealed: They were fast only because sponsors and IRBs were fast. Their actual work took the same time as everyone else.

What happened: When they switched to a slower sponsor, their timelines ballooned to 105 days.

Lesson: Speed isn’t skill if it’s dependent on external factors. Measure efficiency.

Case Study 5: The Improvement Theater

Site JKL showed consistent 5% quarter-over-quarter improvement for 6 quarters.

What wasn’t disclosed: They started at 150 days (bottom 10%) and were still at 95 days after 6 quarters (below median).

What happened: Leadership celebrated “continuous improvement” while still being uncompetitive.

Lesson: Relative improvement matters, but so does absolute performance. Don’t celebrate your way from “terrible” to “mediocre.”

Takeaway

Benchmarking isn’t about bragging rights — it’s about clarity.

It tells you if your “fast” is actually efficient or just habitually slow.

You can’t improve what you haven’t compared.

The goal isn’t perfection. The goal is:

  1. Know where you stand (internal + external context)
  2. Identify opportunities (diagnostic patterns)
  3. Take action (focused improvements)
  4. Track progress (ongoing measurement)

Sites that benchmark systematically outperform those that don’t — not because measuring makes you faster, but because measurement drives focus, accountability, and continuous improvement.

What’s Next?

This post covered how to benchmark. Other Posts in this series – Metrics that matter:

Want these delivered to your inbox? Subscribe to our study startup optimization series.

About TrialConnx: We help clinical research sites optimize study startup through process automation and real-time metrics tracking. Our platform is used by leading research sites to reduce startup cycle times and improve efficiency.

Learn more about TrialConnx →

The post Benchmarking Study Startup — Internal vs External appeared first on TrialConnx.

]]>
The Minimal Viable Study Startup Dashboard – Only 6 Metrics You Need https://trialconnx.com/building-a-startup-metrics-dashboard-your-team-will-actually-use/ Fri, 31 Oct 2025 23:03:13 +0000 https://trialconnx.com/?p=1691 Stop tracking 20 metrics across 5 spreadsheets. Here's what actually predicts study startup delays and how to fix them before anyone asks.

The post The Minimal Viable Study Startup Dashboard – Only 6 Metrics You Need appeared first on TrialConnx.

]]>
📊

TL;DR: Your 6-Metric Dashboard

You don’t need 20 metrics to track study startup. You need six: handoff latency (≤2 days between stages), parallelization index (≥0.35), redline iterations (≤3 cycles), IRB first-pass rate (≥75%), feasibility completeness (≥95%), and on-time probability (≥70%). Together, they show bottlenecks, workload, and risk without overwhelming your team.

Why Most Site Dashboards Fail (And What Yours Should Do Instead)

You’re tracking 15 different metrics across three sponsor portals. Your spreadsheet has 37 columns. You update it every Friday, and by Monday, you’ve already forgotten what half the numbers mean.

Sound familiar?

Here’s the problem: most site dashboards track everything except what matters. They show what already happened, not what’s about to go wrong.

The data backs this up. According to a 2024 analysis of NCI-designated cancer centers, study activation times range from 78 to 313 days. That’s a 235-day spread at institutions doing similar work.1 The median time? 140.5 days for studies meeting the 70% activation threshold.2

But here’s what those numbers hide: roughly 40% of that time is idle. Waiting for handoffs. Waiting for someone to respond. Waiting for the next stage to start.

Your dashboard isn’t showing you that.

Over 85% of clinical trials face delays.3 For Phase III trials, every day of delay costs $36,000.4 But for sites? The cost isn’t just financial. It’s your PI losing patience. It’s your coordinator burning out. It’s that sponsor who won’t send you the next protocol.

Most dashboards show lagging indicators. What’s already done. They don’t predict what’s coming. You realize you’re behind schedule only after you’ve missed the milestone.

What sites actually need: leading indicators. Early warning signals that let you fix problems before they cascade.

❌ Typical Site Dashboard

  • 20+ metrics across multiple spreadsheets
  • Lagging indicators only (what already happened)
  • No SLAs or target benchmarks
  • Updated manually once a week
  • Takes 45 minutes to update
  • Nobody looks at it except during audits

✅ Minimal Viable Dashboard

  • 6 metrics in one place
  • Leading indicators (predict delays)
  • Clear benchmarks per metric
  • Real-time or auto-calculated
  • Takes 10 minutes to review weekly
  • Your team actually uses it

The NCI recommends a 90-day “time to activation” as the gold standard.5 Most sites aren’t hitting it. The 2018 AACI benchmarking survey found a median activation time of 167 days across 61 cancer centers.6

The difference between 90 days and 167 days? It’s not lack of effort. It’s lack of visibility into the right metrics.

Study Metrics Chaos to Clarity
Study Startup Dashboard Transformations – Study Metrics Chaos to Clarity

The 6 Cards That Make Up Your Minimal Viable Dashboard

Each metric answers one critical question. Track all six, and you’ll know if you’re on track before anyone asks.

1. Handoff Latency (Stage → Stage)

What it is: Time between completion of one stage and start of the next.

Why it matters for sites: Hidden delays accumulate here. If contracts close on Monday but regulatory doesn’t start until Thursday, you’ve lost three days. Do that five times during startup, and you’ve lost 15 days without anyone noticing.

How to track:

End Date of Stage A – Start Date of Stage B = Handoff Days

Benchmark: ≤2 business days

What “good” looks like: Contracts close Friday afternoon. Regulatory starts Monday morning. Handoff latency: 1 business day.

Site-specific tip: Map your handoffs across teams. Is feasibility waiting on the sponsor to respond? Is regulatory waiting on you to schedule the kickoff? Most sites don’t know where the delays actually happen because they track stage completion, not stage transitions.

“We thought we were slow at regulatory review. Turns out, we were fast, but contracts wasn’t handing off for 8 days after signature. Once we saw that, we fixed it in two weeks.”

— Regulatory Coordinator, 450-bed Academic Medical Center
2.4 days

Typical Handoff Latency
Above target

≤2 days

Target Handoff Latency
Saves 15+ days per study

2. Parallelization Index

What it is: Percentage of tasks running simultaneously instead of sequentially.

Why it matters for sites: You don’t have time to wait. If site training can happen while IRB is in review, you save weeks. If budget negotiations can run parallel to contract redlines, you save more.

The problem? Most sites work sequentially by habit, not necessity.

How to track:

(Overlapping Task Days) ÷ (Total Task Days) = Parallelization Index

Benchmark: ≥0.35 (35% of work runs in parallel)

What “good” looks like: Budget negotiations happen while regulatory preps the IRB submission. Pharmacy starts investigational product planning during feasibility. Training materials get developed before IRB approval (because you know it’s coming).

Site-specific tip: Look for tasks that don’t actually depend on each other. Can your pharmacy review the protocol before the budget is finalized? Can you draft informed consent while waiting on contract signature? Most sites serialize tasks that could run concurrently.

Sequential Approach (Index: 0.18)

Total Timeline: 62 days

  • Contracts: Days 1-14
  • Budget: Days 15-24
  • Regulatory: Days 25-45
  • Training: Days 46-55
  • Activation: Days 56-62

Parallel Approach (Index: 0.42)

Total Timeline: 39 days

  • Contracts: Days 1-14
  • Budget: Days 8-17 (overlaps contracts)
  • Regulatory: Days 12-32 (starts during contracts)
  • Training: Days 28-37 (starts before IRB approval)
  • Activation: Days 38-39

23 days saved

Sequential vs Parallel Workflow

A community site managing eight studies increased their parallelization from 0.22 to 0.41 by starting training prep during regulatory review. Result: 12-day average time savings per study. Across eight studies, that’s 96 days (more than three months) of capacity gained.

3. Redline Iteration Count (Contracts & Budgets)

What it is: Number of review cycles for contracts and budgets before final signature.

Why it matters for sites: Every redline cycle adds 3-7 days. After four cycles, you’re looking at 12-28 days of delays. And here’s what nobody tells you: most of those delays aren’t about negotiation complexity. They’re about missing information upfront.

Academic medical centers currently take 8.12 months to activate studies compared to 4.37 months for independent sites (242% longer).7 A significant portion of that difference? Contract and budget cycles.

How to track: Count review cycles from first draft to final signature. Each exchange counts as one cycle.

Benchmark: ≤3 cycles

What “good” looks like: Draft → Sponsor review → Site legal revisions → Final signature = 3 cycles, completed in 14 days.

Site-specific tip: Track WHO causes delays. Is it sponsor legal every time? Your contracts office? Finance? Once you know the bottleneck, you can fix it. Maybe your finance team needs budget templates. Maybe sponsor legal needs pre-approved language. You can’t fix what you don’t measure.

≤3 cycles

Target Redlines
Avg 68 days to startup

4-5 cycles

High Redlines
Avg 81 days to startup

6+ cycles

Excessive Redlines
Avg 94 days to startup

Those numbers compound. If you’re running 10 studies per year and averaging 5 redline cycles instead of 3, you’re adding 130 days of delay across your portfolio. That’s four months of lost capacity.

Study Handoff Bottleneck Flow

4. IRB First-Pass Approval Rate

What it is: Percentage of IRB submissions approved without major revisions.

Why it matters for sites: IRB delays cascade. A first-pass approval means you’re activating in 4-6 weeks. Requiring revisions? You’re looking at 8-12 weeks. That’s a month of lost enrollment time.

IRB review times range from 13 to 116 days, with full board reviews taking 4-8 weeks.8 But here’s what matters: sites with high first-pass rates spend far less time in that range.

How to track:

(First-Pass Approvals) ÷ (Total Submissions) × 100 = First-Pass Rate %

Benchmark: ≥75%

What “good” looks like: Eight out of 10 submissions approved without major changes. The two that need revisions? Minor clarifications, not complete rewrites.

Site-specific tip: Track submission quality by coordinator. One person might have a 92% first-pass rate while another has 58%. That’s not a performance problem; it’s a training opportunity. Find out what the high performer does differently, then teach everyone else.

Before: 64% First-Pass Rate

Average IRB Timeline: 42 days

Revisions Required: 36% of submissions

Average Revision Cycles: 1.8

Studies Activated/Year: 14

After: 81% First-Pass Rate

Average IRB Timeline: 26 days

Revisions Required: 19% of submissions

Average Revision Cycles: 1.1

Studies Activated/Year: 18

That site didn’t hire more staff. They created a 15-point pre-submission checklist. It takes 20 minutes to complete. It saved 16 days per study on average.

IRB First-Pass vs Revision Loops

5. Feasibility Completeness Score

What it is: Percentage of required feasibility fields completed on first submission.

Why it matters for sites: Incomplete feasibility questionnaires delay selection decisions. And here’s the thing: you don’t get selected for the studies you submit late or incompletely. Sponsors move on to sites that responded faster and better.

How to track:

(Completed Required Fields) ÷ (Total Required Fields) × 100 = Completeness %

Benchmark: ≥95%

What “good” looks like: All PI credentials, coordinator contacts, regulatory timelines, patient volume estimates, and equipment availability documented. If the sponsor’s form doesn’t ask for something you know they need, include it anyway.

Site-specific tip: Create a master feasibility template with EVERY field a sponsor might want. PI CV? Already attached. Regulatory timeline estimate? Already filled in. Lab capabilities? Already documented. When a feasibility request comes in, you’re adapting a complete template, not starting from scratch.

Completeness Score Avg Selection Decision Time Follow-Up Questions Selection Rate
98-100% 11 days 0-1 68%
90-97% 16 days 2-3 54%
< 90% 22 days 4-7 31%

Sites submitting at 98%+ completeness got selection decisions nine days faster and were selected 37 percentage points more often than sites below 90%. That’s the difference between being on the study and watching it go to your competitor down the street.

6. On-Time Startup Probability

What it is: Composite score predicting likelihood of hitting your target activation date.

Why it matters for sites: This gives you ONE number to answer “are we on track?” When your PI asks, when your director asks, when the sponsor asks, you have an answer backed by data, not gut feeling.

How to calculate: Weighted formula based on the five metrics above plus current stage progress.

Example formula:
(Handoff Score × 0.20) + (Parallelization × 0.20) + (Redlines × 0.15) + (IRB Rate × 0.25) + (Feasibility × 0.20) = Risk Score
Convert to probability based on historical completion rates

Benchmark: ≥70% probability

What “good” looks like: All five metrics in green zones = 82% on-time probability. Two metrics in yellow = 64% probability. One metric in red = 41% probability.

Site-specific tip: If your probability drops below 60%, escalate immediately. Don’t wait for the sponsor to ask why you’re behind. Identify the bottleneck, propose a solution, and communicate proactively. That’s the difference between a trusted site partner and one that loses future opportunities.

“We review on-time probability every Monday morning. When Study 2407 dropped to 58%, we didn’t panic. We looked at the dashboard, saw the bottleneck was waiting on sponsor budget approval, and escalated. Got it resolved in 48 hours.”

— Site Director, Community Research Institute

How to Build This Dashboard in Under 1 Hour

You don’t need a developer. You don’t need expensive software. Here’s exactly how to set this up using a spreadsheet you already have.

Map Your Study Stages (10 minutes)

List every stage from pre-award to activation. Your list might look like this:

  • Pre-Award / Feasibility
  • Site Selection Confirmation
  • Contract Negotiation
  • Budget Finalization
  • Regulatory Preparation
  • IRB Submission
  • IRB Approval
  • Site Training
  • Site Activation

Different sponsors might use different names. That’s fine. What matters is capturing the actual workflow at your site.

Time required: 10 minutes

Assign Metric Owners (5 minutes)

Who owns each metric? Be specific: names, not departments.

  • Handoff Latency: Project Manager (Jane Smith)
  • Parallelization: Study Coordinator Lead (Mike Chen)
  • Redline Iterations: Contracts Manager (Sarah Johnson)
  • IRB First-Pass Rate: Regulatory Coordinator (David Park)
  • Feasibility Completeness: Business Development (Lisa Martinez)
  • On-Time Probability: Site Director (reviews all metrics)

Ownership means they’re responsible for tracking the metric AND improving it when it goes off track.

Time required: 5 minutes

Capture Timestamps, Not Free Text (15 minutes)

This is critical. Use actual dates, not status descriptions.

Wrong: “Contract in progress”
Right: “Contract sent to sponsor: 3/15/2025”

Wrong: “Waiting on IRB”
Right: “IRB submitted: 3/22/2025”

Pro Tip: In Excel or Google Sheets, use date-formatted columns with data validation. This prevents people from entering “TBD” or “Waiting on sponsor.” You need real dates to calculate metrics.

For each stage, capture:

  • Start Date
  • End Date (or Expected End Date)
  • Owner
  • Status (Not Started / In Progress / Complete)

Time required: 15 minutes for template setup

Auto-Calculate Leading Indicators (20 minutes)

Use formulas to calculate your six metrics automatically. Here are the basic formulas:

Handoff Latency:
=NETWORKDAYS(B12, B13)
(End of Stage A to Start of Stage B, excluding weekends)

Parallelization Index:
=SUM(Overlapping_Days) / SUM(Total_Days)

Redline Iterations:
=COUNTA(Redline_Dates)
(Count each review cycle)

IRB First-Pass Rate:
=COUNTIF(Approval_Status,"First Pass") / COUNTA(Submissions)

Feasibility Completeness:
=COUNTA(Completed_Fields) / COUNTA(Required_Fields)

On-Time Probability:
=Weighted_Average_of_Above_Five_Metrics

Time required: 20 minutes (or instant with our template)

Display Only 6 KPI Tiles (5 minutes)

Create a dashboard view showing ONLY your six metrics. Hide the raw data on another sheet tab.

Your dashboard tab should show:

  • Metric name
  • Current value
  • Target benchmark
  • Status indicator (green/yellow/red)
  • Trend arrow (improving/declining)

Everything else (detailed stage dates, task lists, notes) goes on supporting tabs. The dashboard is for decisions, not data entry.

Time required: 5 minutes

Set Weekly Review Rhythm (5 minutes)

Every Monday at 9:00 AM, review the dashboard. Takes 10 minutes once you have the habit.

Review agenda:

  1. Check on-time probability for each active study (2 min)
  2. Identify any metric in red or yellow (3 min)
  3. Assign action items to fix bottlenecks (3 min)
  4. Update expected activation dates if needed (2 min)

Block the time on your calendar. Make it recurring. Invite metric owners. Don’t skip it.

Time required: 5 minutes (calendar setup), 10 minutes per week (ongoing review)

Replace with Image 5: Realistic Dashboard UI Mockup (Optional)

Skip the Setup. Use Our Template.

Pre-built dashboard with all 6 metrics, formulas, and benchmarks. Works in Excel and Google Sheets. Just add your study data and go.

Download Free Dashboard Template

Common Dashboard Mistakes to Avoid

Building a dashboard is easy. Building one your team actually uses? That takes discipline. Here are the mistakes that kill adoption.

Mistake #1: Tracking Too Many KPIs

❌ The Mistake

Tracking 20+ KPIs because “more data = better insight.”

Result: Analysis paralysis. Nobody looks at it because it’s overwhelming.

✅ The Fix

Limit to 6 leading indicators that predict 90% of delays.

Result: Your team reviews it every week because it’s manageable.

💡 Why It Works

Cognitive load matters. Six metrics fit on one screen. Twenty metrics require scrolling, which means they don’t get reviewed.

Mistake #2: No SLA or Target Benchmarks

❌ The Mistake

Showing numbers without context. “Handoff latency is 4.2 days.” Okay… is that good?

✅ The Fix

Set target benchmarks for each metric with color-coded status.

≤2 days = green, 2.1-4 days = yellow, 4+ days = red.

💡 Why It Works

People need to know “am I winning or losing?” Benchmarks answer that instantly.

Mistake #3: No Clear Owner Per Metric

❌ The Mistake

Assigning metrics to departments. “Contracts team owns redlines.” Which person?

✅ The Fix

Assign names, not departments. “Sarah Johnson owns redline iterations.”

💡 Why It Works

When everyone is responsible, no one is responsible. Names create accountability.

Mistake #4: Only Tracking Lagging Indicators

Most dashboards show what already happened: “IRB approved on 3/15.” That’s useful for documentation, not for preventing delays.

The fix: Add leading indicators like handoff latency and parallelization that predict delays before they compound.

Mistake #5: Manual Updates Once a Week

If updating the dashboard takes 45 minutes every Friday, it won’t last. People will skip it when they’re busy, which is exactly when you need it most.

The fix: Use formulas or automation so the dashboard updates when you enter stage dates. If you’re using a system like TrialConnx, it happens automatically.

Mistake #6: Confusing Color Scheme

Random colors confuse people. Blue for good, red for bad, green for… medium? Nobody knows what they’re looking at.

The fix: Stick to a consistent scheme. Green = on target, yellow = needs attention, red = critical. Use brand colors where appropriate (purple for emphasis, not status).

Frequently Asked Questions

What is the minimal number of metrics for study startup dashboards?

Six metrics: handoff latency, parallelization index, redline iterations, IRB first-pass rate, feasibility completeness, and on-time startup probability. These six leading indicators predict approximately 90% of study startup delays without overwhelming your team with data. Anything more creates noise; anything less misses critical signals.

How do you calculate handoff latency?

Subtract the start date of Stage B from the end date of Stage A. For example, if contracts close on March 15 and regulatory starts on March 18, handoff latency is 3 days. Use business days (exclude weekends) for more accurate measurement. Target benchmark: ≤2 business days between stages.

Why is the parallelization index important for sites?

It measures how much work happens simultaneously instead of sequentially. Sites with a parallelization index ≥0.35 complete study startup 15-20 days faster on average because they don’t wait for one task to finish before starting another. Most sites work sequentially by habit, not necessity. This metric exposes that inefficiency.

What’s a good IRB first-pass approval rate?

75% or higher. Sites achieving 75%+ first-pass approval save 14-21 days per study compared to sites requiring multiple revision cycles. It’s a quality indicator for submission readiness. If your rate is below 75%, look at what high performers do differently. Often it’s as simple as using a pre-submission checklist.

How do I know if my study startup is on track?

Check your on-time startup probability score (calculated from the five other metrics plus current stage progress). If it’s ≥70%, you’re likely on track. Between 60-69%? Monitor closely and address yellow flags. Below 60%? Escalate immediately and identify the bottleneck before it causes cascading delays.

Can I use this dashboard if I’m juggling multiple studies at once?

Yes, that’s exactly when you need it most. Track each study as a separate row in your dashboard. The 6-metric structure keeps it manageable even with 10-15 concurrent studies. Update weekly per study. The key: don’t track more than six metrics per study, even if you’re tracking many studies simultaneously.

What if my site doesn’t have control over some metrics (like sponsor response time)?

Track them anyway. Even if you can’t control sponsor delays, measuring them gives you data to escalate effectively. Measuring sponsor delays helps you learn which sponsors are fast and which are slow, valuable for future study selection.

How long does it take to see improvement after implementing this dashboard?

Most sites see measurable improvement within 4-6 weeks. You’ll identify your biggest bottleneck in week one, implement a fix in week two, and start seeing results by week four. The academic medical center case study took six months to achieve full results, but they saw handoff latency drop within three weeks of implementing formal handoff protocols.

Next Steps: Implement This Month

Don’t wait for the perfect time. Start this week. Here’s your four-week implementation plan.

Week 1: Setup (60 minutes total)

  • Download template (2 min)
  • Map your study stages (10 min)
  • Assign metric owners: use names, not departments (5 min)
  • Enter your current active studies with stage dates (30 min)
  • Calculate baseline metrics (5 min; the formulas do this automatically)
  • Schedule recurring Monday 9 AM dashboard review (3 min)

Week 2: Baseline & Diagnosis (45 minutes)

  • Review current metrics for all active studies (15 min)
  • Compare to target benchmarks (10 min)
  • Identify your biggest gap (Which metric is furthest from target?) (10 min)
  • Conduct root cause discussion with metric owner (10 min)

Week 3: Optimize One Metric (varies)

  • Pick ONE metric to improve (the one with biggest impact)
  • Implement ONE specific change:
    • Handoff latency too high? Create formal handoff protocol with 2-day SLA
    • Parallelization too low? Identify 2-3 tasks that can run concurrently
    • IRB first-pass rate low? Implement pre-submission checklist
    • Redlines too many? Create contract template with pre-approved language
  • Communicate the change to your team
  • Track daily progress on that metric

Week 4: Review & Iterate (30 minutes)

  • Measure improvement in your targeted metric (10 min)
  • Share results with team in Monday meeting (5 min)
  • Celebrate the win (even small improvements matter) (5 min)
  • Pick the next metric to optimize (5 min)
  • Document what worked in your template’s notes tab (5 min)

That’s it. Four weeks. One metric at a time. Real improvement, not perfection.

Want This Built Into Your Workflow?

TrialConnx automatically tracks these 6 metrics (and more) across all your studies. No spreadsheets. No manual entry. Just real-time visibility into study startup performance so you can focus on activation, not administration.

See how sites using TrialConnx are hitting the NCI’s 90-day gold standard more consistently than ever.

Book a 15-Minute Demo Download Free Dashboard Template

Sources & References

  1. Evaluating the impact of delayed study startup on accrual in cancer studies. PMC, 2024. Range of 78-313 days across NCI-designated cancer centers.
  2. A single center analysis of factors influencing study start-up timeline in clinical trials. PMC, 2017. Median activation time of 140.5 days for studies meeting 70% activation threshold.
  3. Clinical Trial Delays: Key Challenges from Phase I to III. IntuitionLabs, 2024. Over 85% of clinical trials face delays.
  4. Why Time Is The Most Expensive Resource In Clinical Trials. LeapCure, 2024. Phase III delay costs of $36,000 per day.
  5. Overcoming Study Start-Up Delays: Best Practices for Research Sites. ACRP, 2025. NCI’s 90-day “time to activation” gold standard.
  6. Streamlining and cycle time reduction of the startup phase of clinical trials. PMC, 2020. 2018 AACI benchmarking survey data showing 167-day median.
  7. Optimizing Site Activation To Accelerate Clinical Trials. Clinical Leader, 2024. Academic centers at 8.12 months vs independent sites at 4.37 months.
  8. Time Required for Institutional Review Board Review. PMC, 2015 & IRB Review Times. Boston University, 2025. IRB review time ranges and expedited review timelines.

All statistics and benchmarks cited represent industry averages and published research data. Individual site results may vary based on therapeutic area, institutional infrastructure, and study complexity.

The post The Minimal Viable Study Startup Dashboard – Only 6 Metrics You Need appeared first on TrialConnx.

]]>
